2026 Concrete and Asphalt Paving Program

The City of Yorkton will begin seasonal concrete and asphalt paving work in May 2026 as part of its annual infrastructure maintenance program. These improvements help enhance safety, maintain roadway and sidewalk conditions, and extend the life of City infrastructure.

Project schedule

  • Concrete Replacement Program: May–June 2026
  • Asphalt Paving Program: May–August 2026

Construction schedules are weather-dependent and may change based on site conditions and contractor availability.

Project details

  • Concrete Replacement Program
    Repair and replacement of sidewalks, curbs, and gutters, with priority given to areas with with sidewalk uplifts or trip hazards, as well as areas that align with current and future paving work.
  • Asphalt Paving Program
    Milling and resurfacing of selected road segments. During a mill and overlay, the top layer of worn asphalt is removed and replaced with new asphalt to improve the road surface and extend the life of the street.

Thank you for your patience as this work is completed. Seasonal construction can be inconvenient, but it plays an important role in keeping Yorkton’s roads, sidewalks and neighborhood infrastructure safe and reliable.

The City of Yorkton will begin seasonal concrete and asphalt paving work in May 2026 as part of its annual infrastructure maintenance program. These improvements help enhance safety, maintain roadway and sidewalk conditions, and extend the life of City infrastructure.

Project schedule

  • Concrete Replacement Program: May–June 2026
  • Asphalt Paving Program: May–August 2026

Construction schedules are weather-dependent and may change based on site conditions and contractor availability.

Project details

  • Concrete Replacement Program
    Repair and replacement of sidewalks, curbs, and gutters, with priority given to areas with with sidewalk uplifts or trip hazards, as well as areas that align with current and future paving work.
  • Asphalt Paving Program
    Milling and resurfacing of selected road segments. During a mill and overlay, the top layer of worn asphalt is removed and replaced with new asphalt to improve the road surface and extend the life of the street.

Thank you for your patience as this work is completed. Seasonal construction can be inconvenient, but it plays an important role in keeping Yorkton’s roads, sidewalks and neighborhood infrastructure safe and reliable.

  • July 27 - Schedule Update

    2026 Asphalt Paving Program

    • The project is approximately 10% completed.
    • Fedorowich Construction completed milling and paving on York Road East (Mayhew Ave to McBurney Drive).
      • July 27 - Milling and paving Collacott St W (Myrtle to Betts)
      • July 27 – Milling and July 28 paving - Collacott St E (Second to Third)
      • Henderson St W (Myrtle to First Ave N.) on July 28 milling – July 29th paving
      • Wellington Avenue (Catherine to Darlington) – milling July 29 and paving on July 30th .

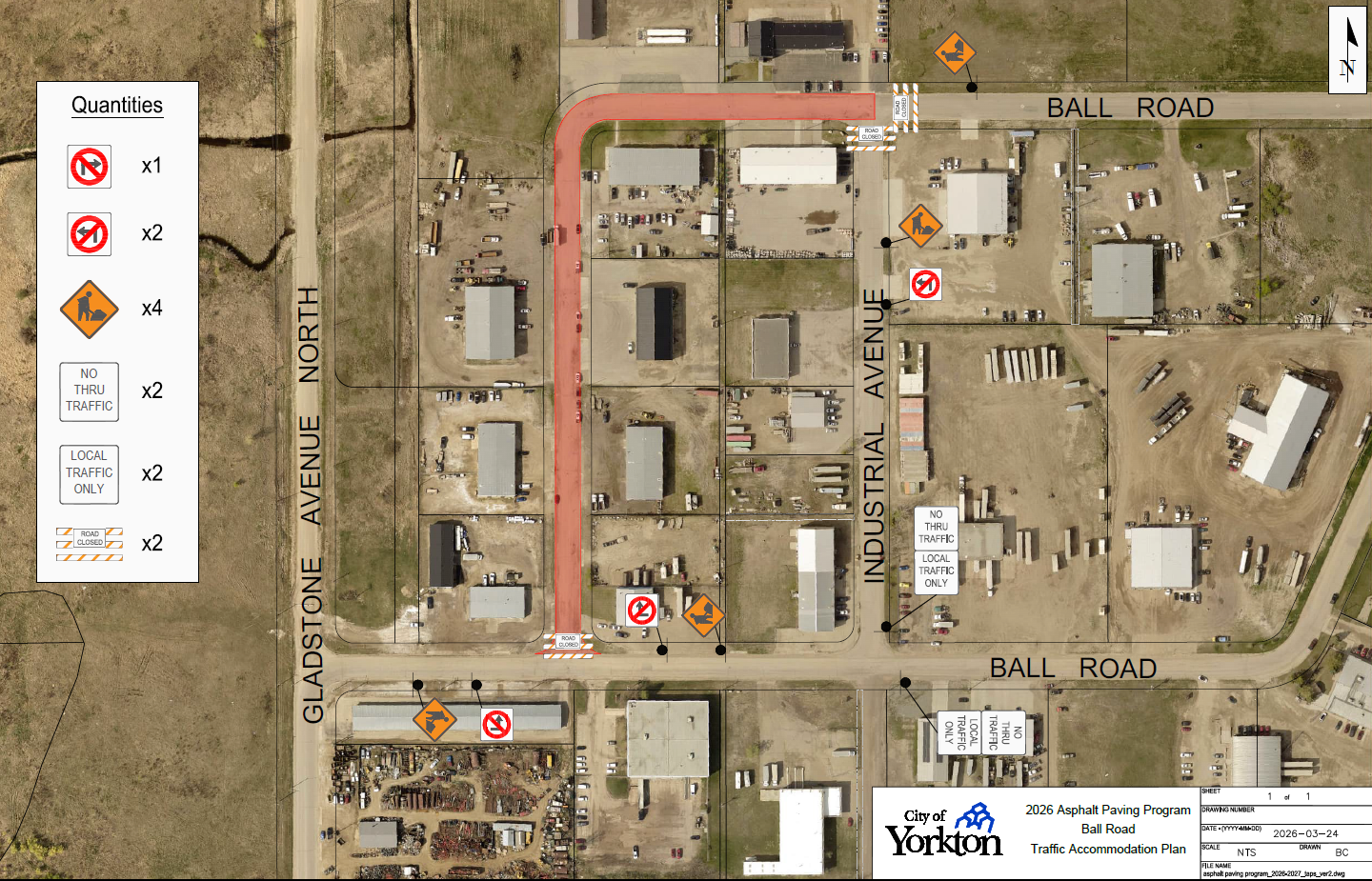

      • Ball Road is now tentatively August 13th to 16th. This location will no longer be split into two phases. Milling would be completed on August 13th and 14th, with paving on the 15th and 16th.

    2026 Asphalt Paving Program

    • The project is approximately 10% completed.
    • Fedorowich Construction completed milling and paving on York Road East (Mayhew Ave to McBurney Drive).
      • July 27 - Milling and paving Collacott St W (Myrtle to Betts)
      • July 27 – Milling and July 28 paving - Collacott St E (Second to Third)
      • Henderson St W (Myrtle to First Ave N.) on July 28 milling – July 29th paving
      • Wellington Avenue (Catherine to Darlington) – milling July 29 and paving on July 30th .
      • Ball Road is now tentatively August 13th to 16th. This location will no longer be split into two phases. Milling would be completed on August 13th and 14th, with paving on the 15th and 16th.
  • July 20, 2026 - Schedule Update

    The current 2026 Asphalt Paving Program schedule is as follows:

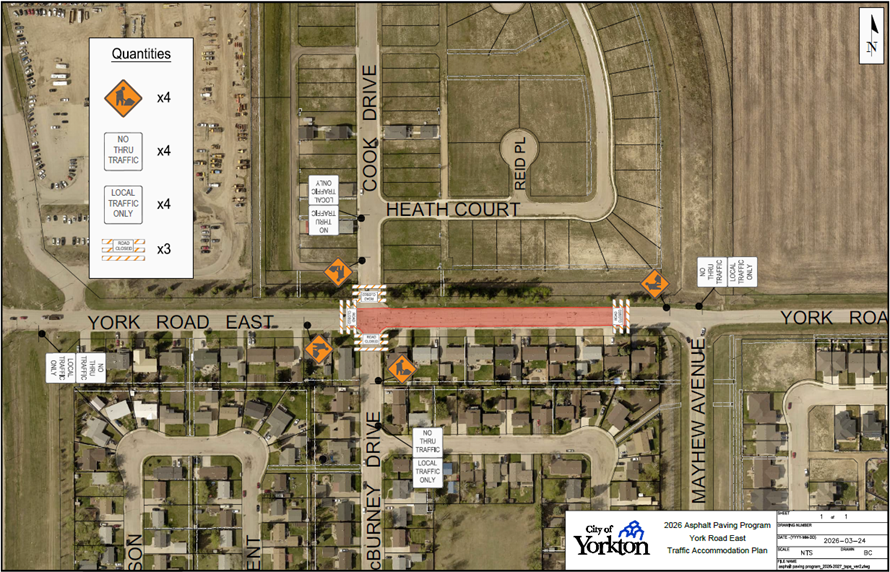

    • York Road (Mayhew to McBurney) on July 20-23.

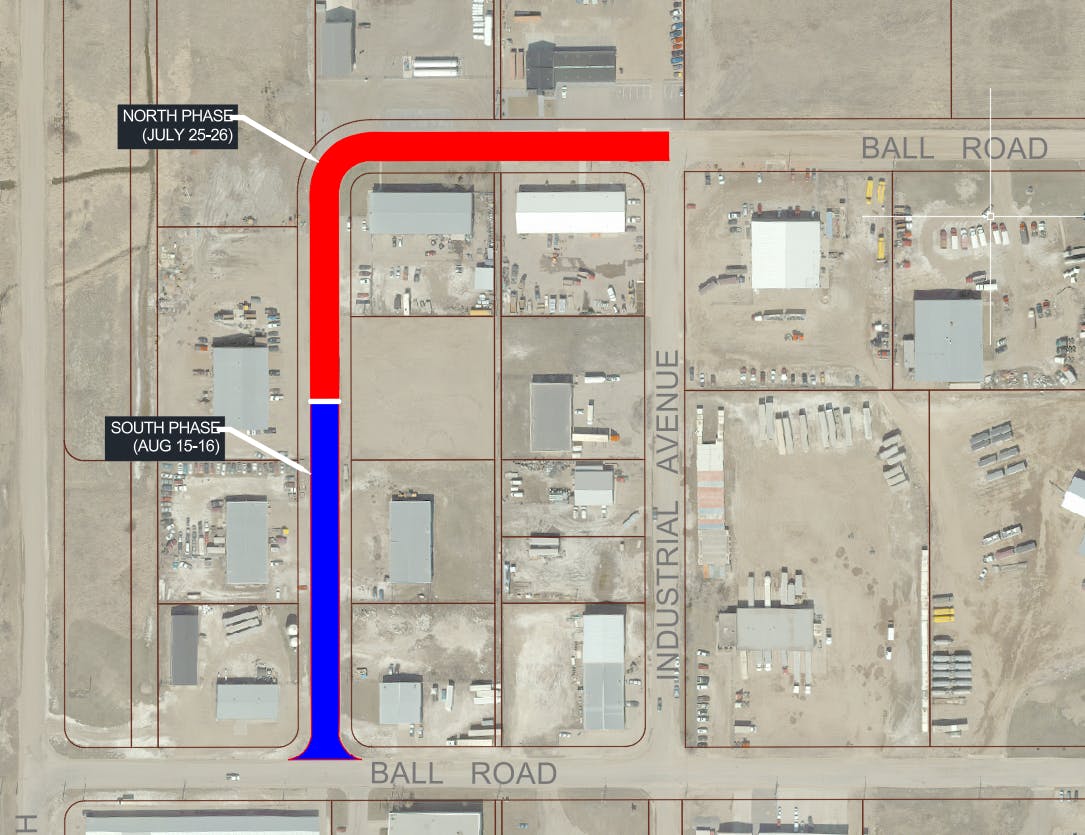

    • Ball Road (Industrial to Ball Rd) north phase on July 25-26. The south phase is tentatively scheduled for August 15-16.

    • Collacott St W (Myrtle to Betts) and Collacott St E (Second to Third) on July 27–28.

    • Henderson St W (Myrtle to Betts) on July 28-29.
    • Wellington Avenue (Catherine to Darlington) on July 29-30.

    Fedorowich noted that this schedule is weather-dependent and may change if any roadway subgrade issues are encountered.

    The current 2026 Asphalt Paving Program schedule is as follows:

    • York Road (Mayhew to McBurney) on July 20-23.
    • Ball Road (Industrial to Ball Rd) north phase on July 25-26. The south phase is tentatively scheduled for August 15-16.
    • Collacott St W (Myrtle to Betts) and Collacott St E (Second to Third) on July 27–28.
    • Henderson St W (Myrtle to Betts) on July 28-29.
    • Wellington Avenue (Catherine to Darlington) on July 29-30.

    Fedorowich noted that this schedule is weather-dependent and may change if any roadway subgrade issues are encountered.

  • July 13, 2026 - Schedule Update

    2026 Asphalt Paving Program

    • July 13th Fedorowich Construction is on schedule to begin on Lawrence Avenue on Monday (July 13th). Milling and paving are scheduled to take 3 days.

    • July 20th York Road (Mayhew Ave to McBurney Drive)
    • July 23rd – Ball Road
    • Collacot, Henderson and Dunlop to follow

    Please note this plan is weather depending.

    2026 Asphalt Paving Program

    • July 13th Fedorowich Construction is on schedule to begin on Lawrence Avenue on Monday (July 13th). Milling and paving are scheduled to take 3 days.
    • July 20th York Road (Mayhew Ave to McBurney Drive)
    • July 23rd – Ball Road
    • Collacot, Henderson and Dunlop to follow

    Please note this plan is weather depending.

  • June 15, 2026 - Update

    2026 Concrete Replacement Program

    • Northstar Concrete mobilized to Yorkton June 4th and began sawcutting and removals on York Road East (McBurney Drive to Mayhew Drive).
    • They will be working Monday to Friday and anticipate being in Yorkton for the next few months.
    • Removals will continue at multiple priority locations that overlap with the 2026 Asphalt Paving Program tomorrow.
    • The contractor returned to Yorkton on Monday, June 8th, and began replacements on York Road.

    2026 Asphalt Paving Program

    Fedorowich Construction plans to begin the mill and fill paving program June 30th.

    • June 30th - July 1st – Lawrence Avenue – service road /HW10 to Palliser Way
    • July 1stth – July 3rd - Yorkroad East – Mayhew Ave. to Cook Dr. / McBurney Dr.

    2026 Concrete Replacement Program

    • Northstar Concrete mobilized to Yorkton June 4th and began sawcutting and removals on York Road East (McBurney Drive to Mayhew Drive).
    • They will be working Monday to Friday and anticipate being in Yorkton for the next few months.
    • Removals will continue at multiple priority locations that overlap with the 2026 Asphalt Paving Program tomorrow.
    • The contractor returned to Yorkton on Monday, June 8th, and began replacements on York Road.

    2026 Asphalt Paving Program

    Fedorowich Construction plans to begin the mill and fill paving program June 30th.

    • June 30th - July 1st – Lawrence Avenue – service road /HW10 to Palliser Way
    • July 1stth – July 3rd - Yorkroad East – Mayhew Ave. to Cook Dr. / McBurney Dr.

  • June 4, 2026 - Sawcutting & Removals

    Sawcutting and removals begin June 4, 2026 at the following locations in order:

    • York Road East (Mayhew to McBurney
    • Henderson Street West (Betts to First)
    • Laurier Avenue ( Independent to Simpson)
    • Simpson Street (Laurier to Alley Crossing)
    • Fifth Avenue S (King St to End)
    • Betts Avenue ( Dunlop to Catherine)
    • Ball Road (small piece along the side of 164 Industrial)
    • Wellington Ave (193-197 Wellington)
    • Dunlop Street East (232 2nd Ave)
    • Duncan Street W (Myrtle to 1st)
    • 6th Ave N (small piece at 92 6th Ave)
    • Booth Street ( Maple to 124 Booth)

    Sawcutting and removals begin June 4, 2026 at the following locations in order:

    • York Road East (Mayhew to McBurney
    • Henderson Street West (Betts to First)
    • Laurier Avenue ( Independent to Simpson)
    • Simpson Street (Laurier to Alley Crossing)
    • Fifth Avenue S (King St to End)
    • Betts Avenue ( Dunlop to Catherine)
    • Ball Road (small piece along the side of 164 Industrial)
    • Wellington Ave (193-197 Wellington)
    • Dunlop Street East (232 2nd Ave)
    • Duncan Street W (Myrtle to 1st)
    • 6th Ave N (small piece at 92 6th Ave)
    • Booth Street ( Maple to 124 Booth)
