Kinsmen Arena Ice Systems Upgrades

The City of Yorkton is undertaking a renovation project at the Kinsmen Arena to extend the longevity of the ice systems for future years. Approved as part of the 2023, 2024, and 2025 capital budgets, this project will entail:

  • The removal of the existing rink system, including boards, glass, player benches, spectator seating, and the concrete arena floor.

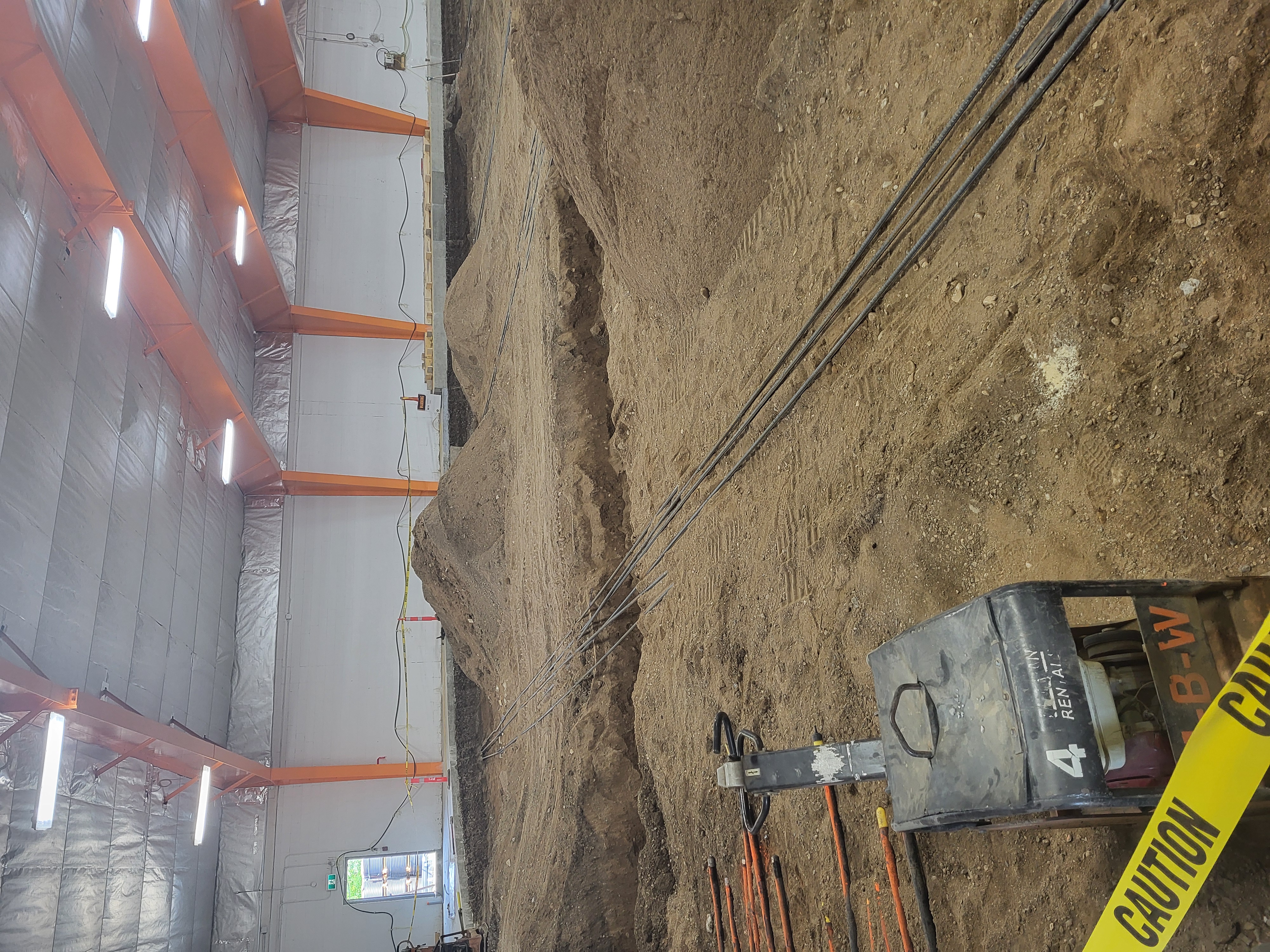

  • Removal and replacement of the ground soils, forming a strong, solid base for the new arena slab floor.
  • Installation of new rink systems, including the concrete arena floor (complete with new refrigeration piping), new rink boards, arena glass, player benches, spectator seating, and other arena amenities.
  • Installation of dehumidification for the arena

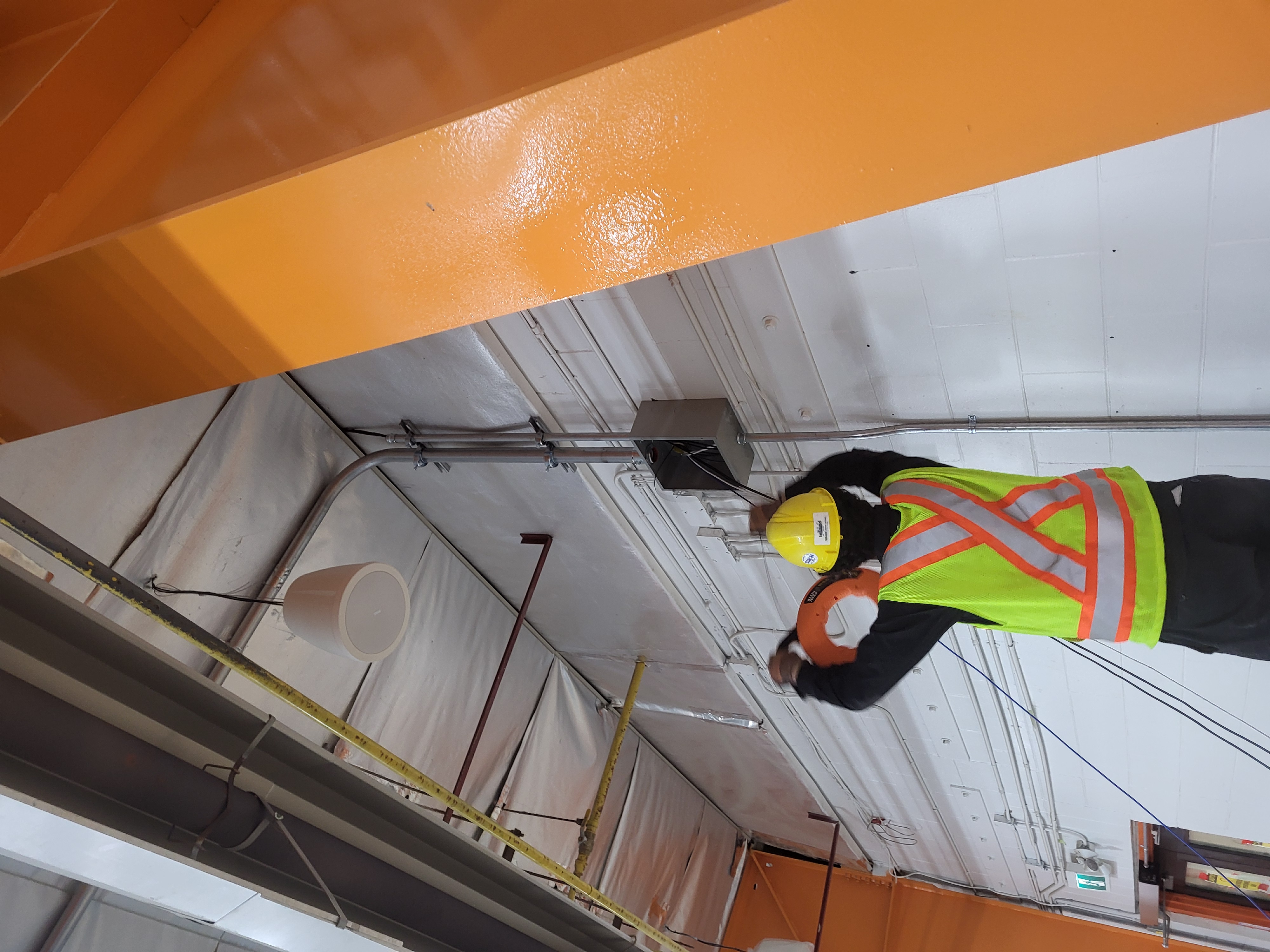

  • Code and ice plant upgrades

This project was approved and funding allocated following the Gallagher Centre Renewal Project, and in addition to the Westland Arena Ice Plant Upgrades Project, which was completed in 2023.

Subscribe to this project page to stay up to date on the work happening as part of the Kinsmen Arena Ice Systems Upgrades!

The City of Yorkton is undertaking a renovation project at the Kinsmen Arena to extend the longevity of the ice systems for future years. Approved as part of the 2023, 2024, and 2025 capital budgets, this project will entail:

  • The removal of the existing rink system, including boards, glass, player benches, spectator seating, and the concrete arena floor.
  • Removal and replacement of the ground soils, forming a strong, solid base for the new arena slab floor.
  • Installation of new rink systems, including the concrete arena floor (complete with new refrigeration piping), new rink boards, arena glass, player benches, spectator seating, and other arena amenities.
  • Installation of dehumidification for the arena
  • Code and ice plant upgrades

This project was approved and funding allocated following the Gallagher Centre Renewal Project, and in addition to the Westland Arena Ice Plant Upgrades Project, which was completed in 2023.

Subscribe to this project page to stay up to date on the work happening as part of the Kinsmen Arena Ice Systems Upgrades!

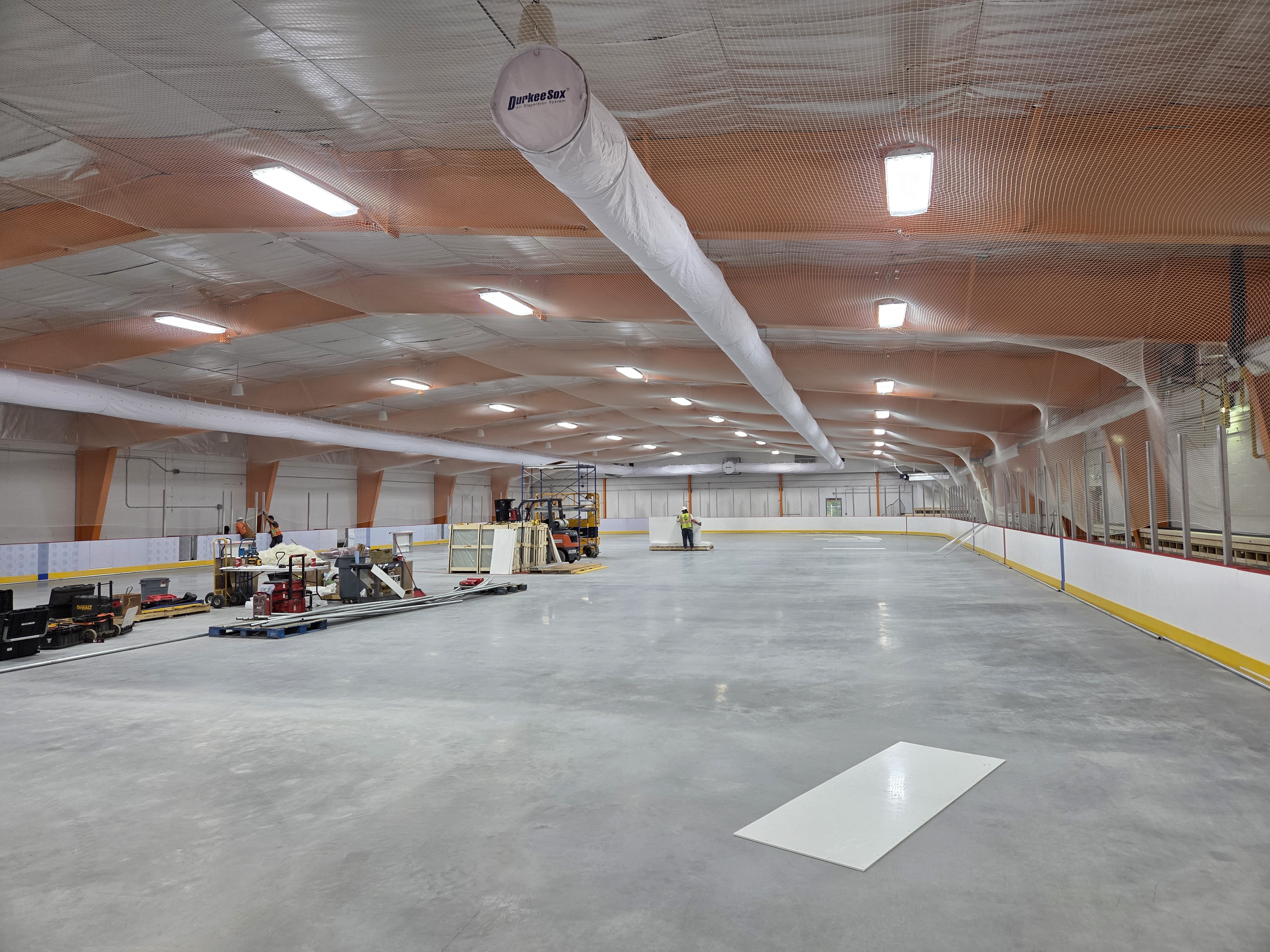

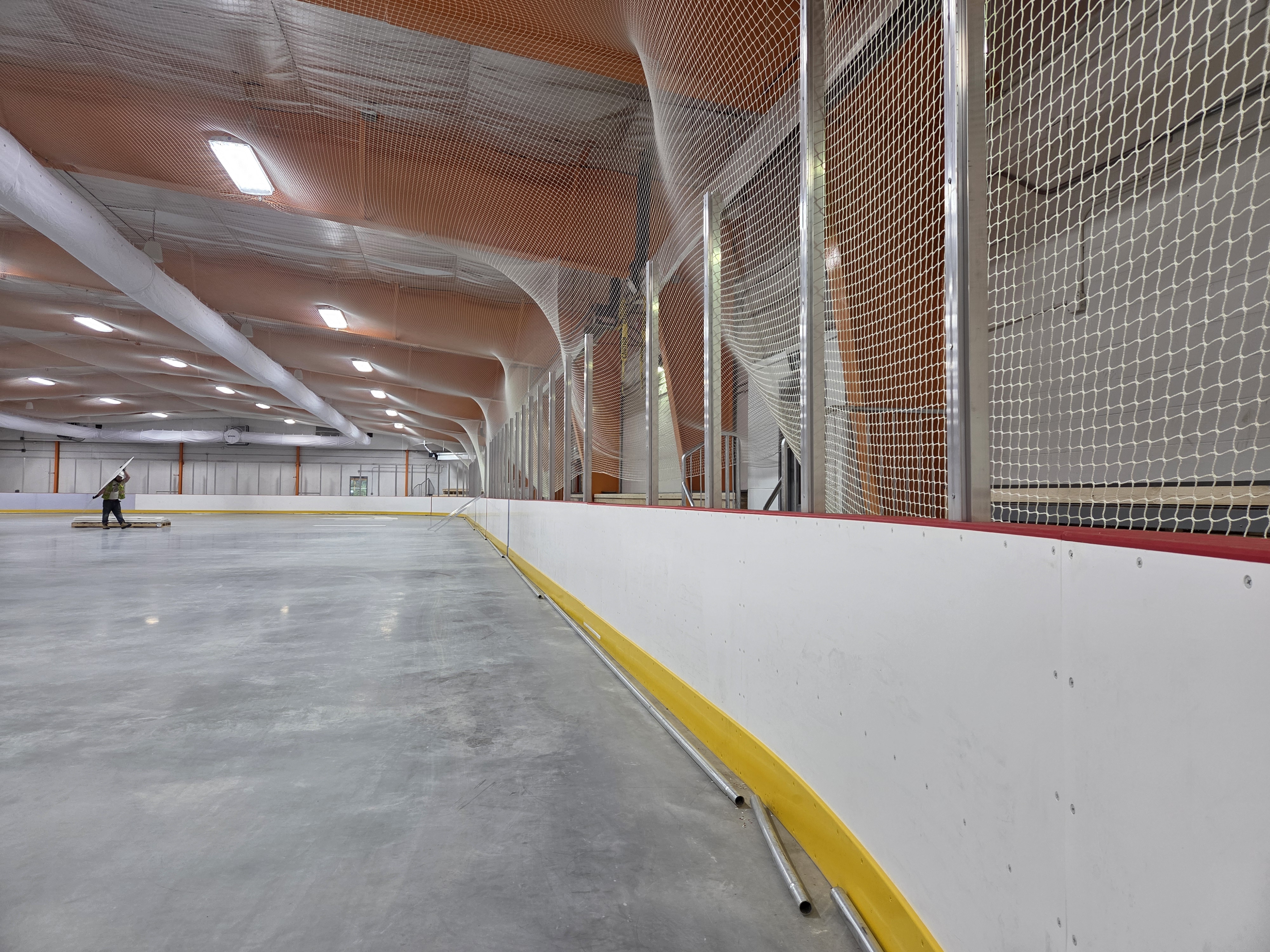

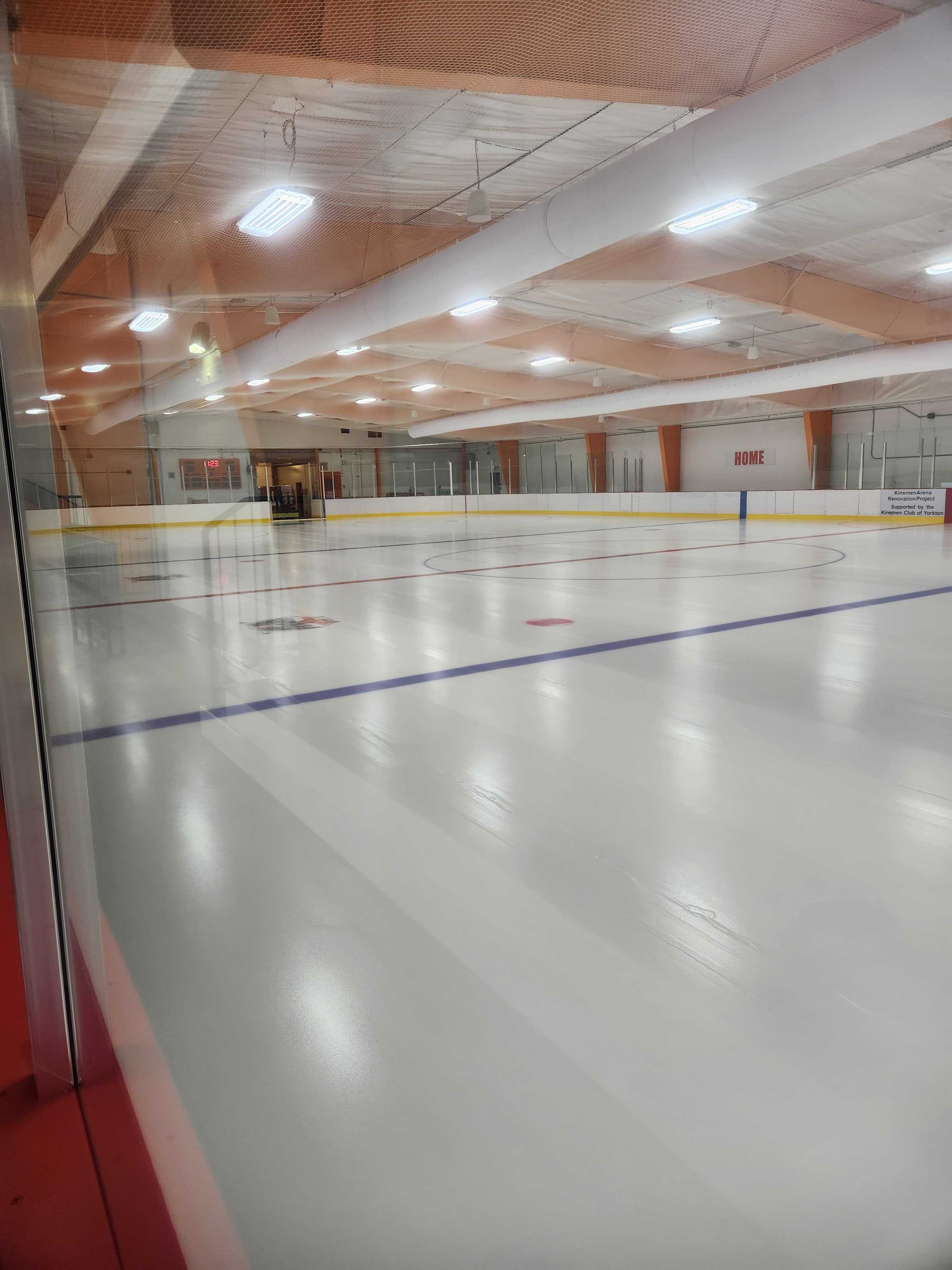

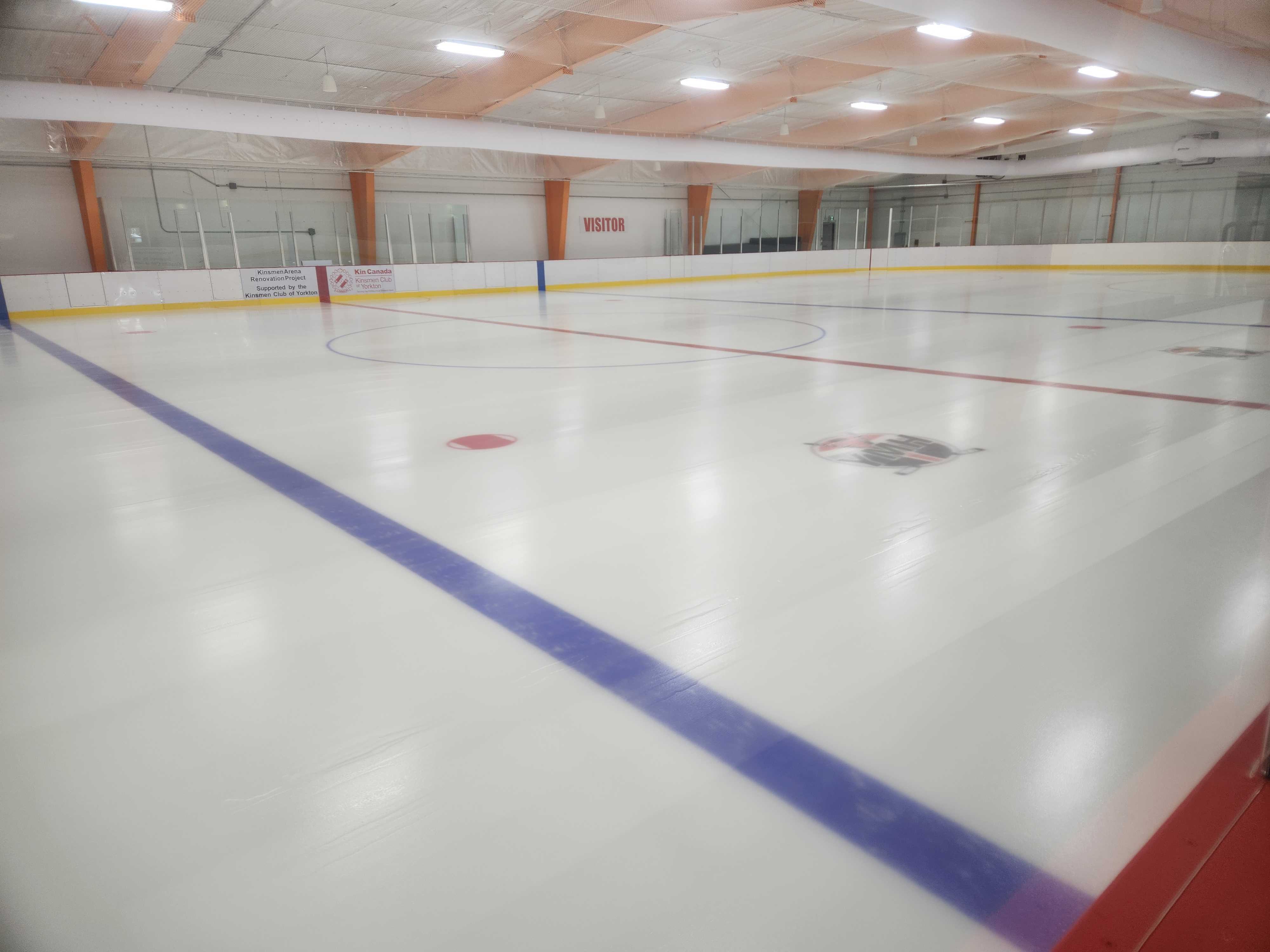

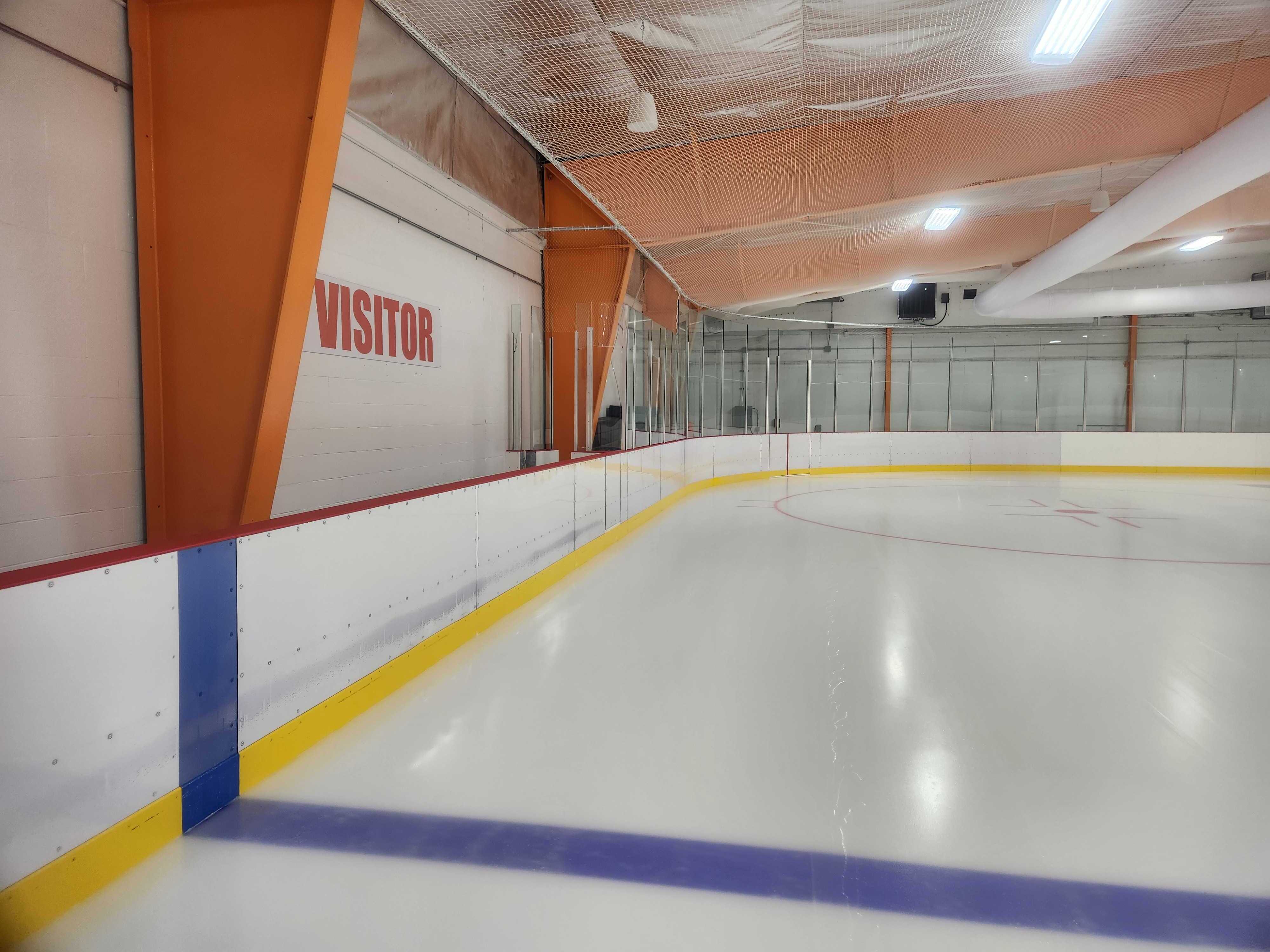

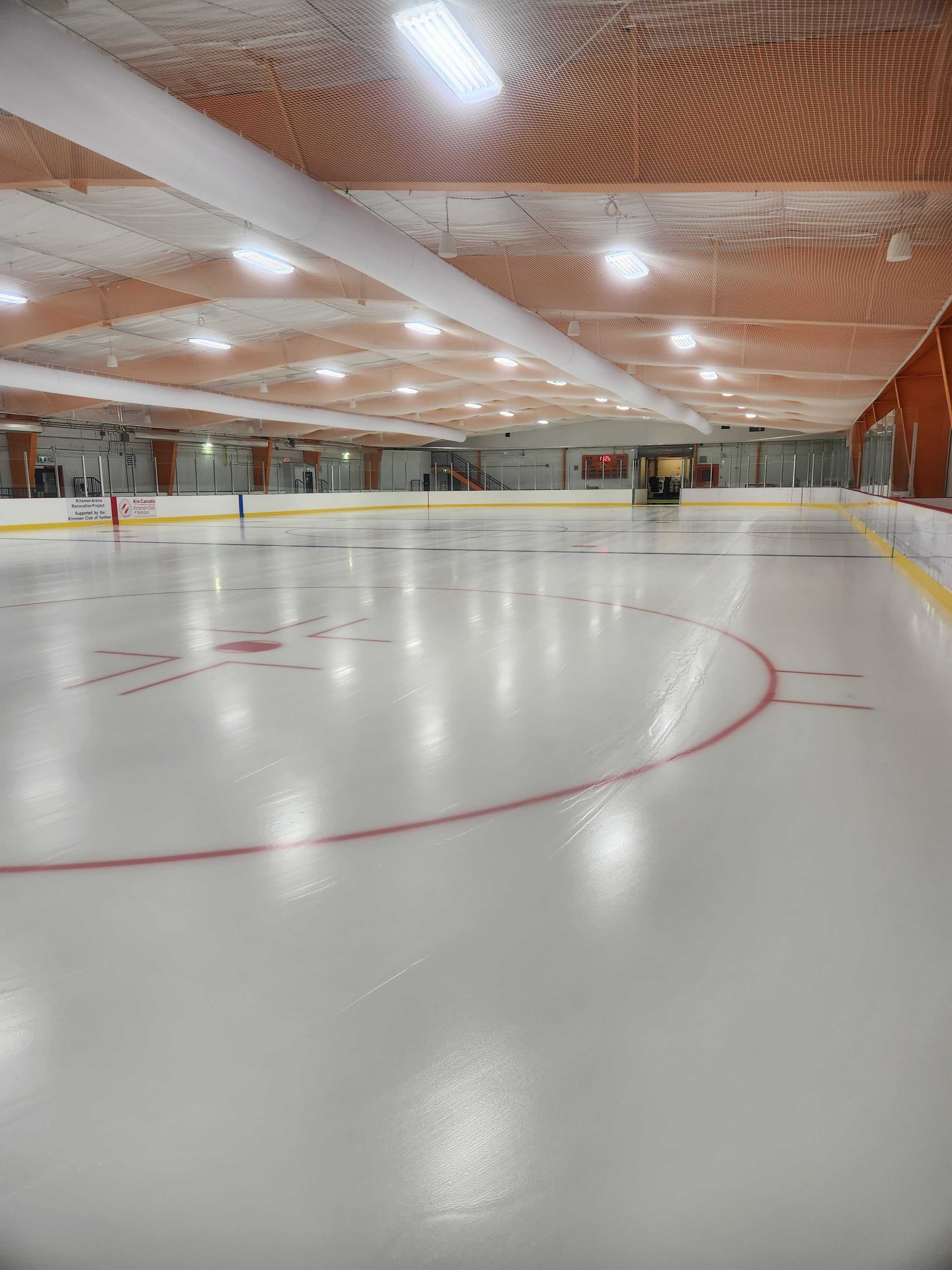

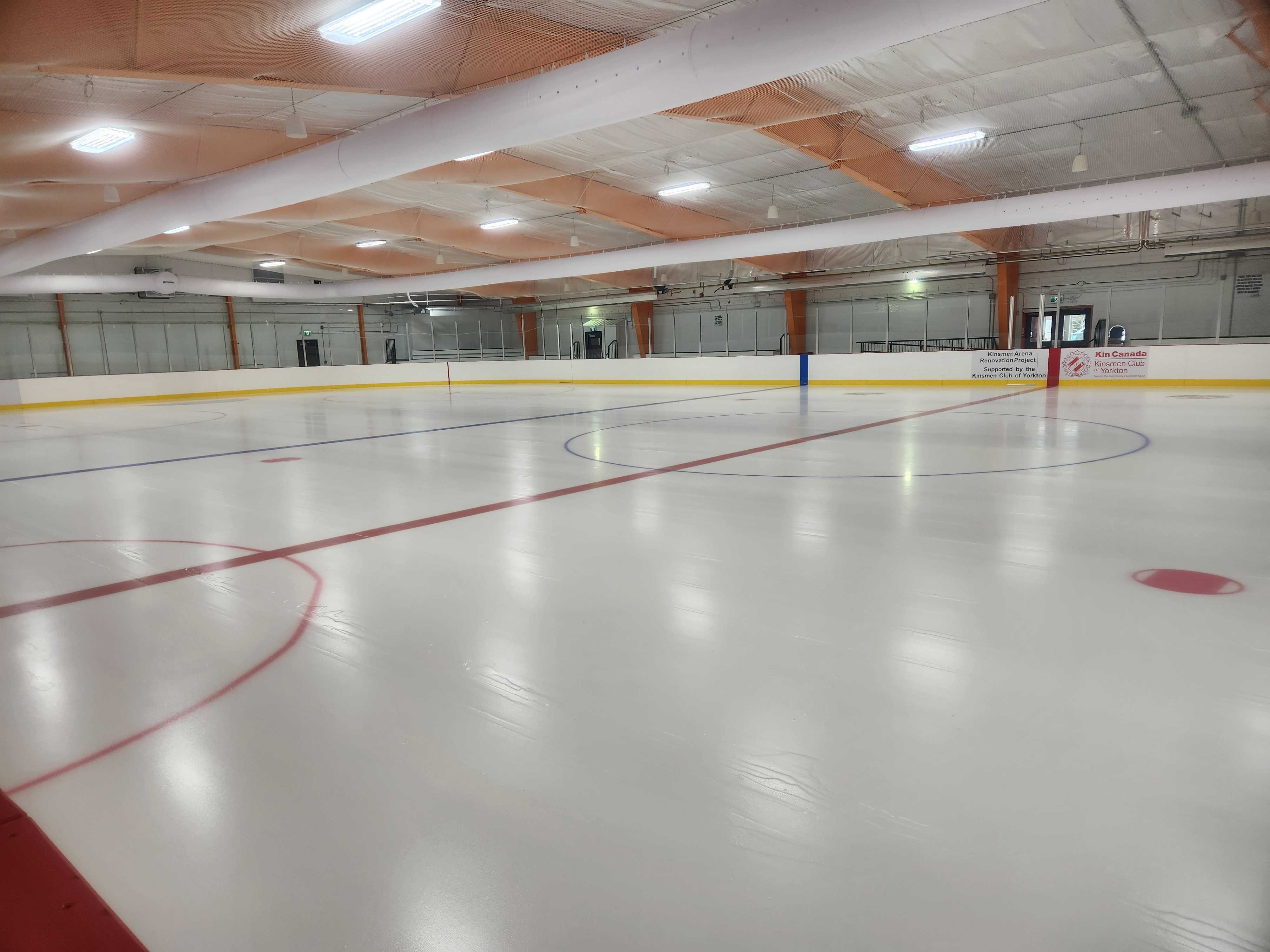

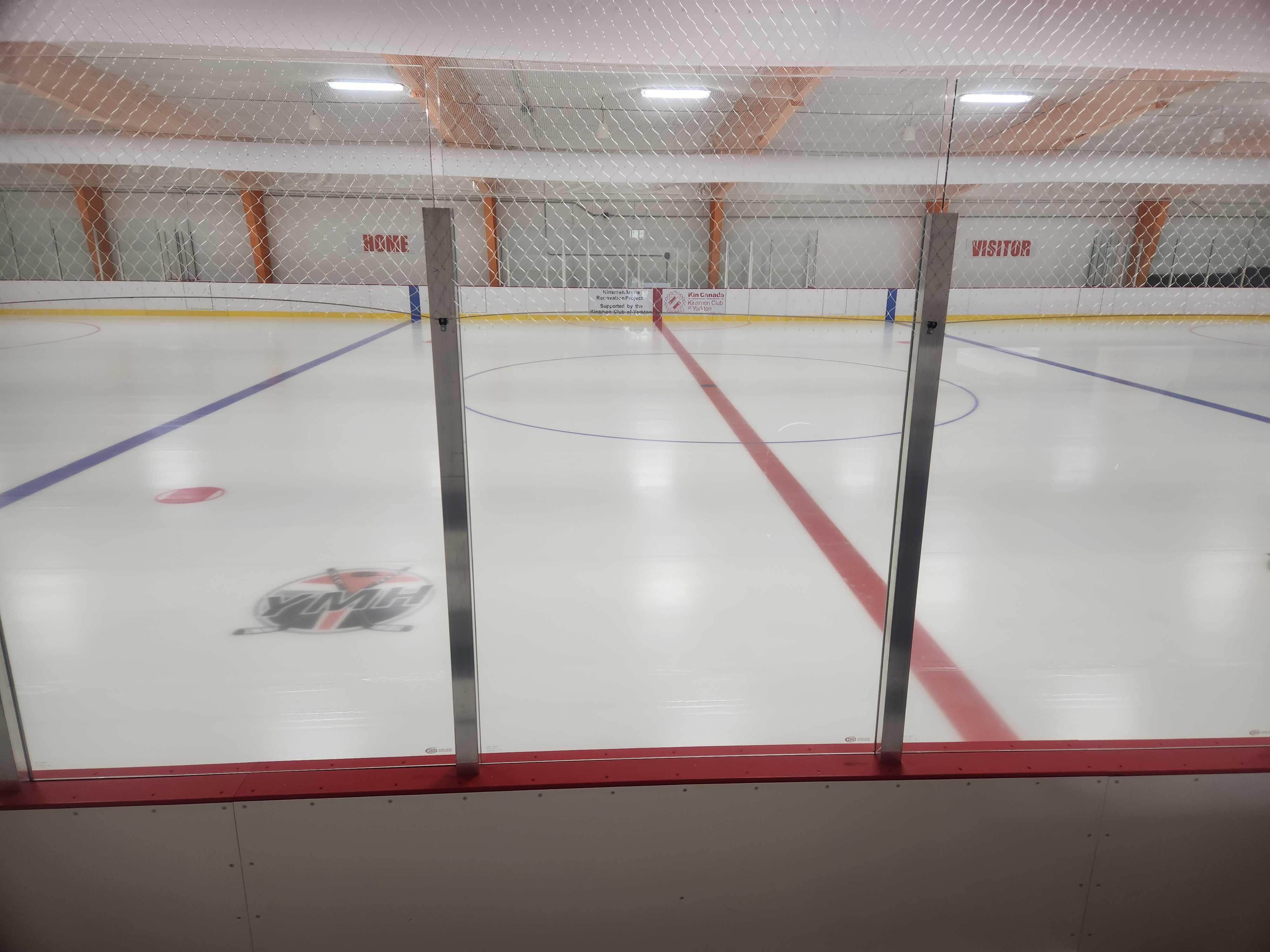

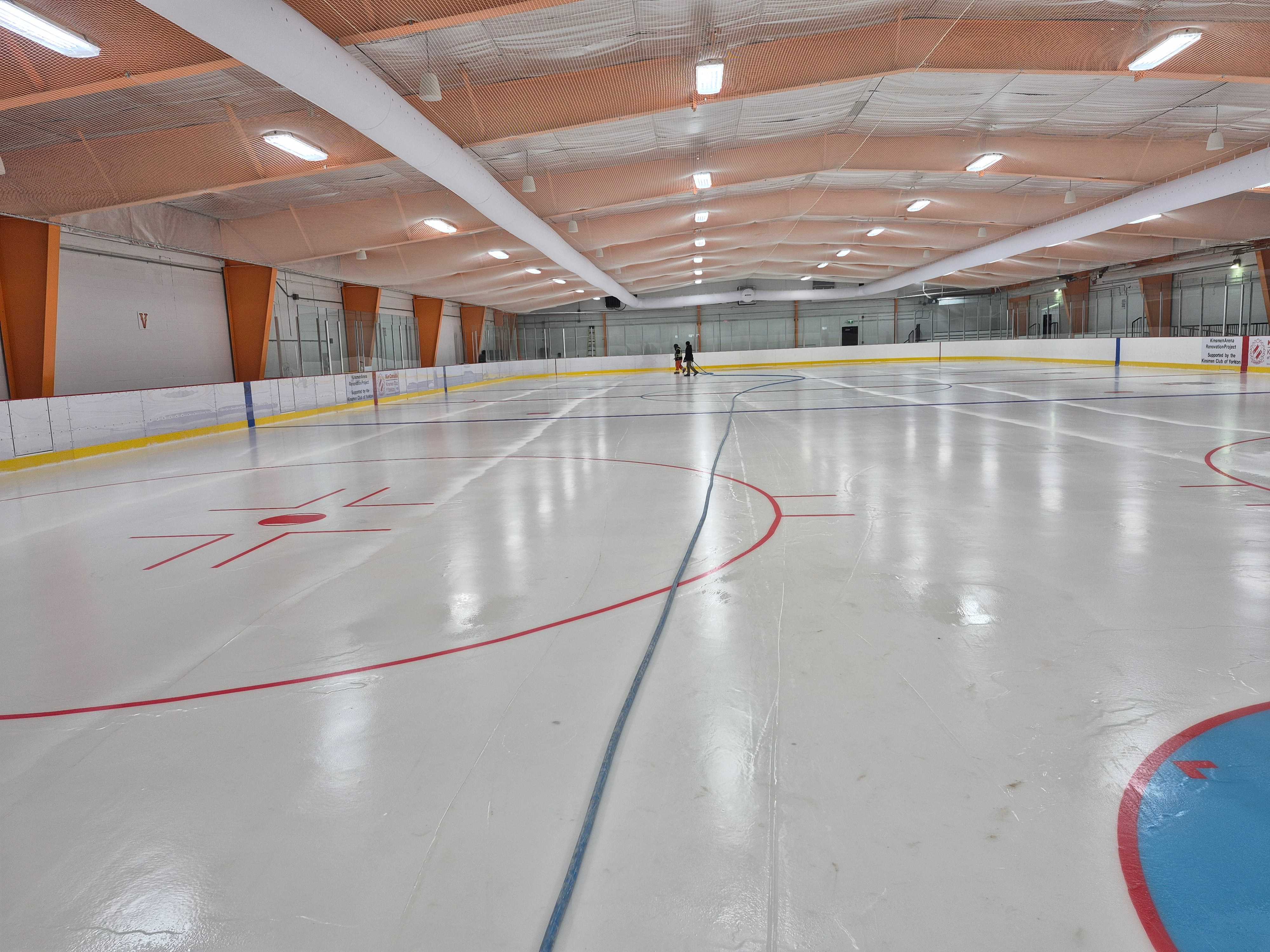

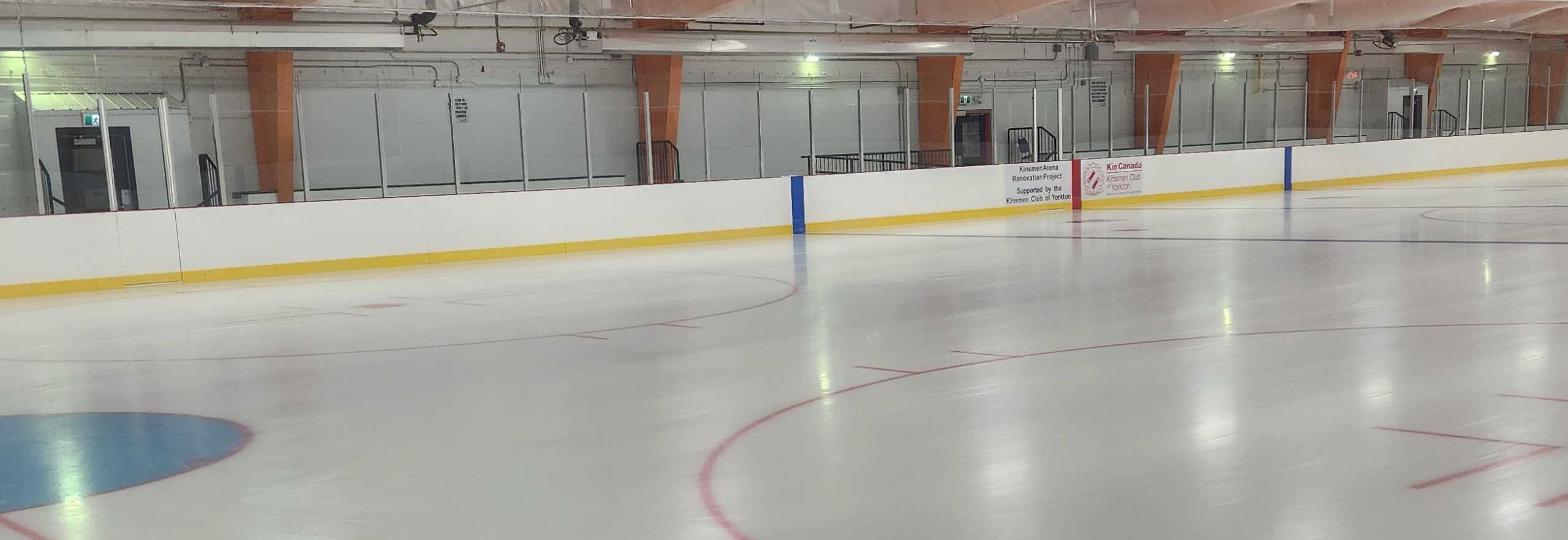

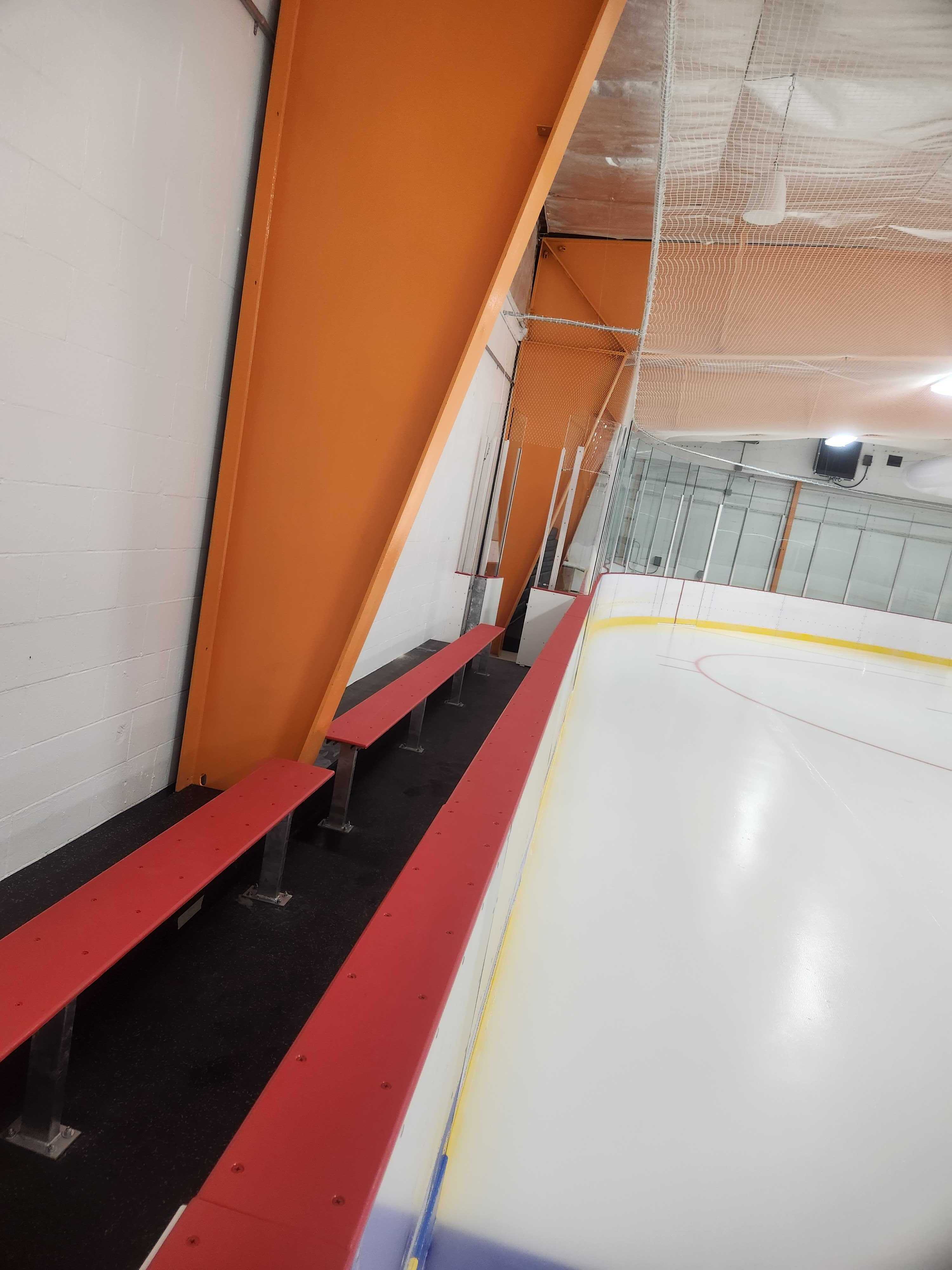

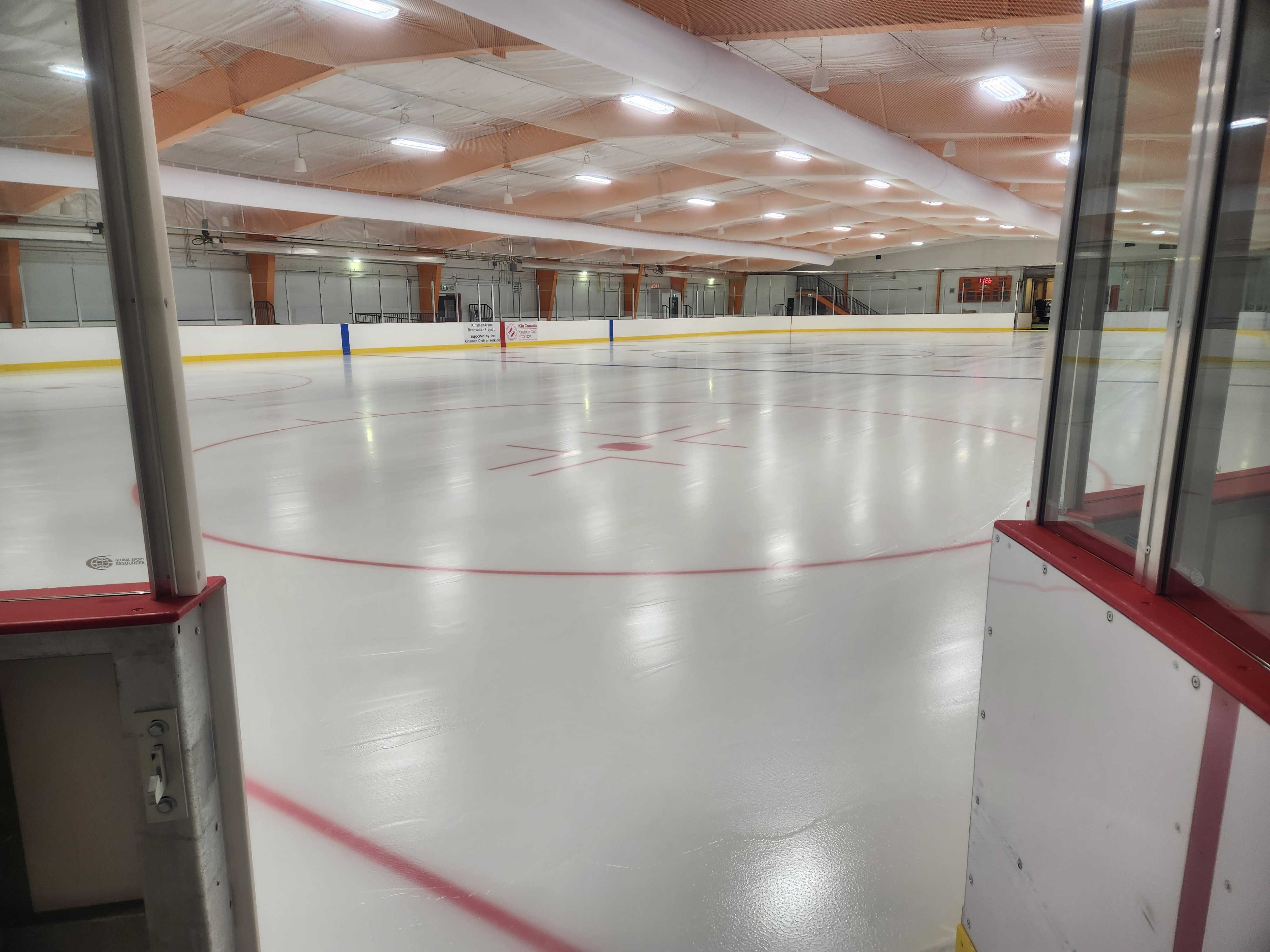

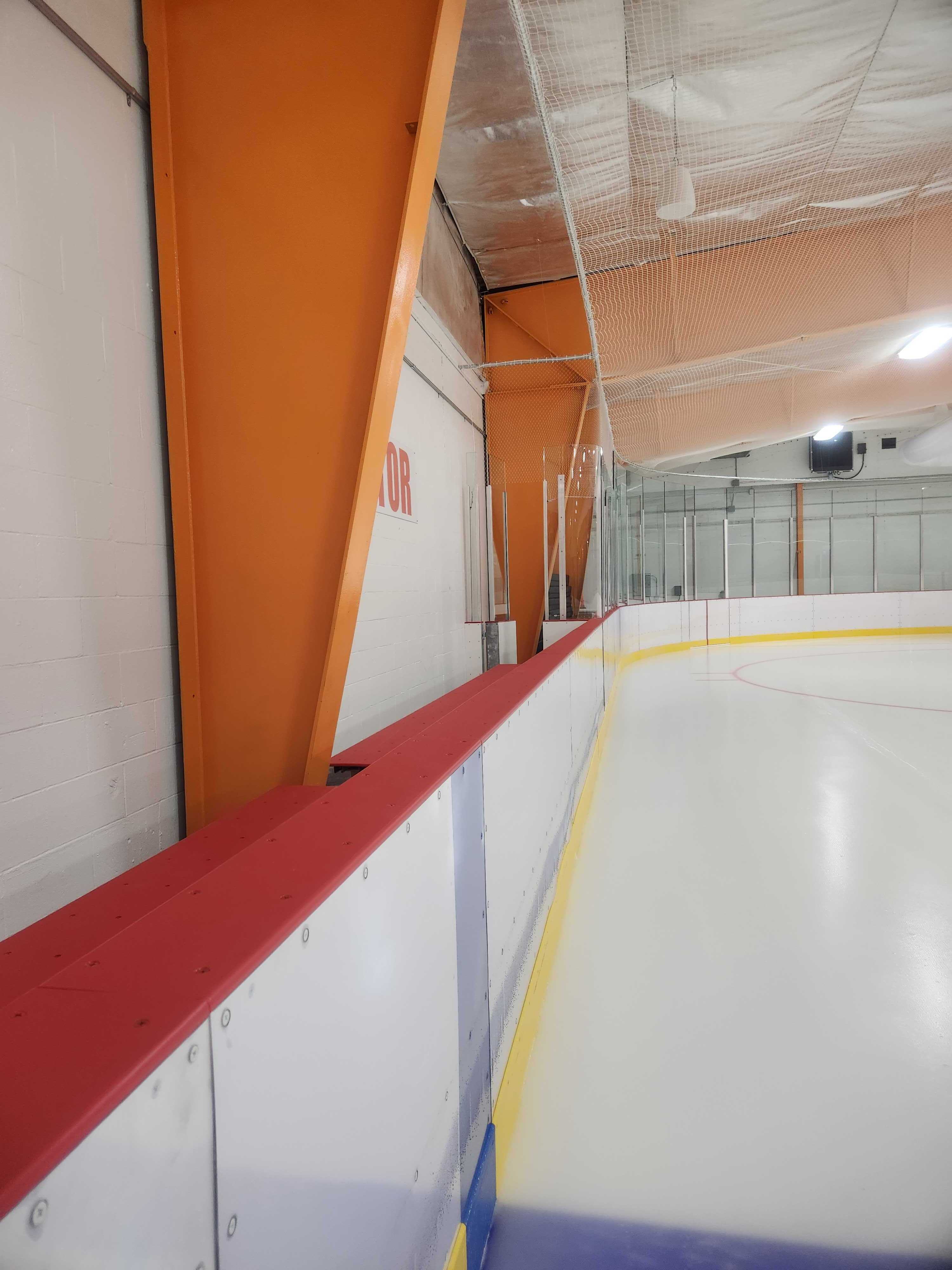

  • Looking Like a Rink

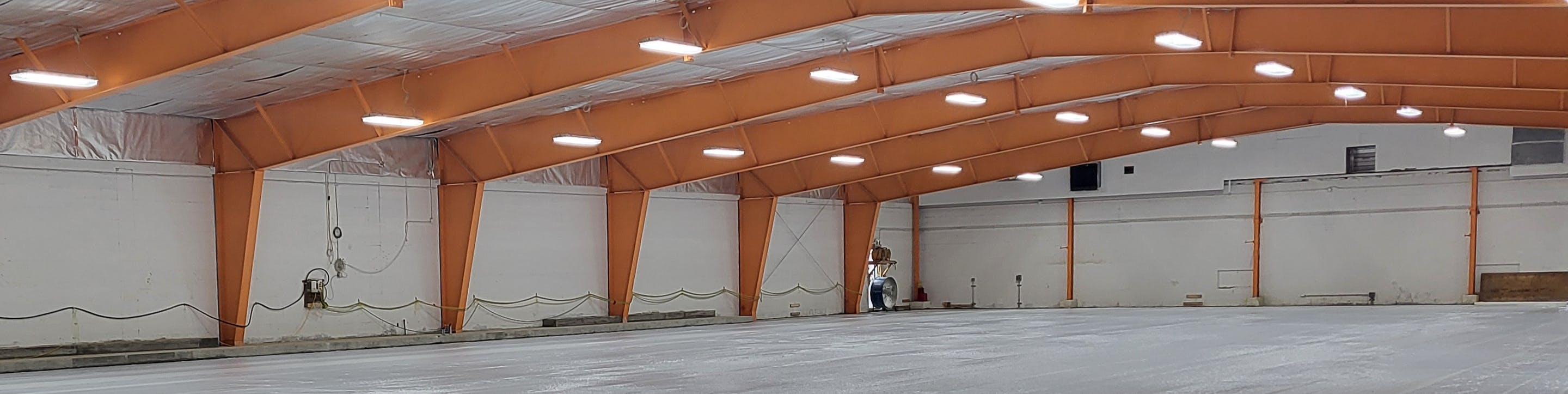

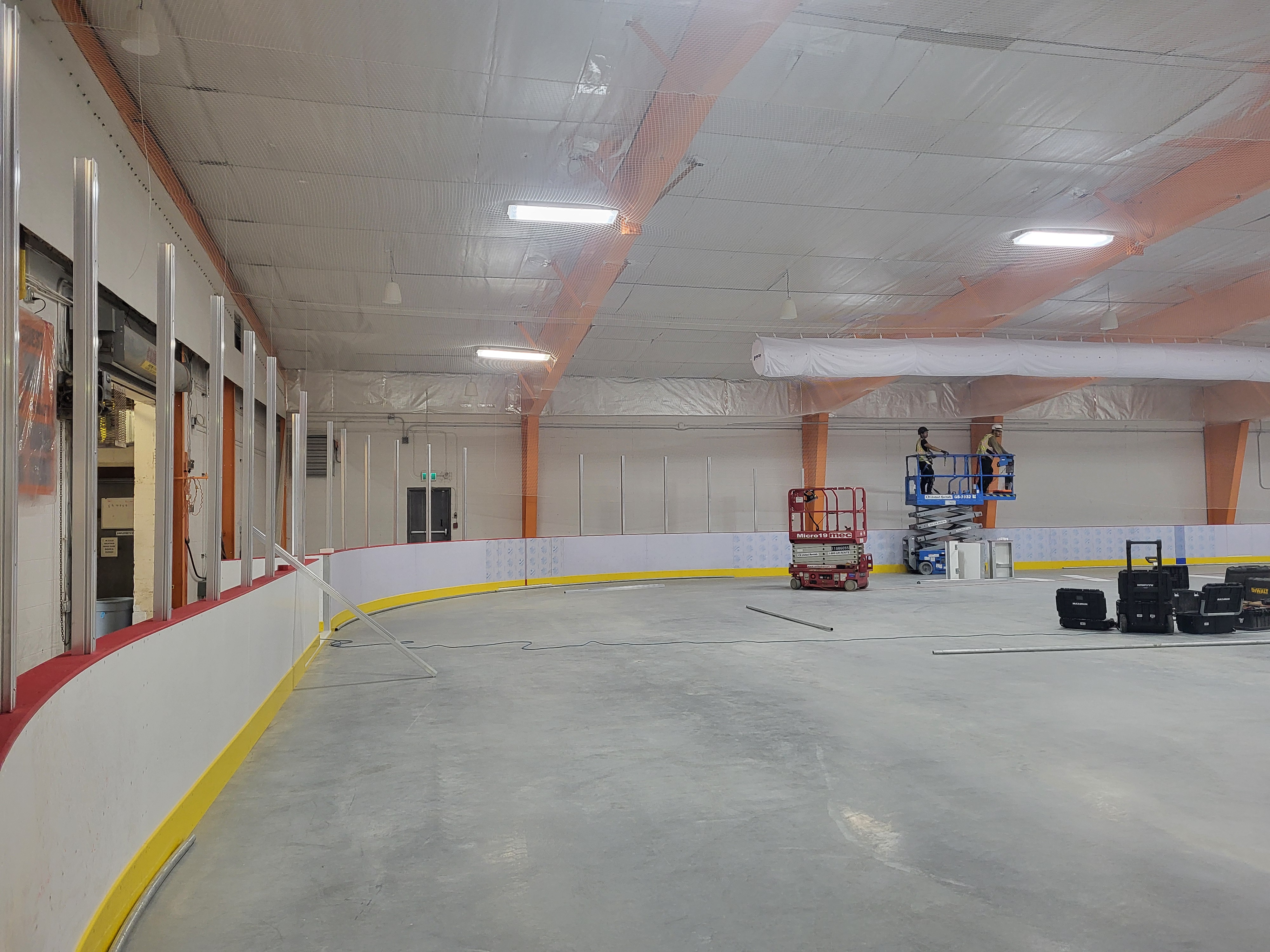

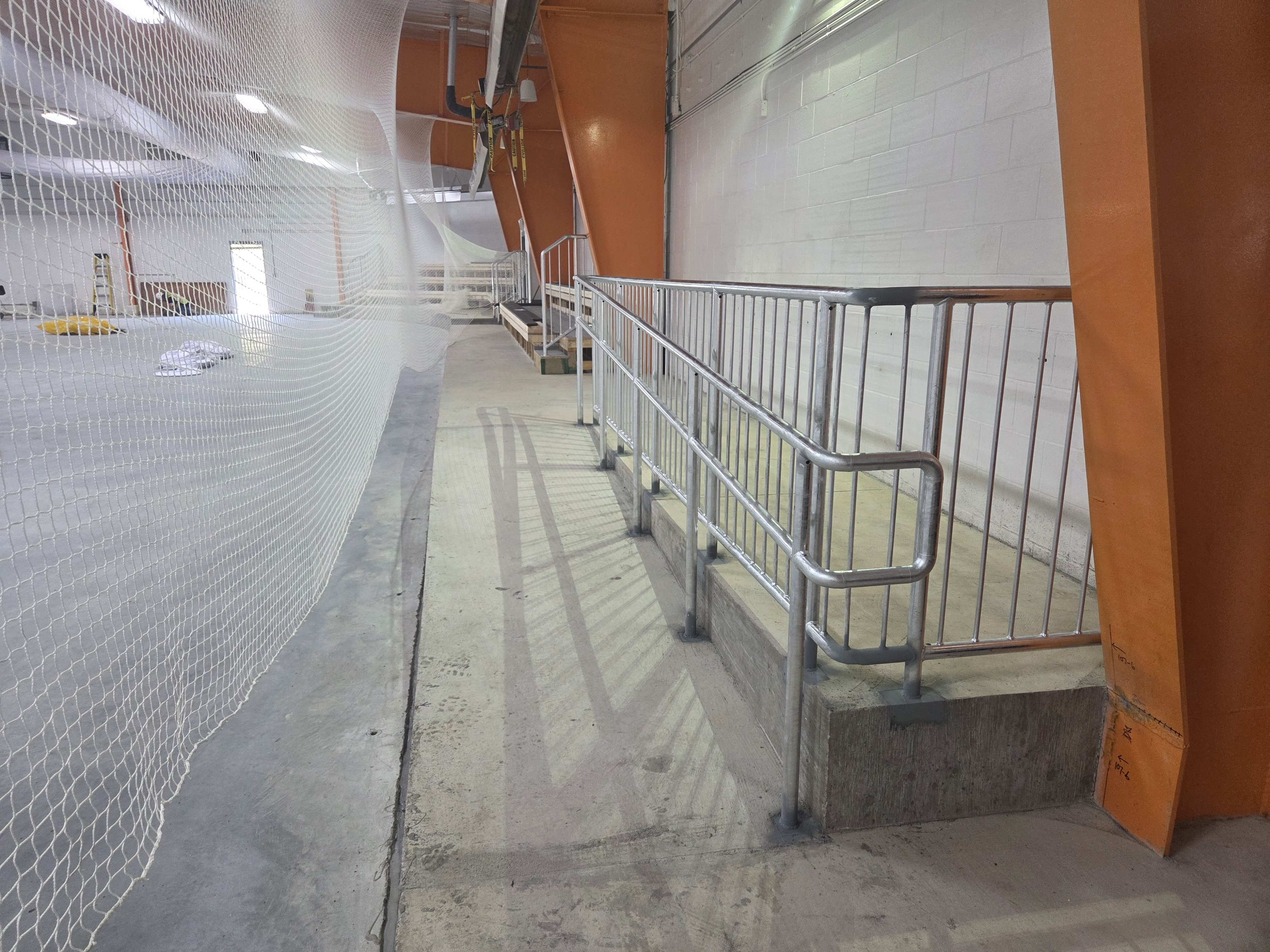

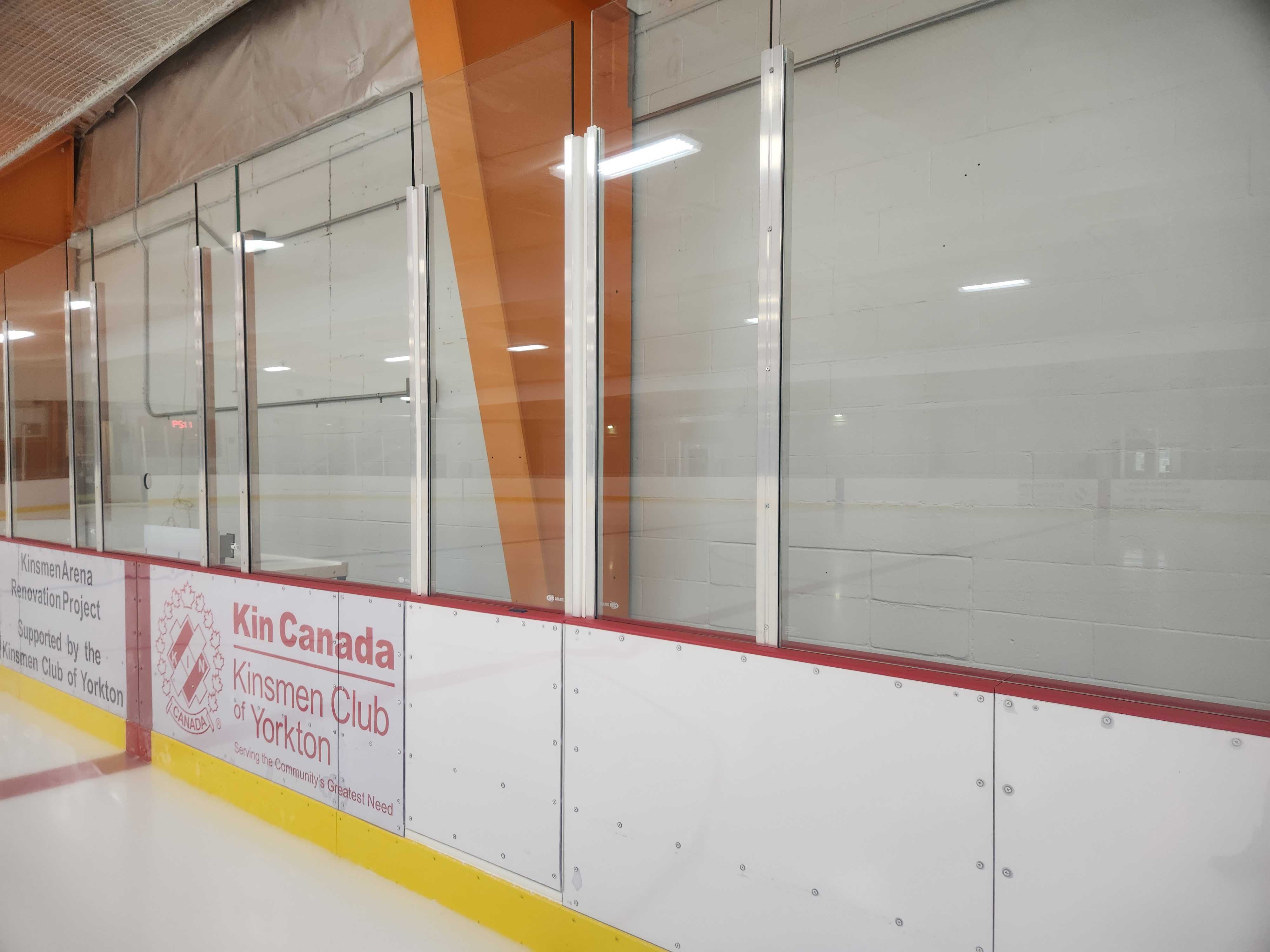

    It's been a very busy few days at the Kinsmen Arena! Start late last week the new arena boards began installation. This requires drilling into the arena floor and mounting each individual board, then tying it all together for strength and support. Once the boards were installed the stanchions that hold the arena glass were slid into place, and the glass will be installed shortly. Once complete, the remaining protective netting will be secured to the top of the glass.

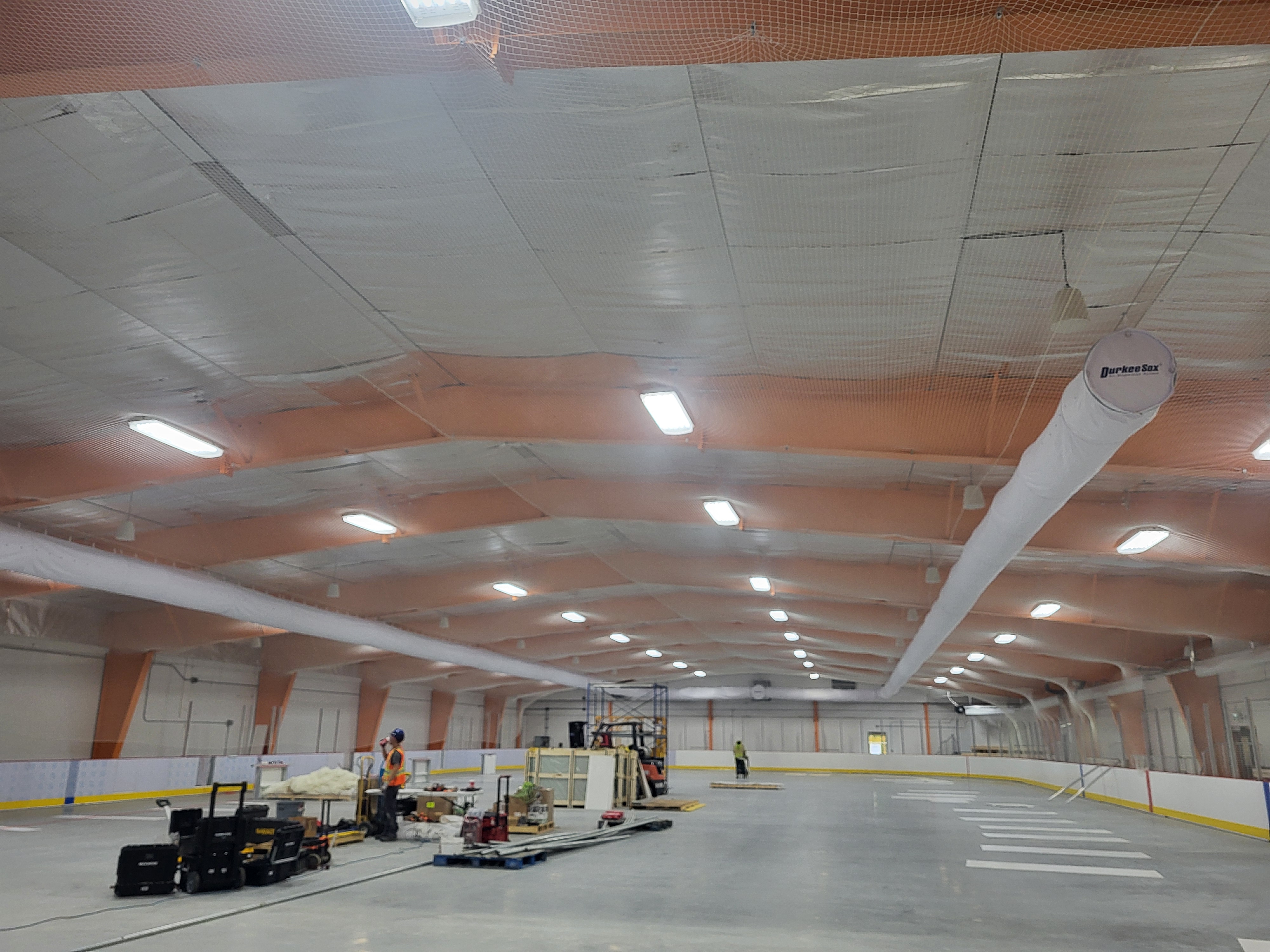

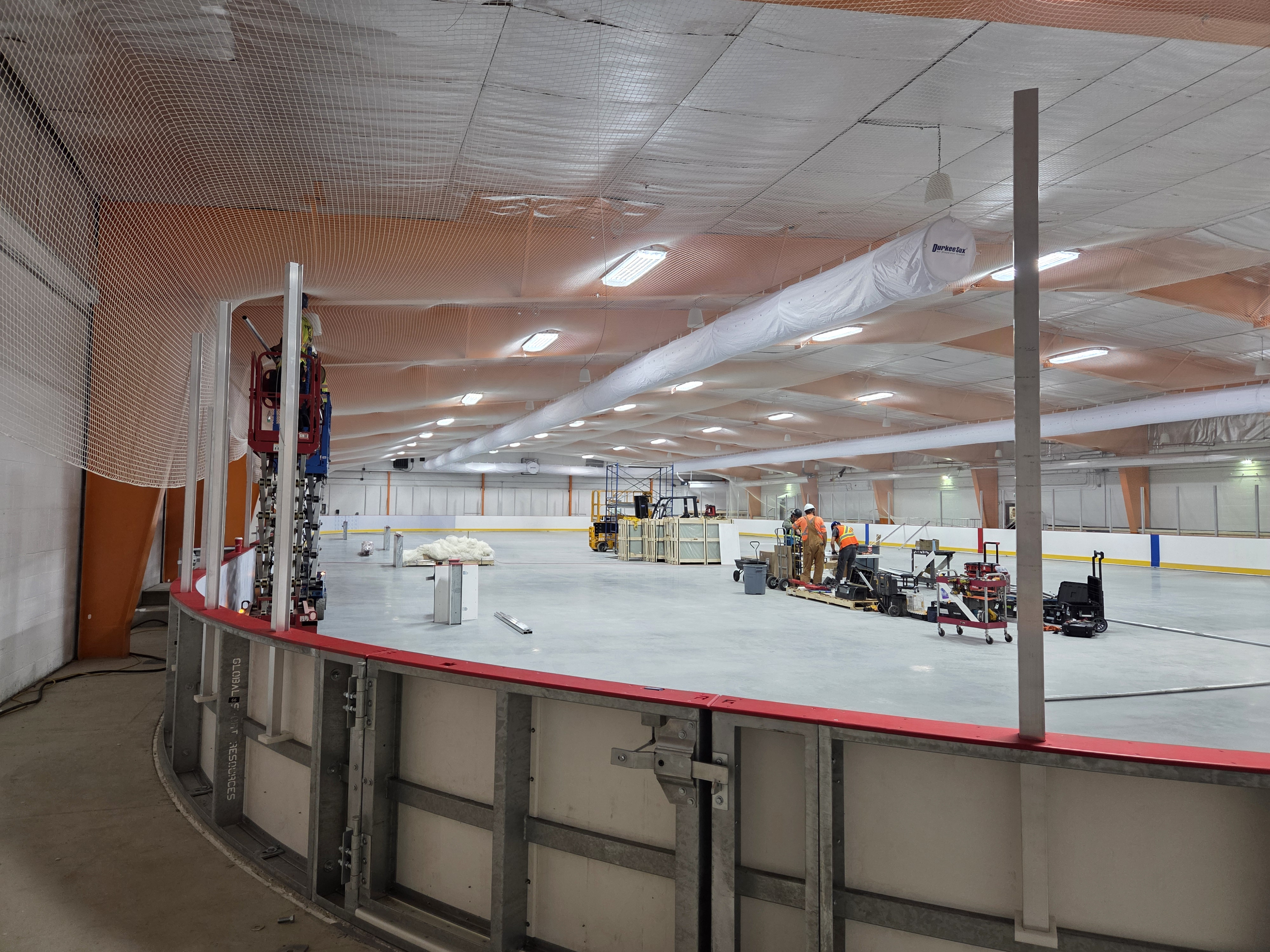

  • Ready for Boards!

    Another significant milestone in the Kinsmen Arena project will be underway this upcoming weekend! Starting tomorrow, September 12, the new boards and arena glass will be installed, and should be completed by early next week. While we've been waiting for the concrete floor to cure lots of work has progressed:

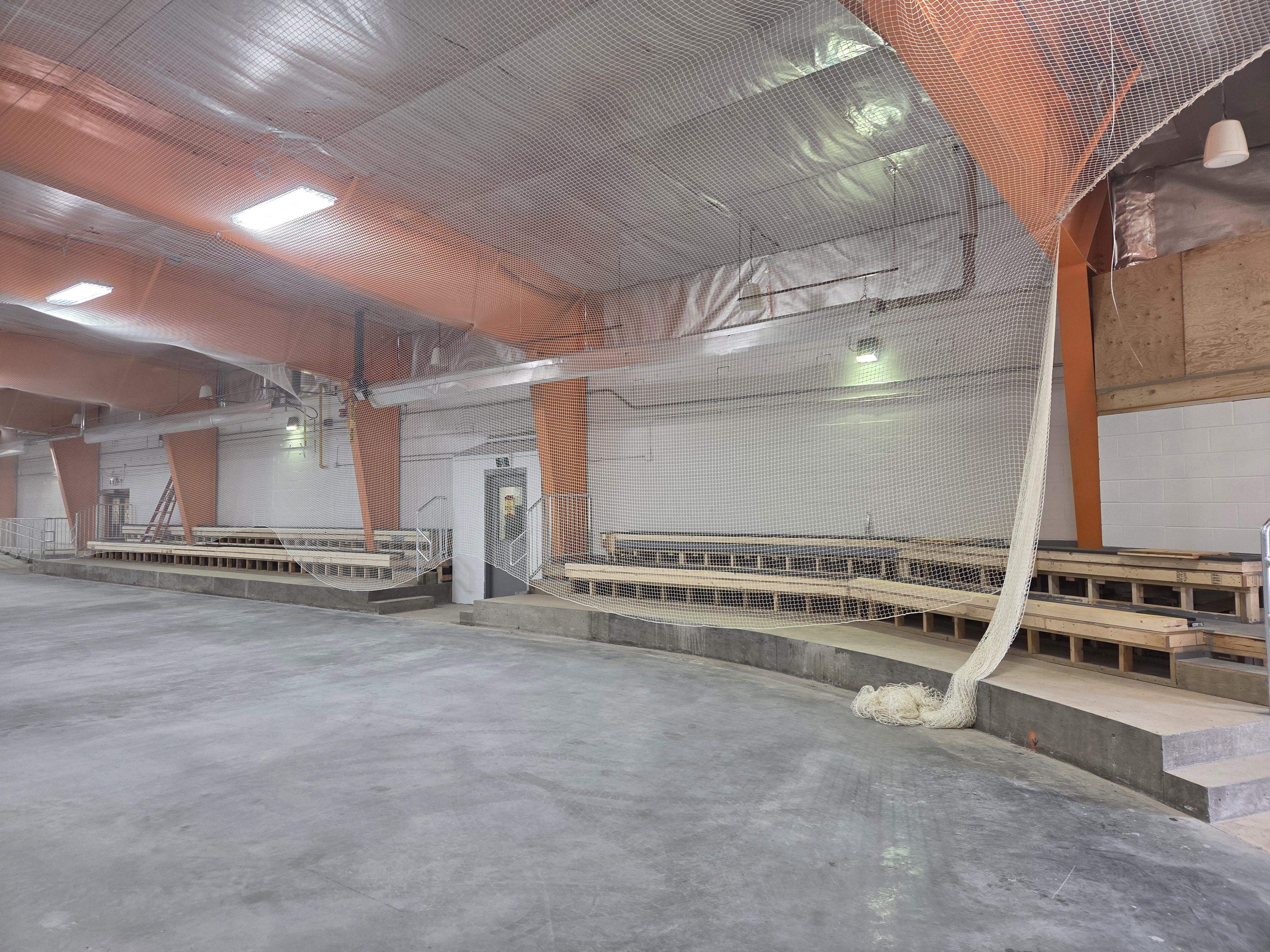

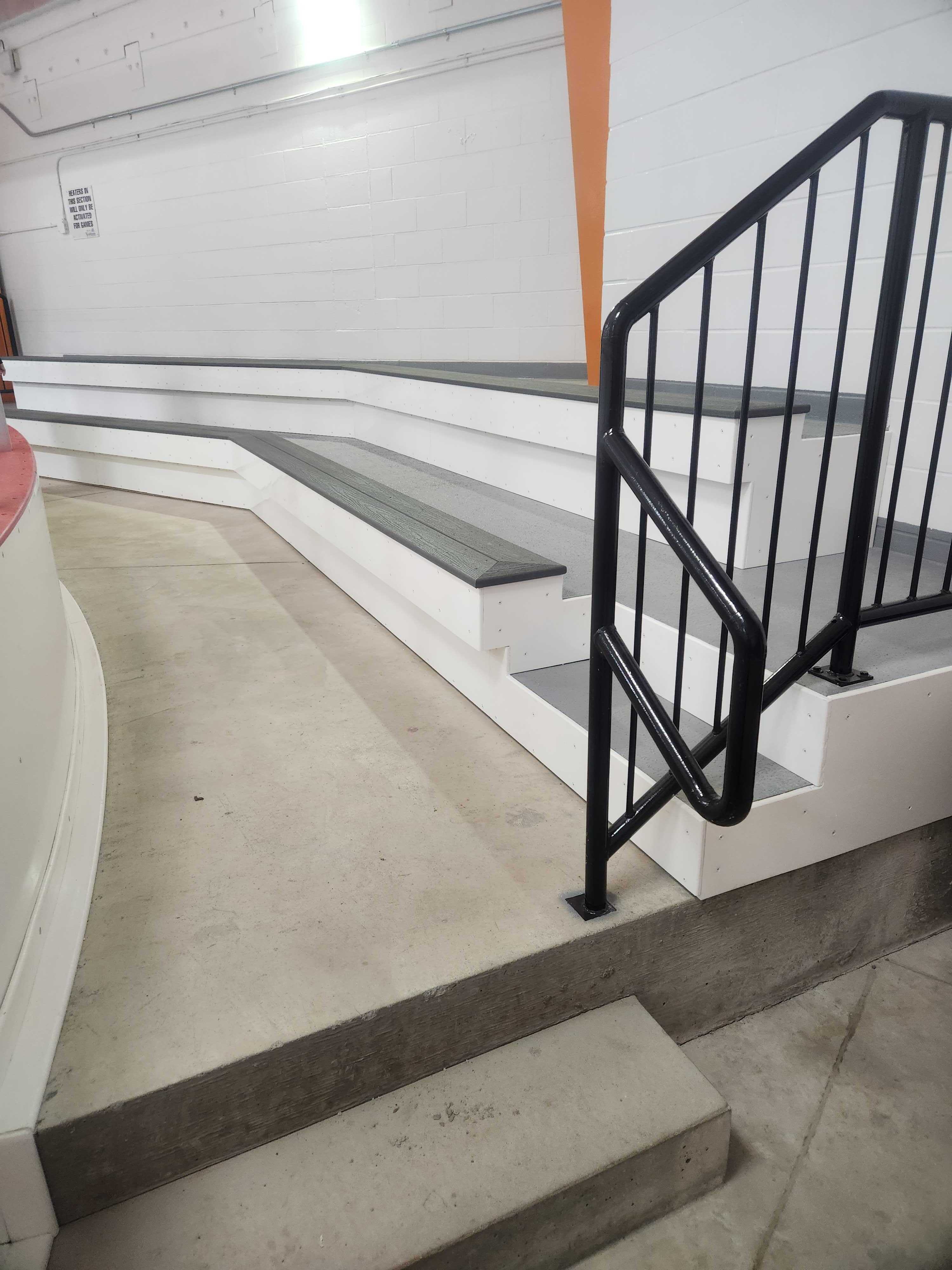

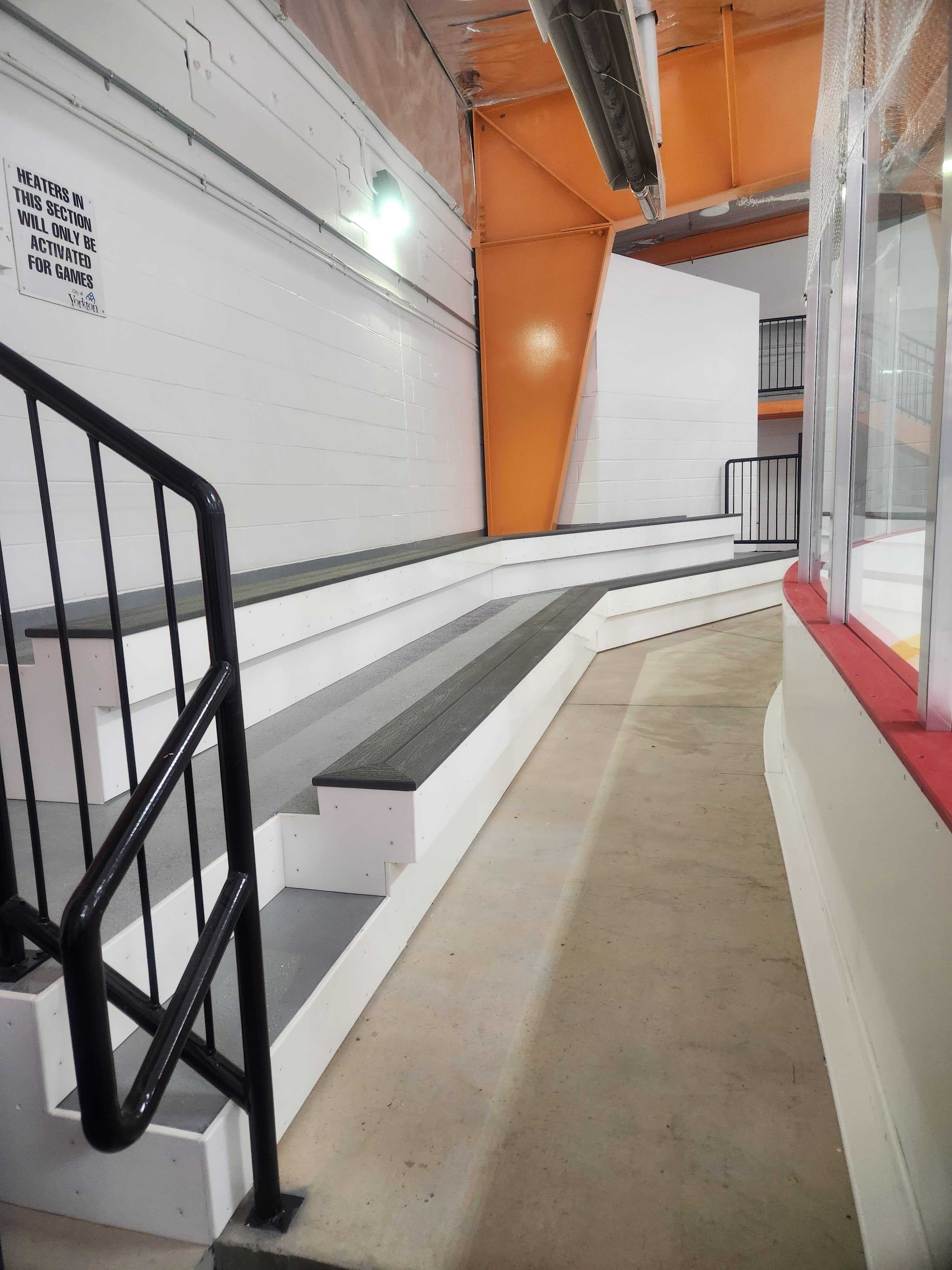

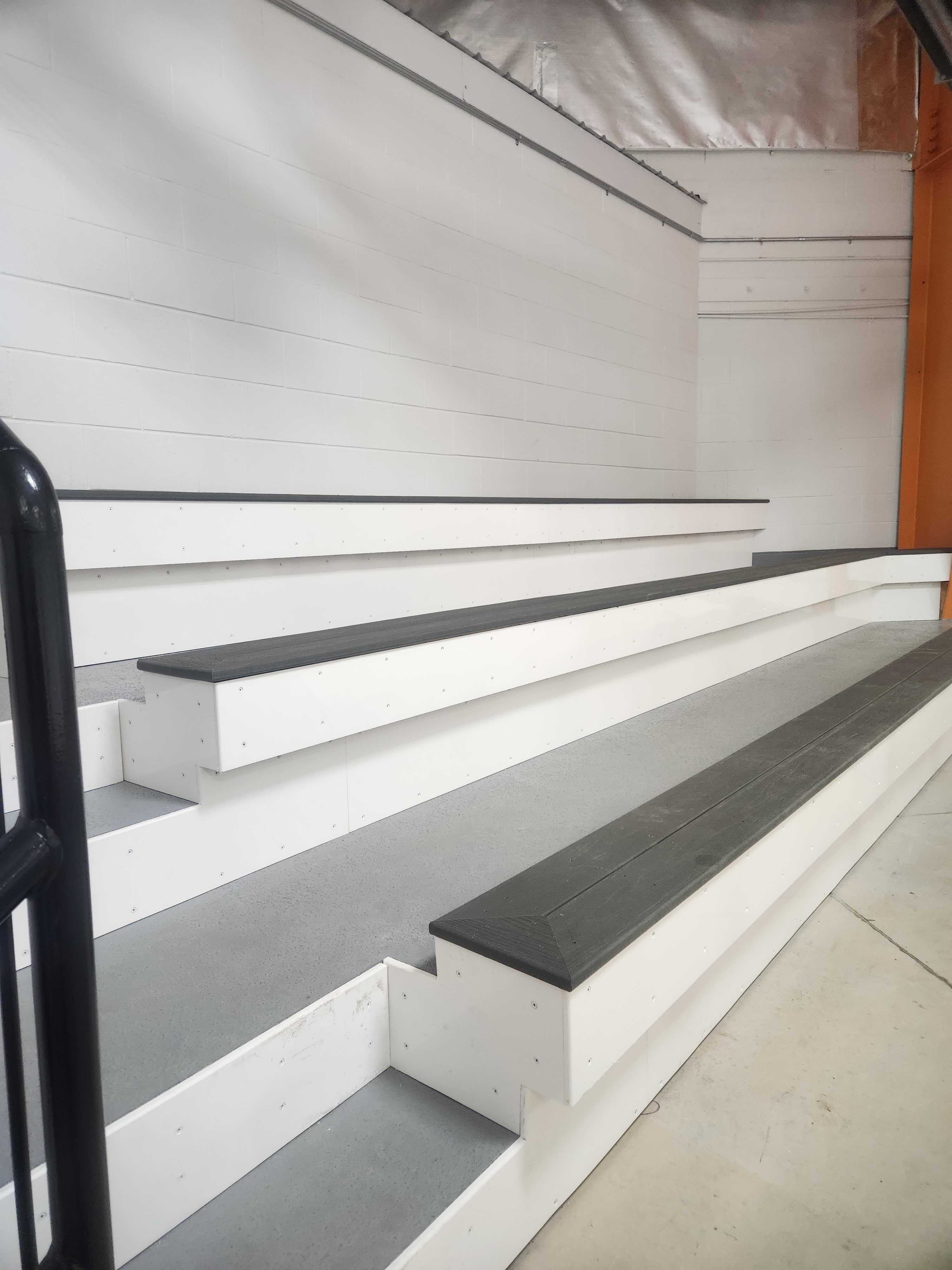

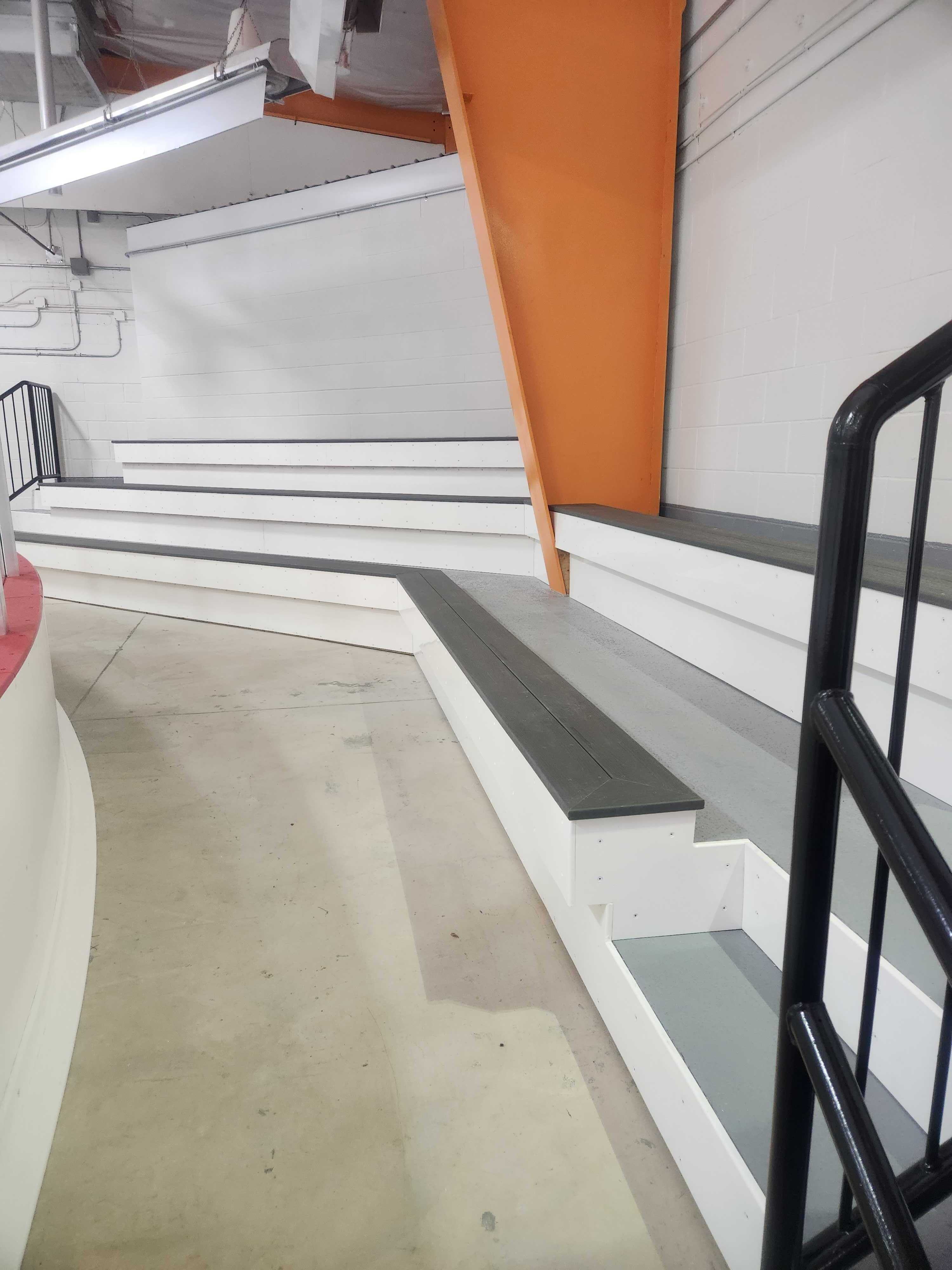

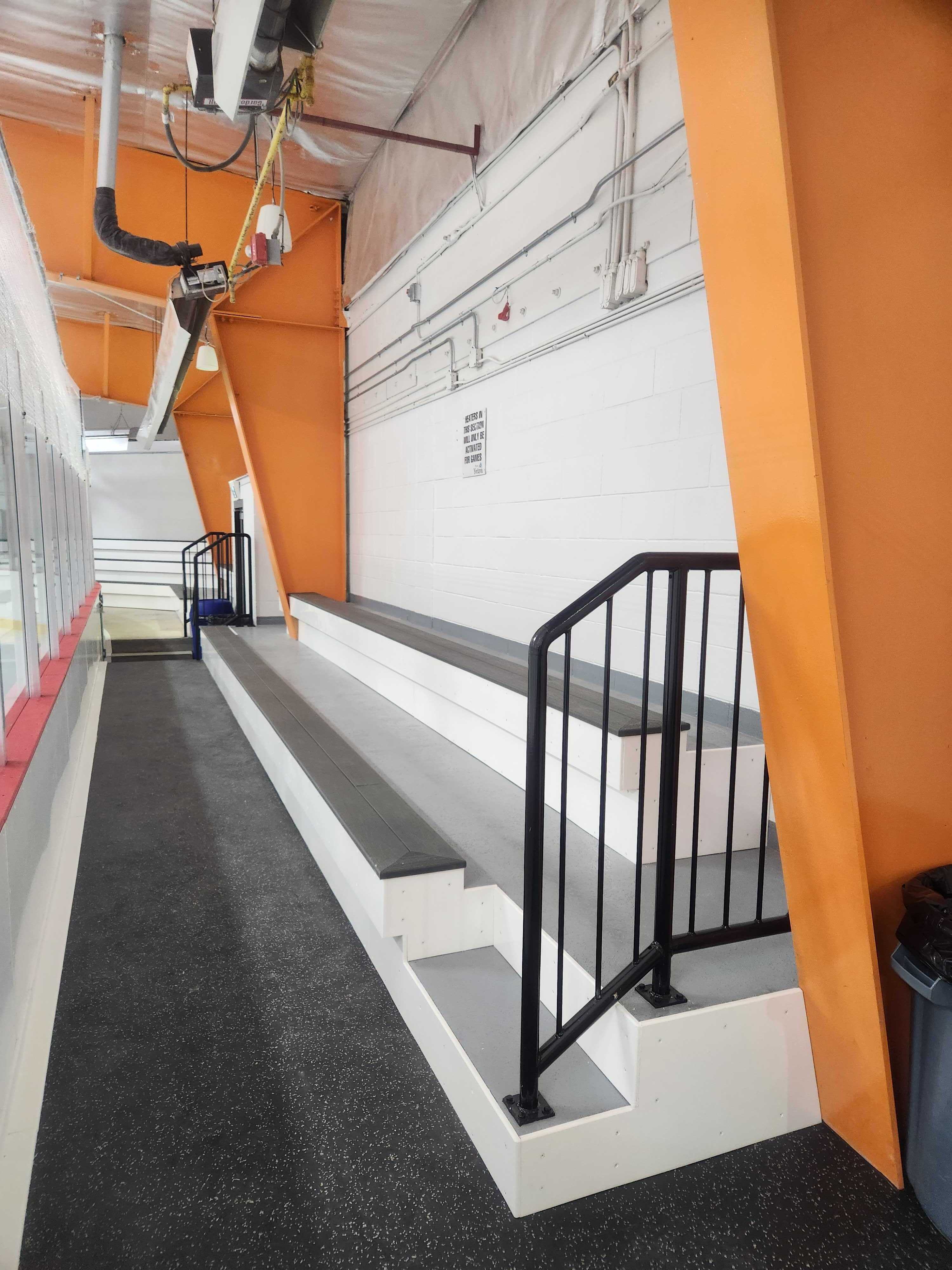

    • Bleacher seating is nearing completion, including the new wheelchair accessible seating area.

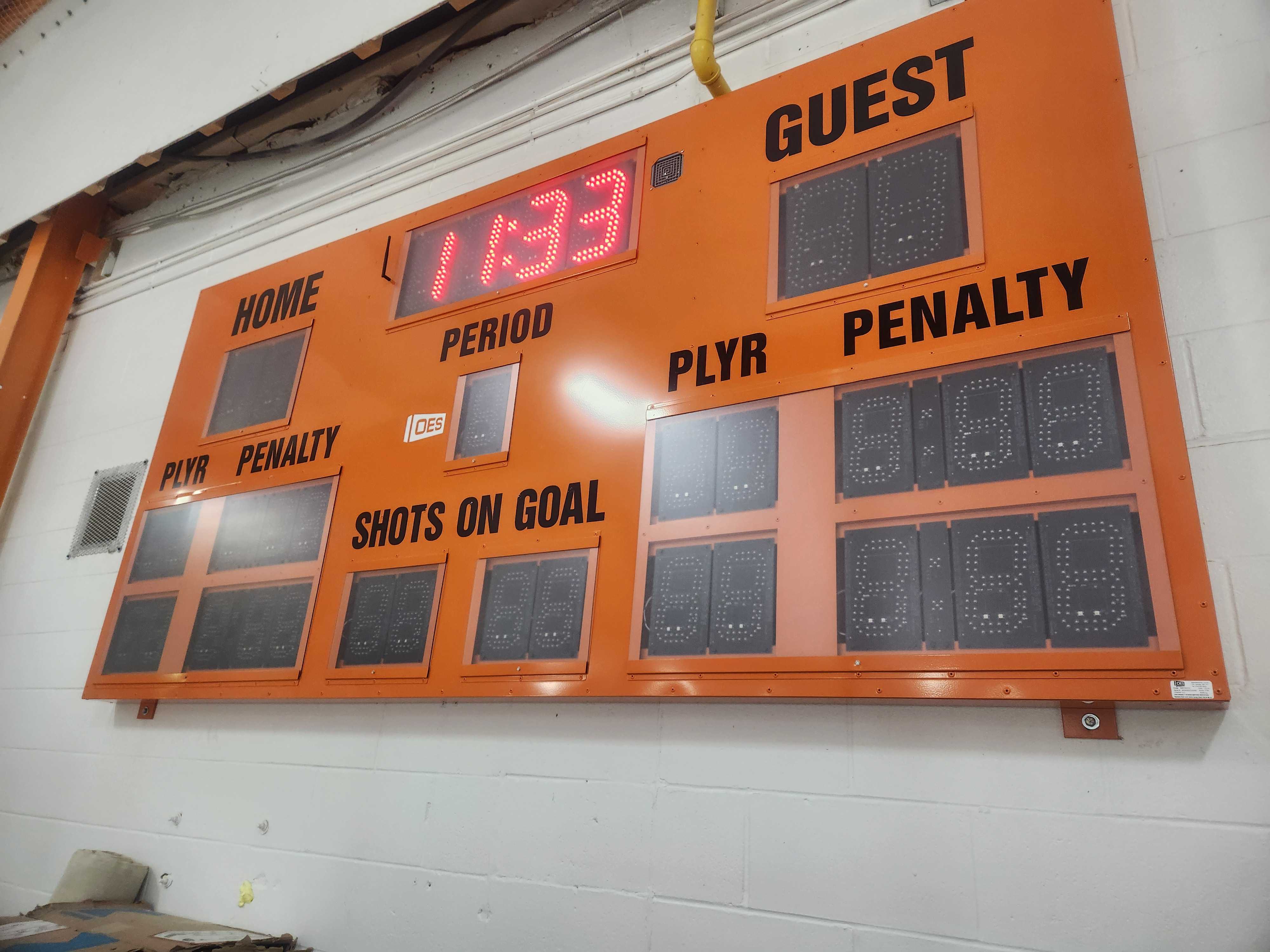

    • New score clock has been installed.
    • Protective netting installed.

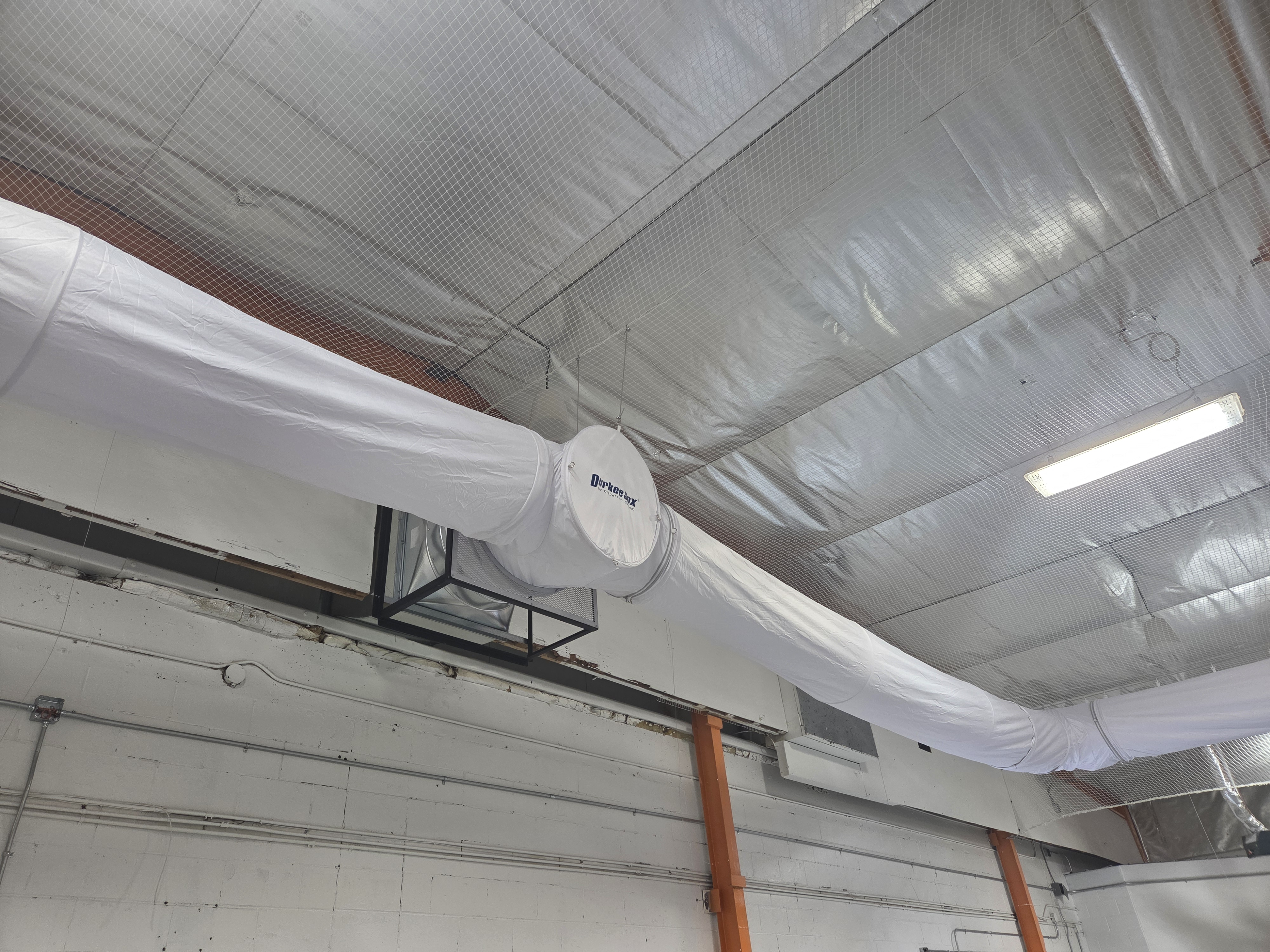

    • Dehumidification systems installed.

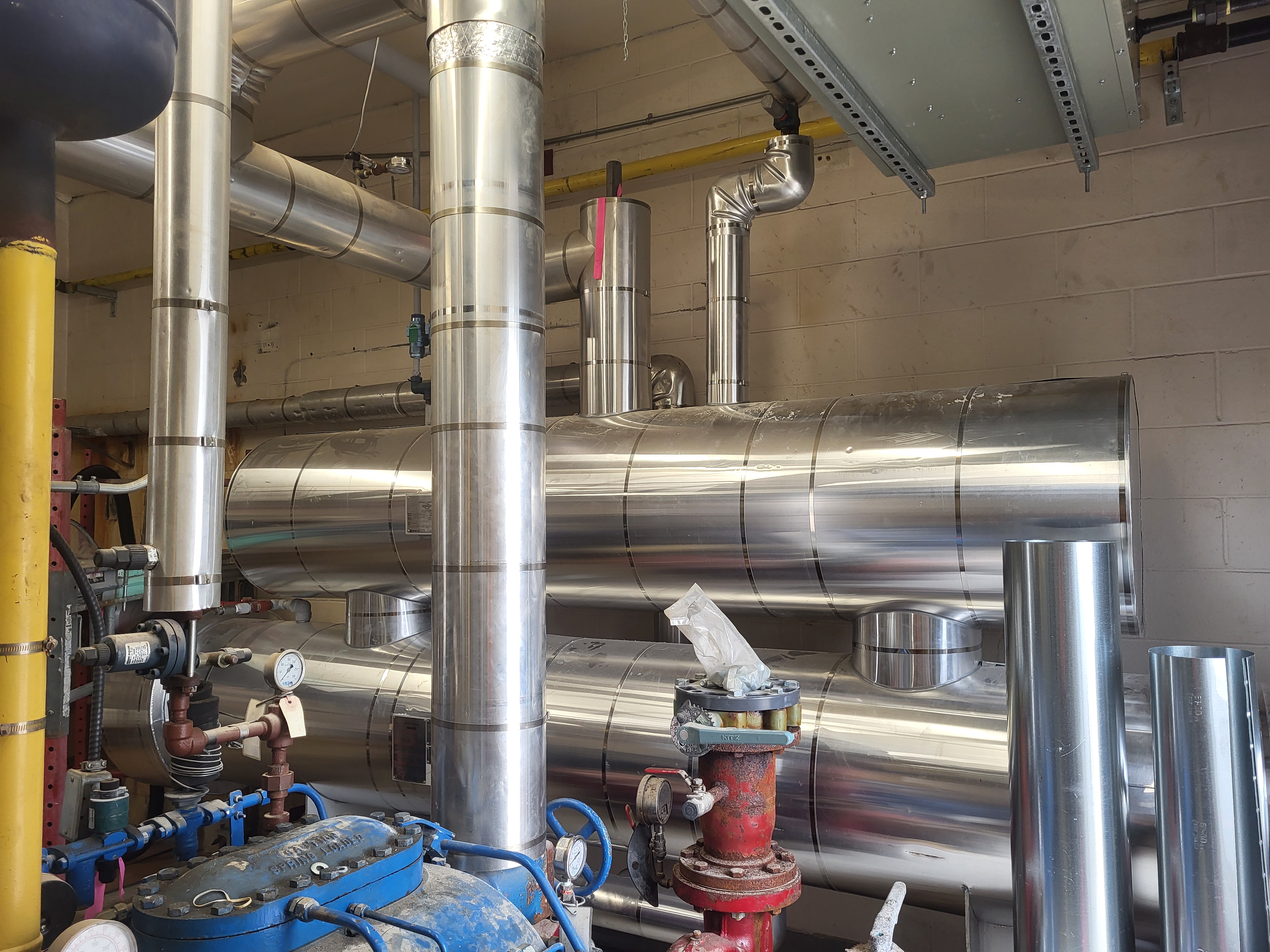

    • Sump pump and related controls and alarms installed.

    • Gas detection equipment installed in the plant room.

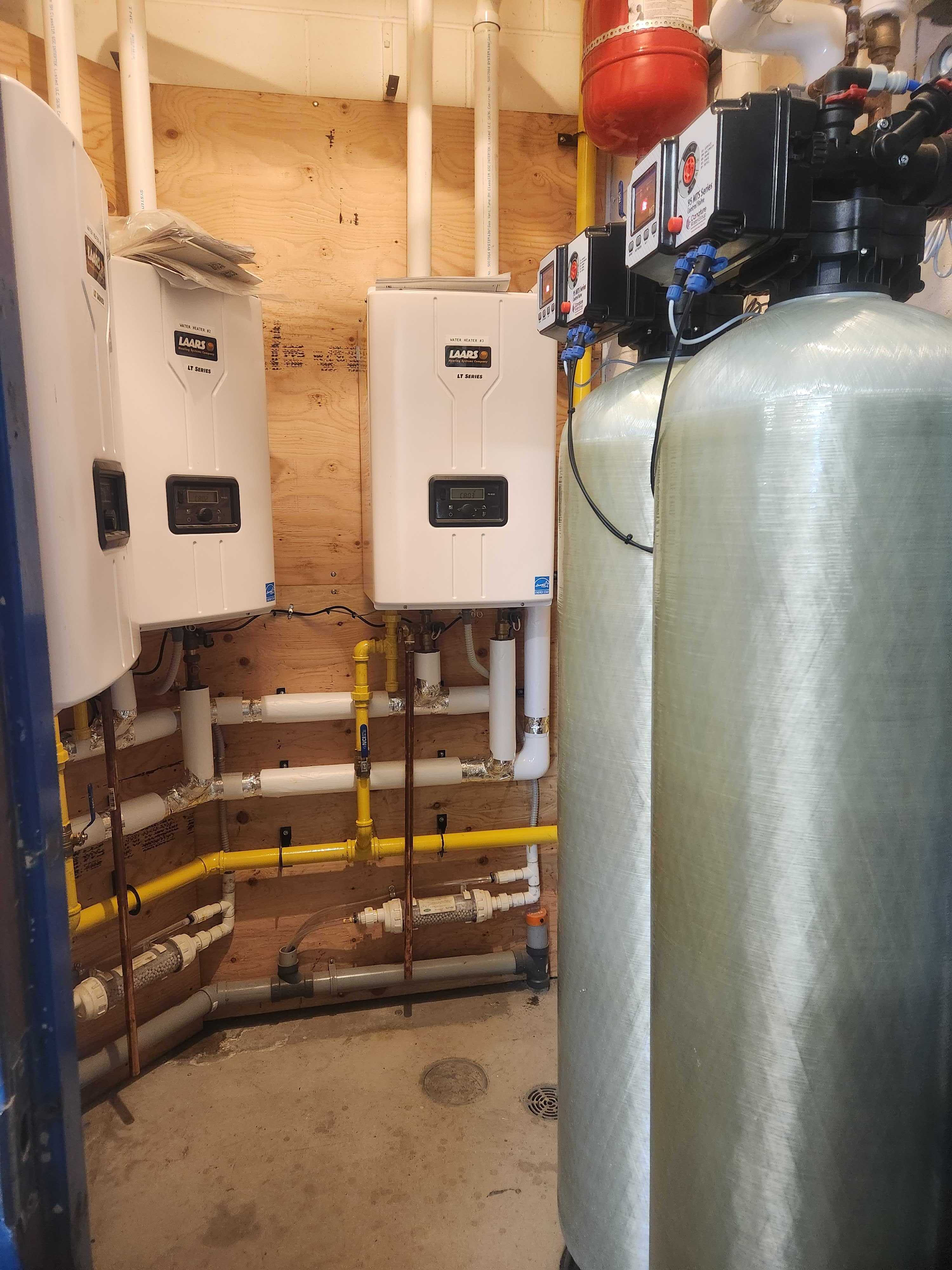

    • New hot water heaters installed.

    Once the boards are installed some finishing touch ups will be worked on. The Project Team along with the consultant, engineers, and general contractor will be conducting a final walkthrough on September 29th. Completion of the project remains scheduled for October 2nd, at which point ice making will begin, with ice planned for skating Tuesday after Thanksgiving.

  • The New Floor

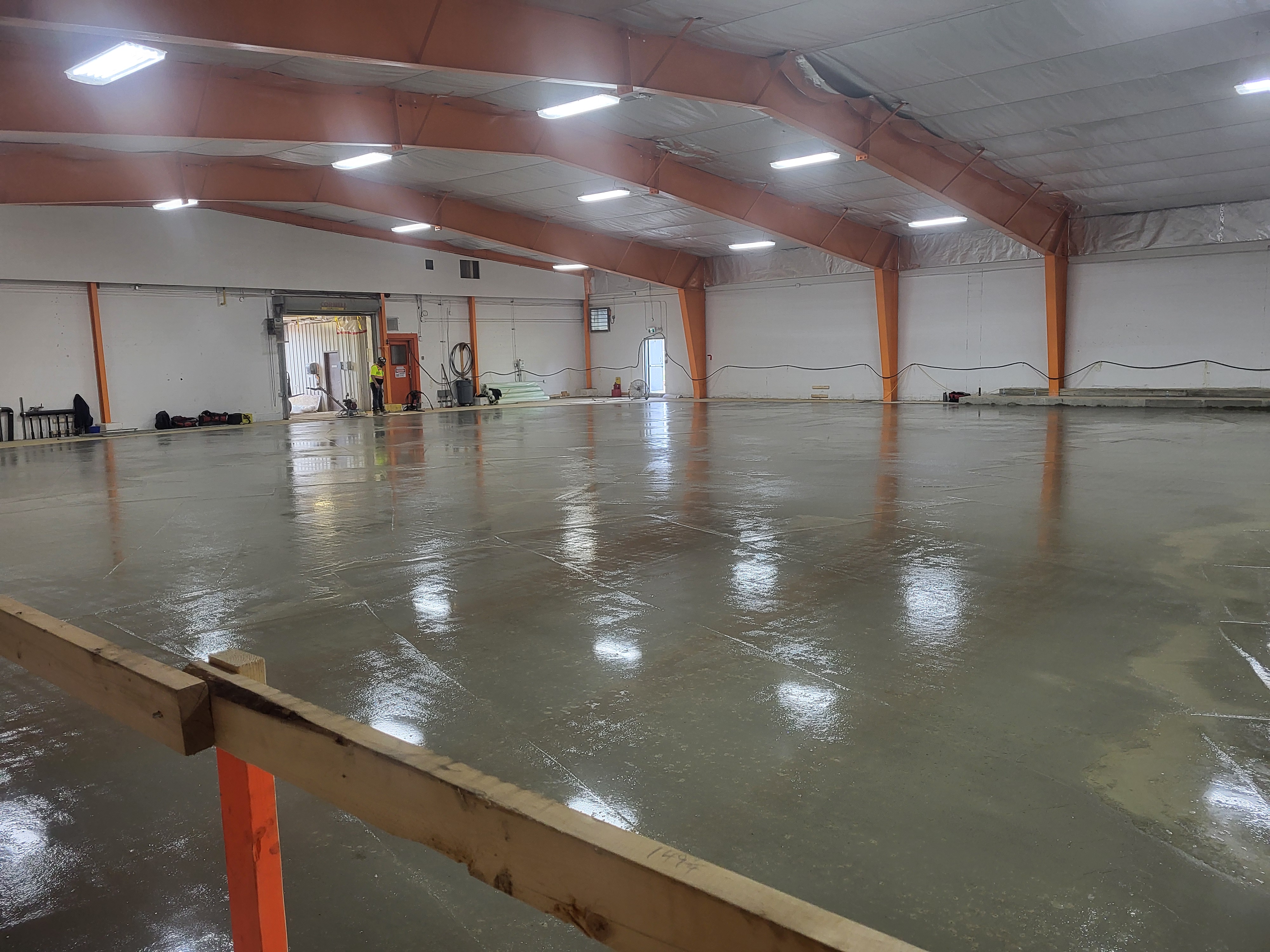

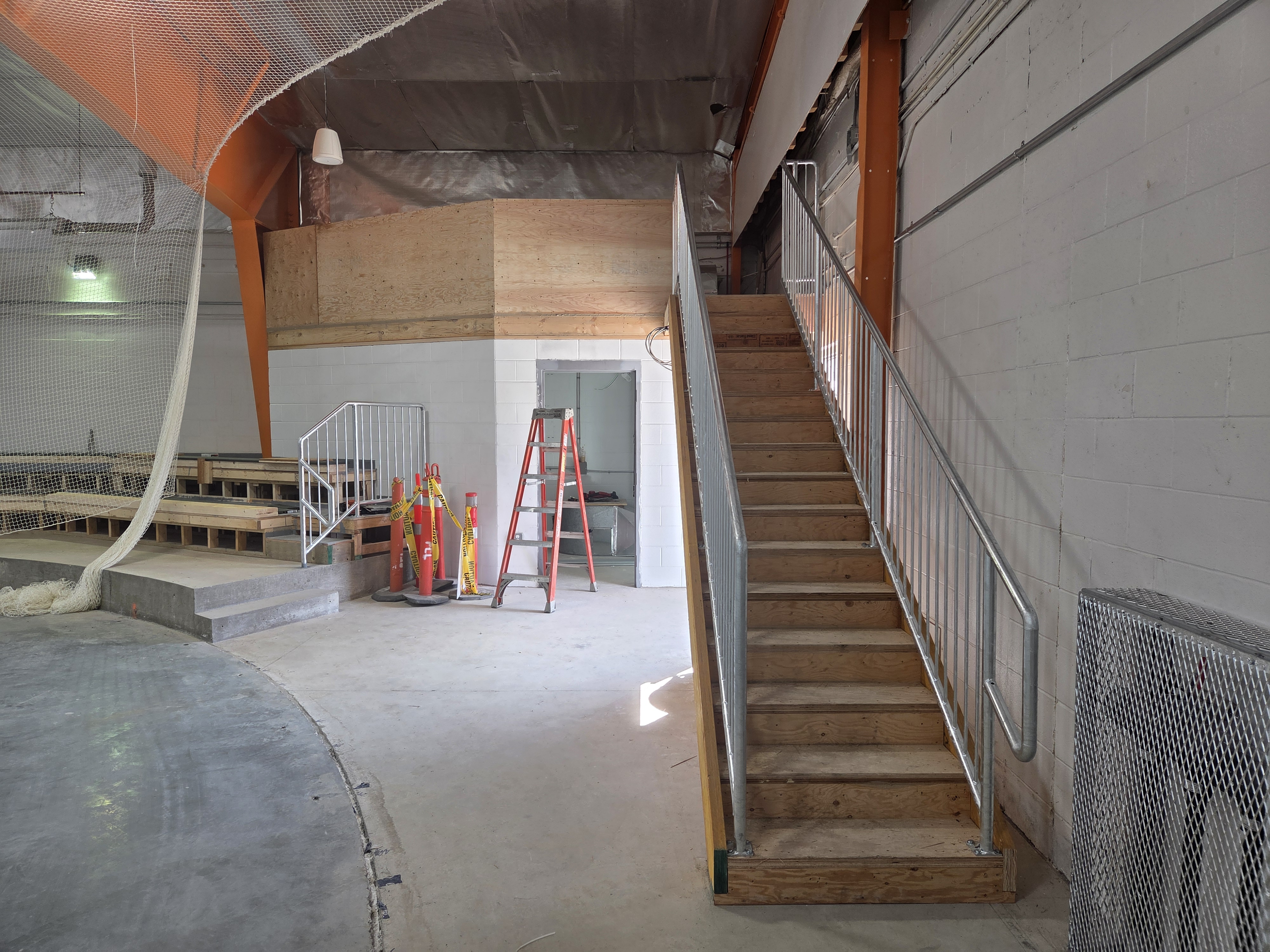

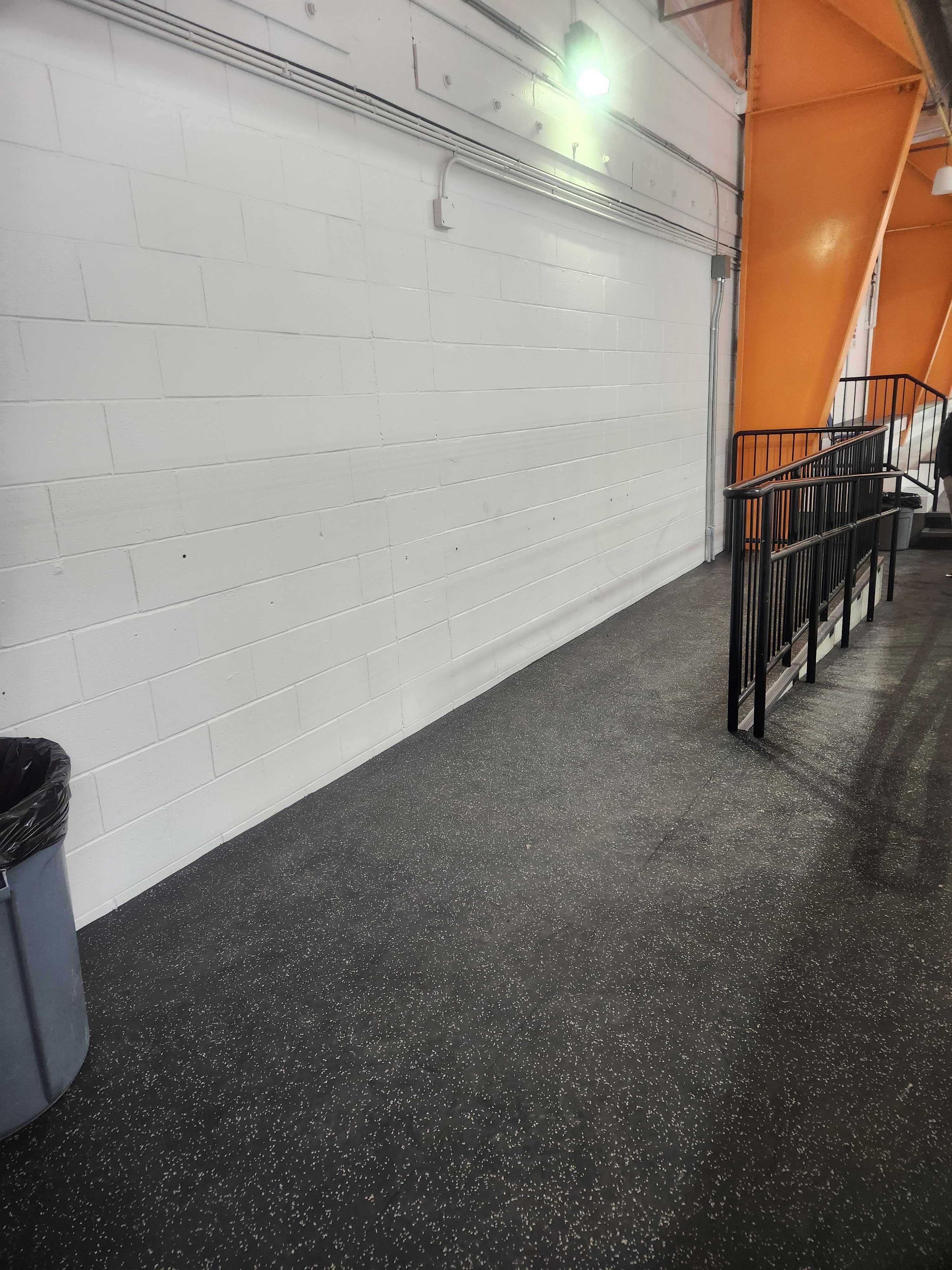

    After being poured last week, the new arena floor was covered with blankets to assist with the curing process. The blankets were removed Wednesday this week and the concrete is being cleaned. Additional curing time is required before the new rink boards can be installed, however work is continuing on other areas of the project, including bleacher seating, sound system wiring, and installation of new equipment in the mechanical room.

  • The Big Pour!

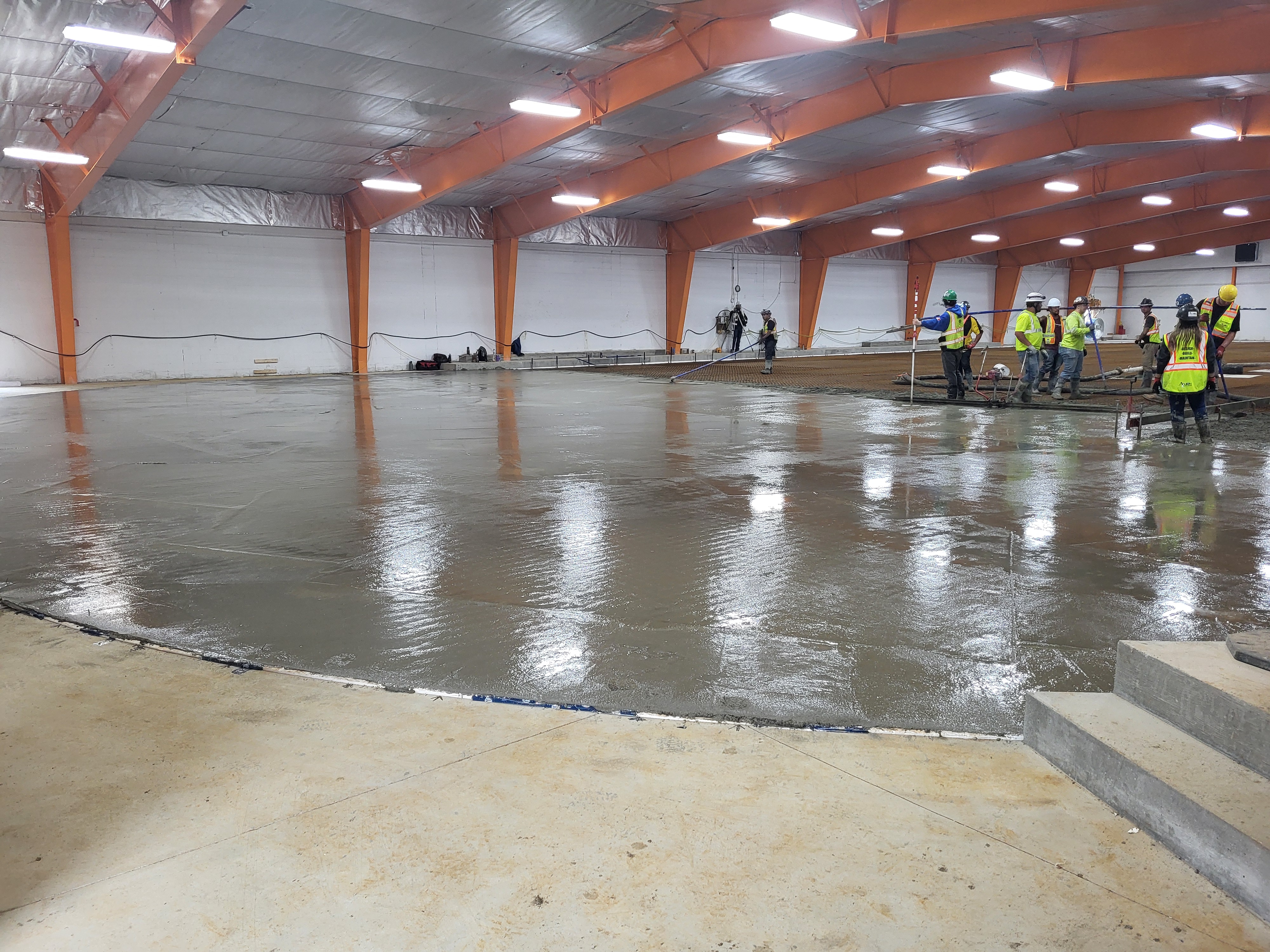

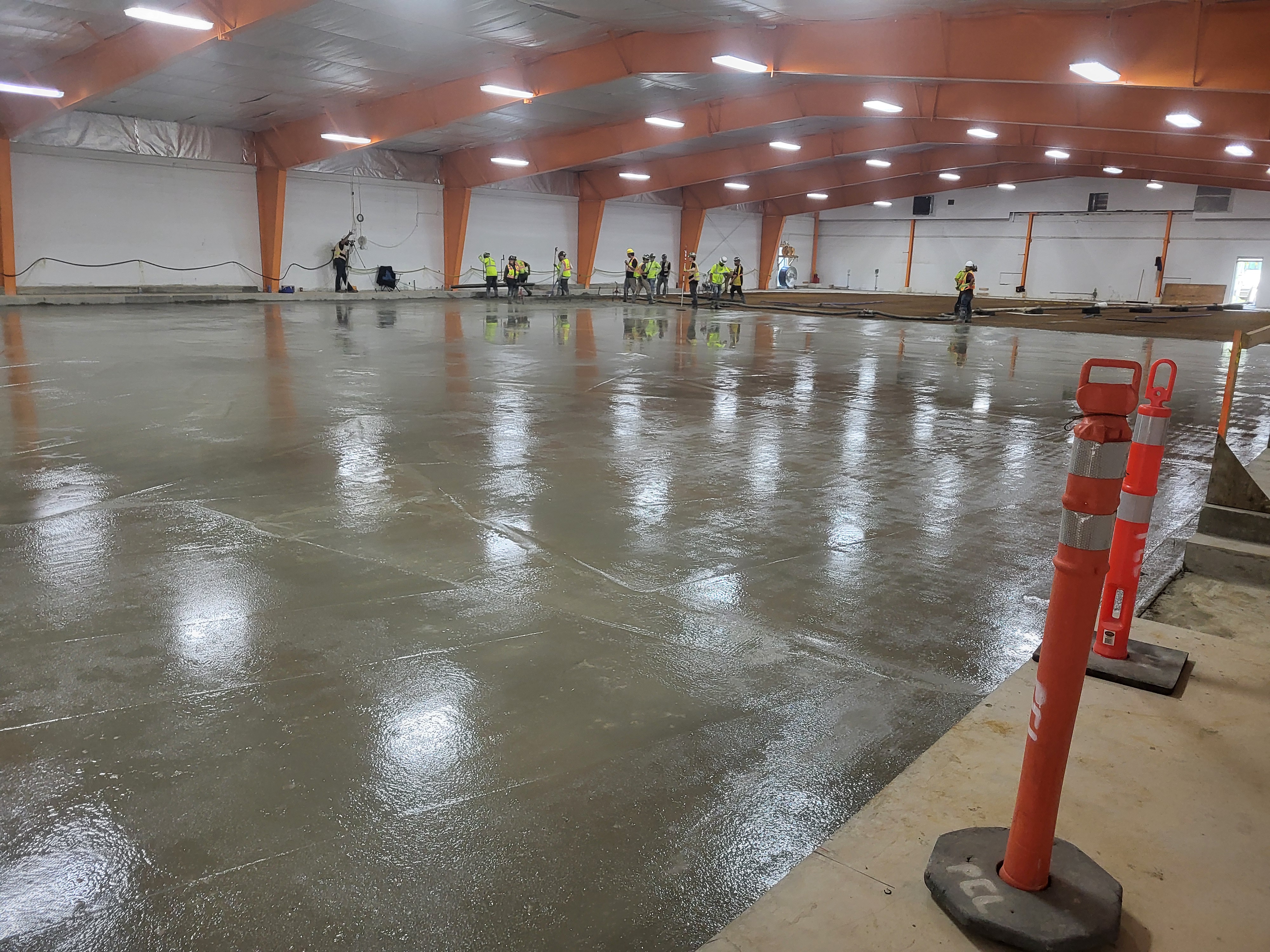

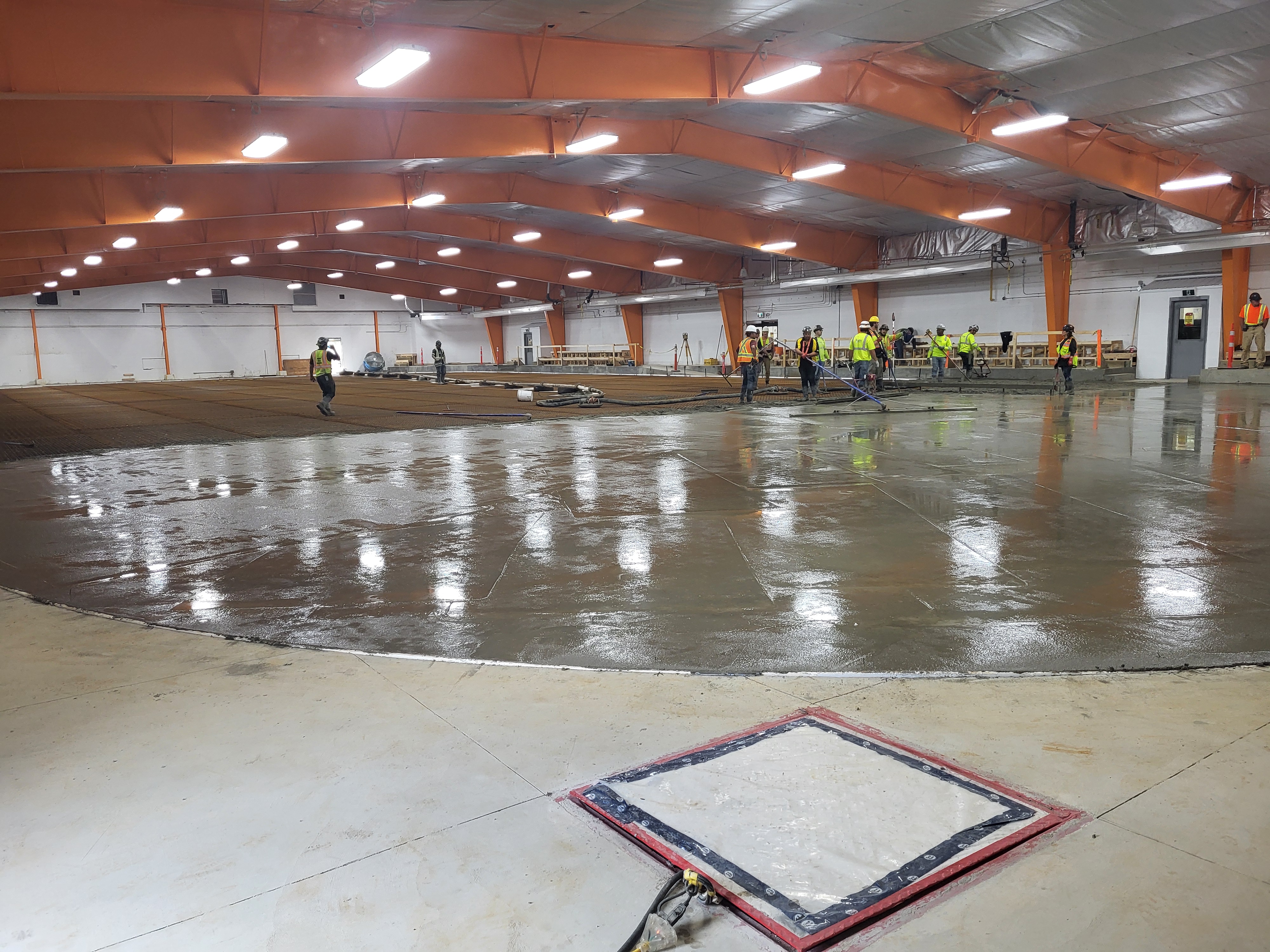

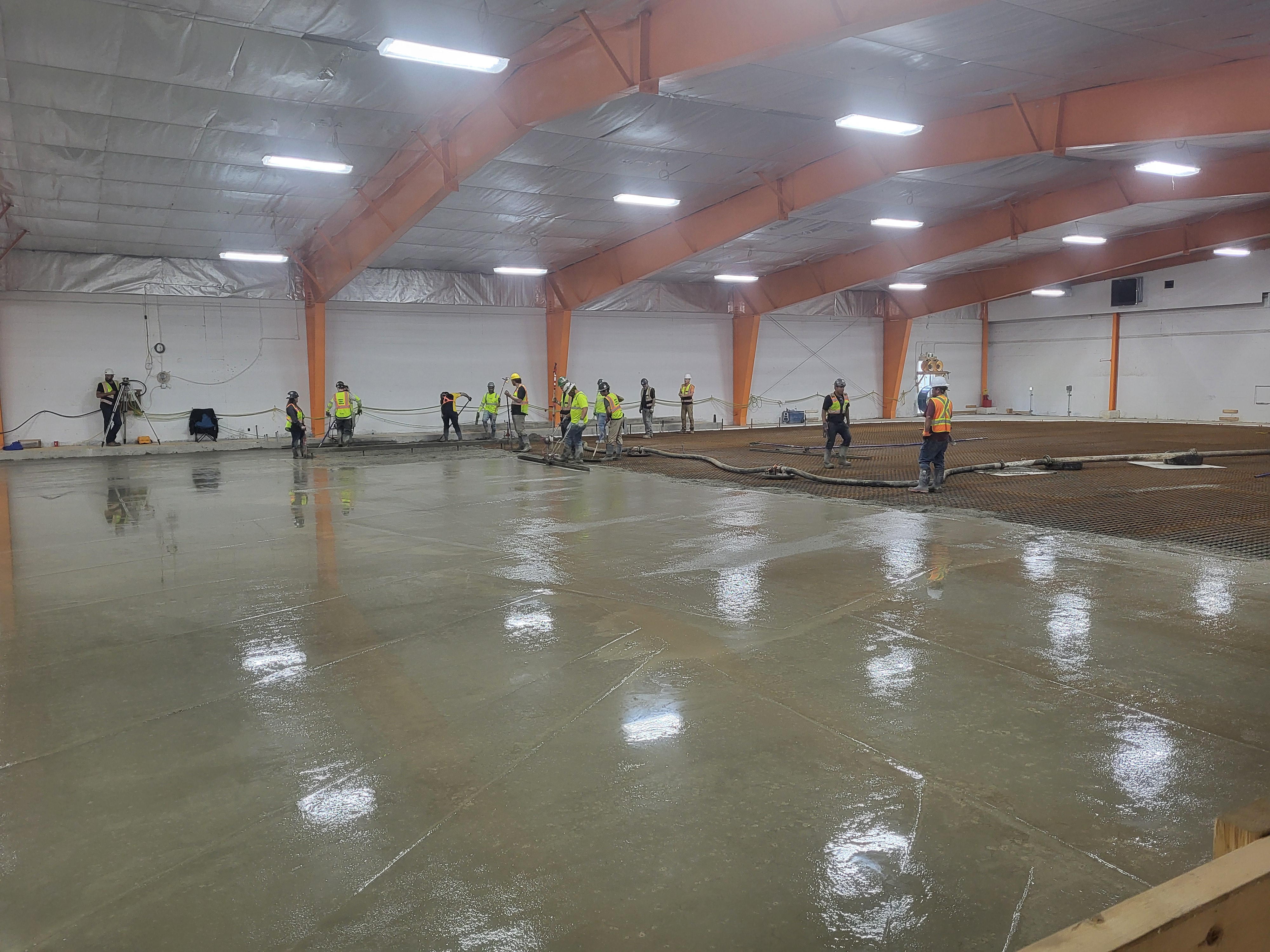

    A huge milestone in the Kinsmen Arena project was completed today! Starting early this morning concrete began to flow into the facility to start building up the new arena floor. It took several hours to pour all the concrete, but the work is not finished yet. Power trowelling and finishing work will continue through the evening and overnight to give the arena floor that nice smooth, polished finish.

    The concrete requires 28 days to fully cure before work on the new rink boards can start. While waiting for concrete to cure work will continue on areas outside of the arena floor, include spectator and player benches, dehumidification components, and the mezzanine for the new sound booth.

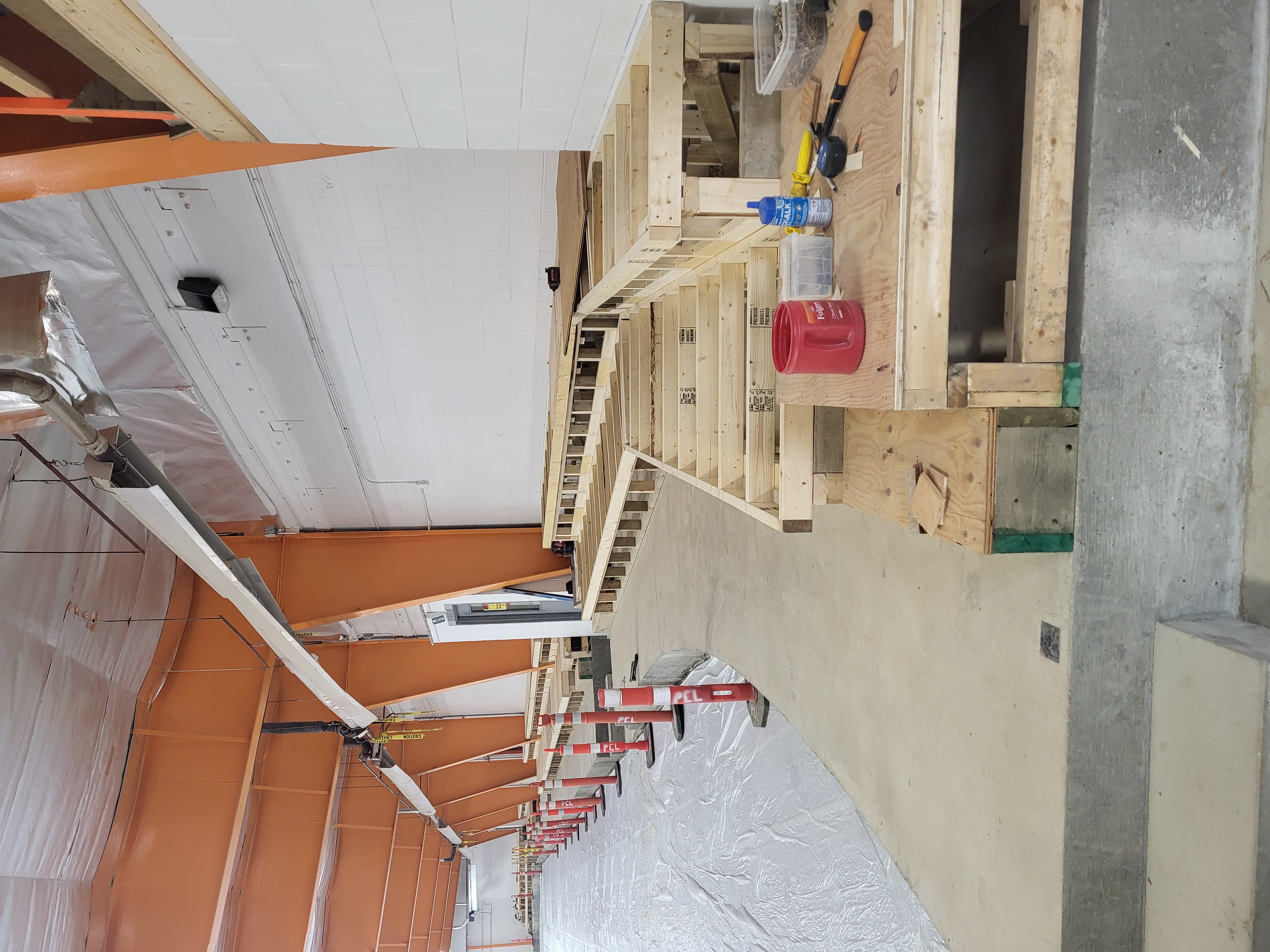

  • Cold Floor Piping Complete

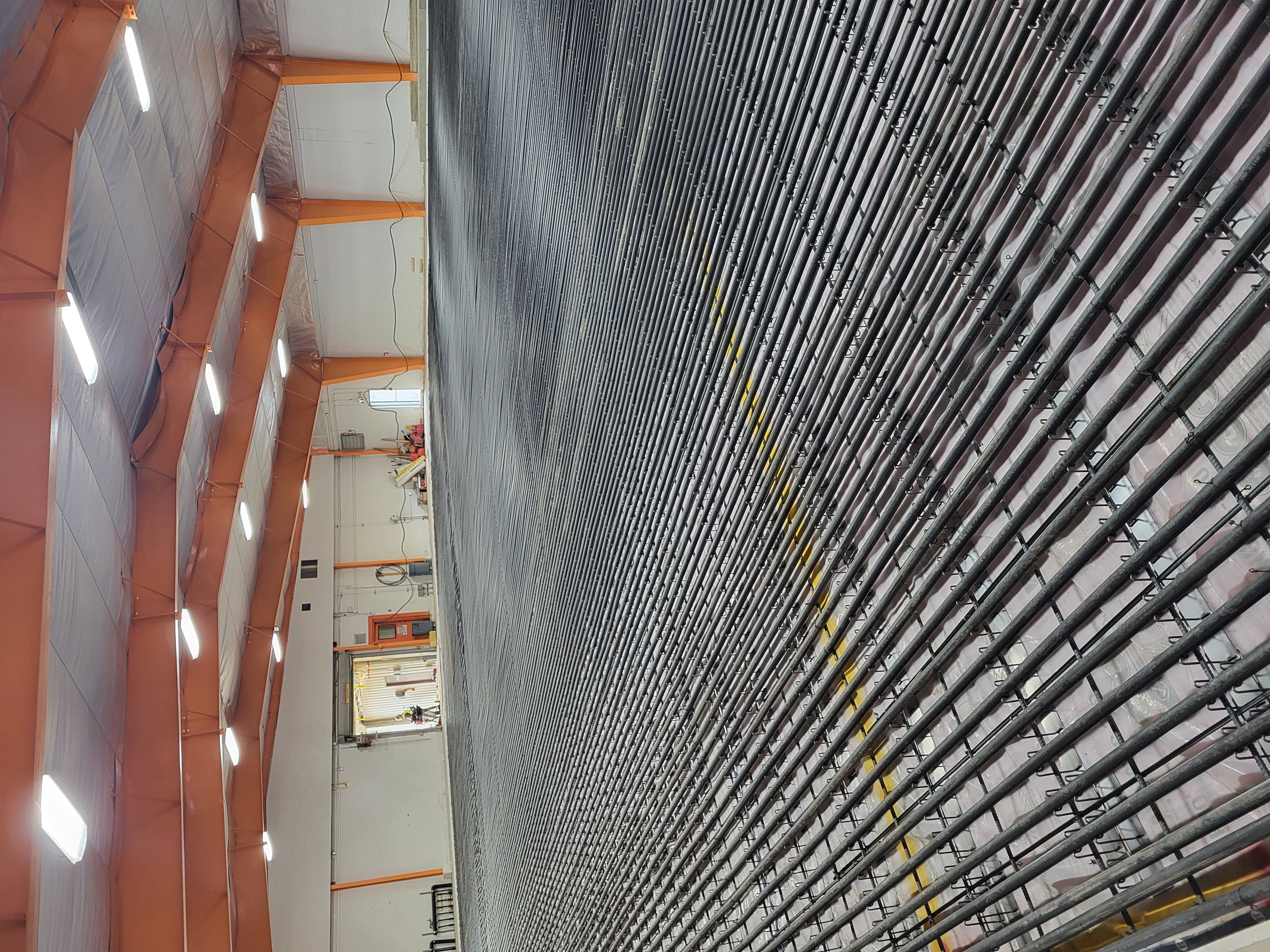

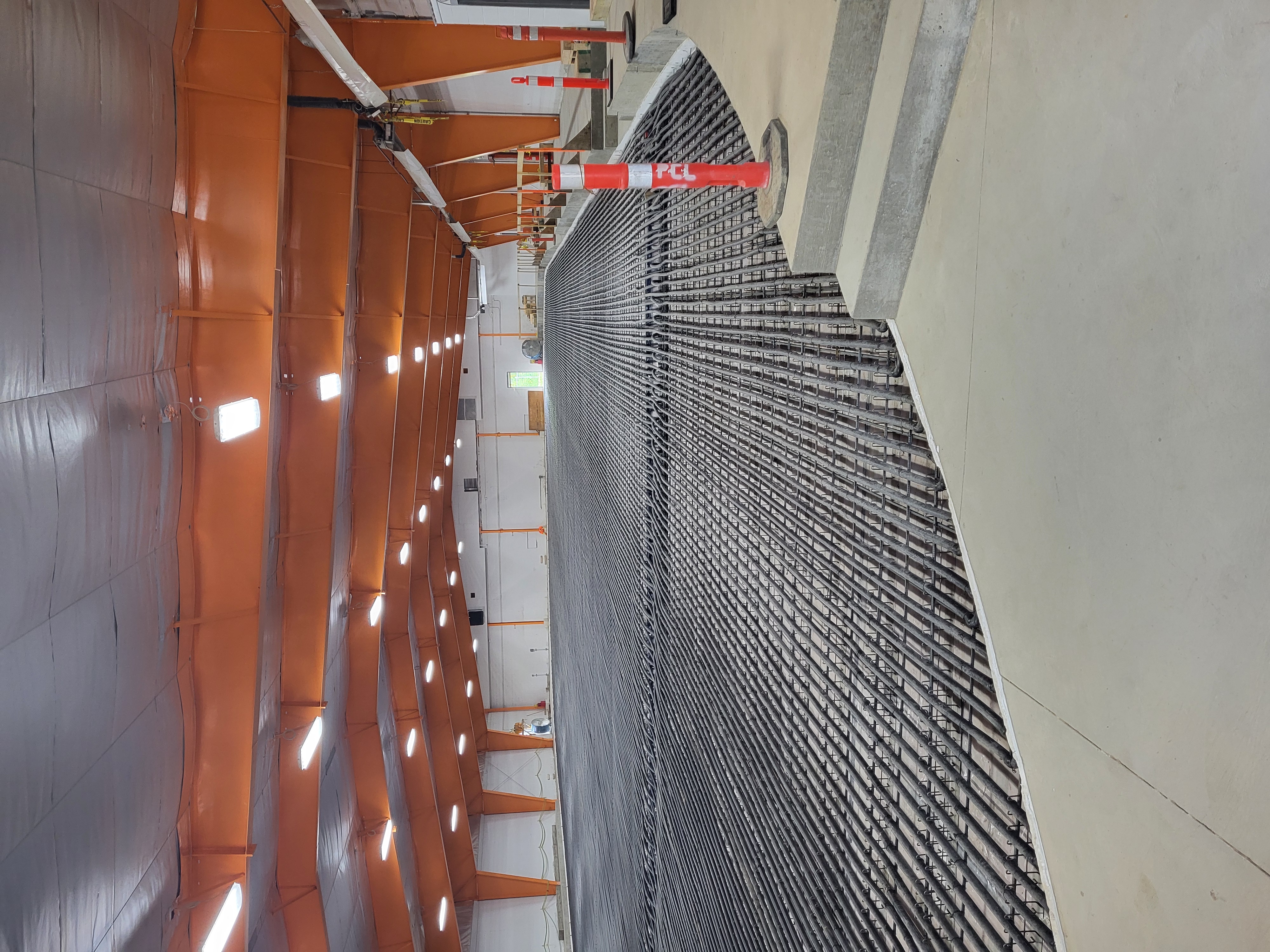

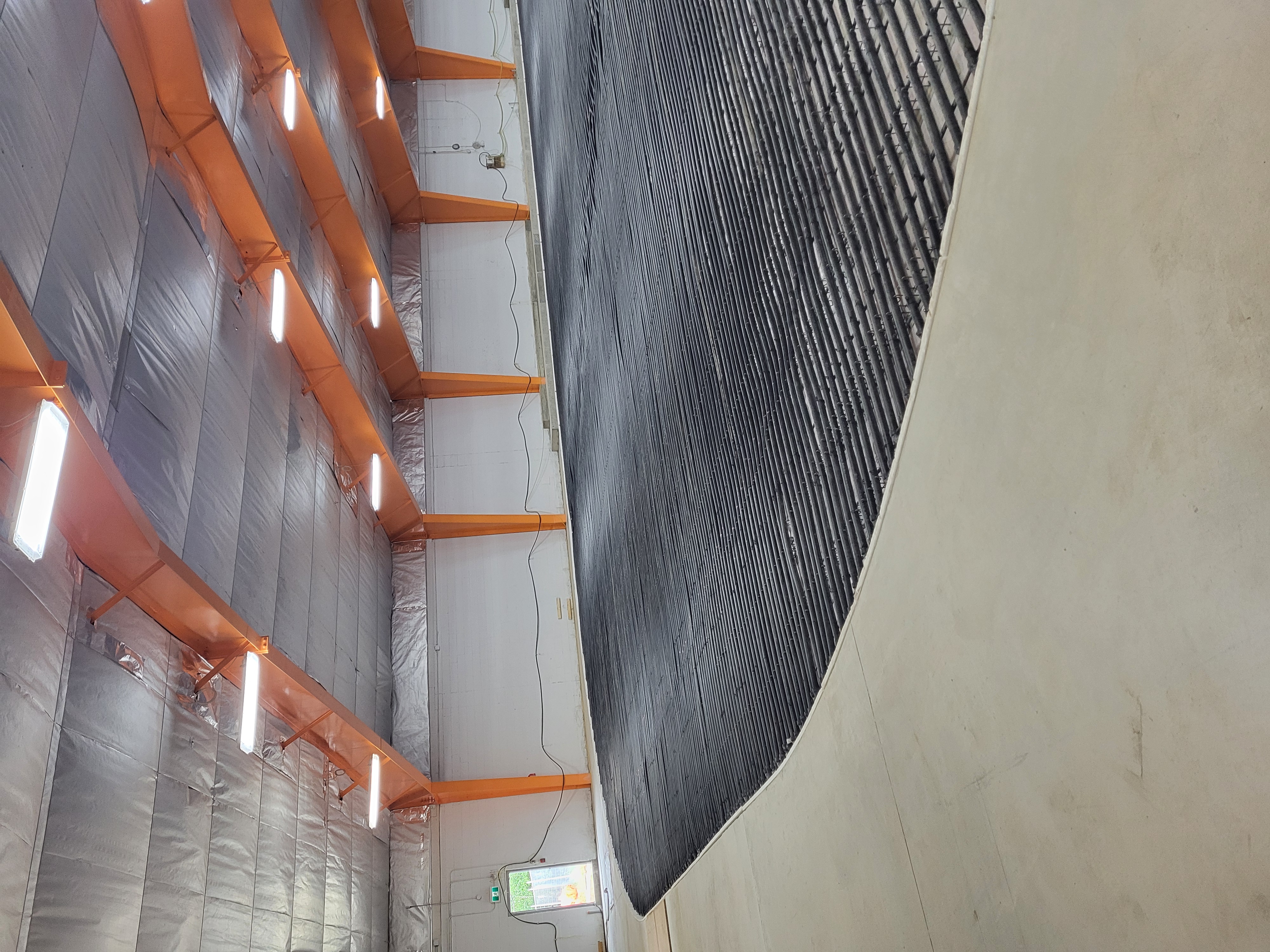

    • The cold floor piping has now been installed.

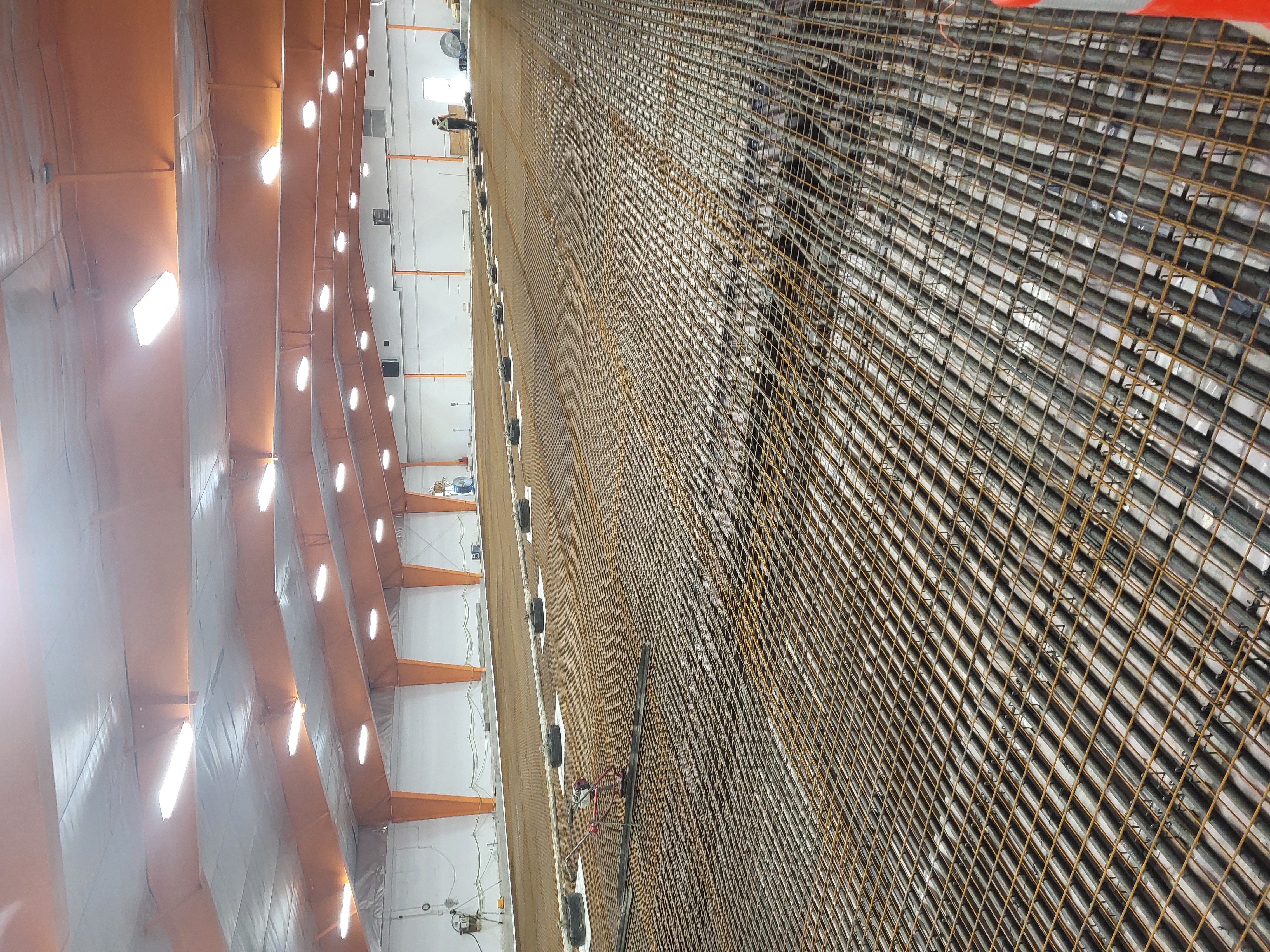

    • A layer of metal mesh reinforcement will be placed next.

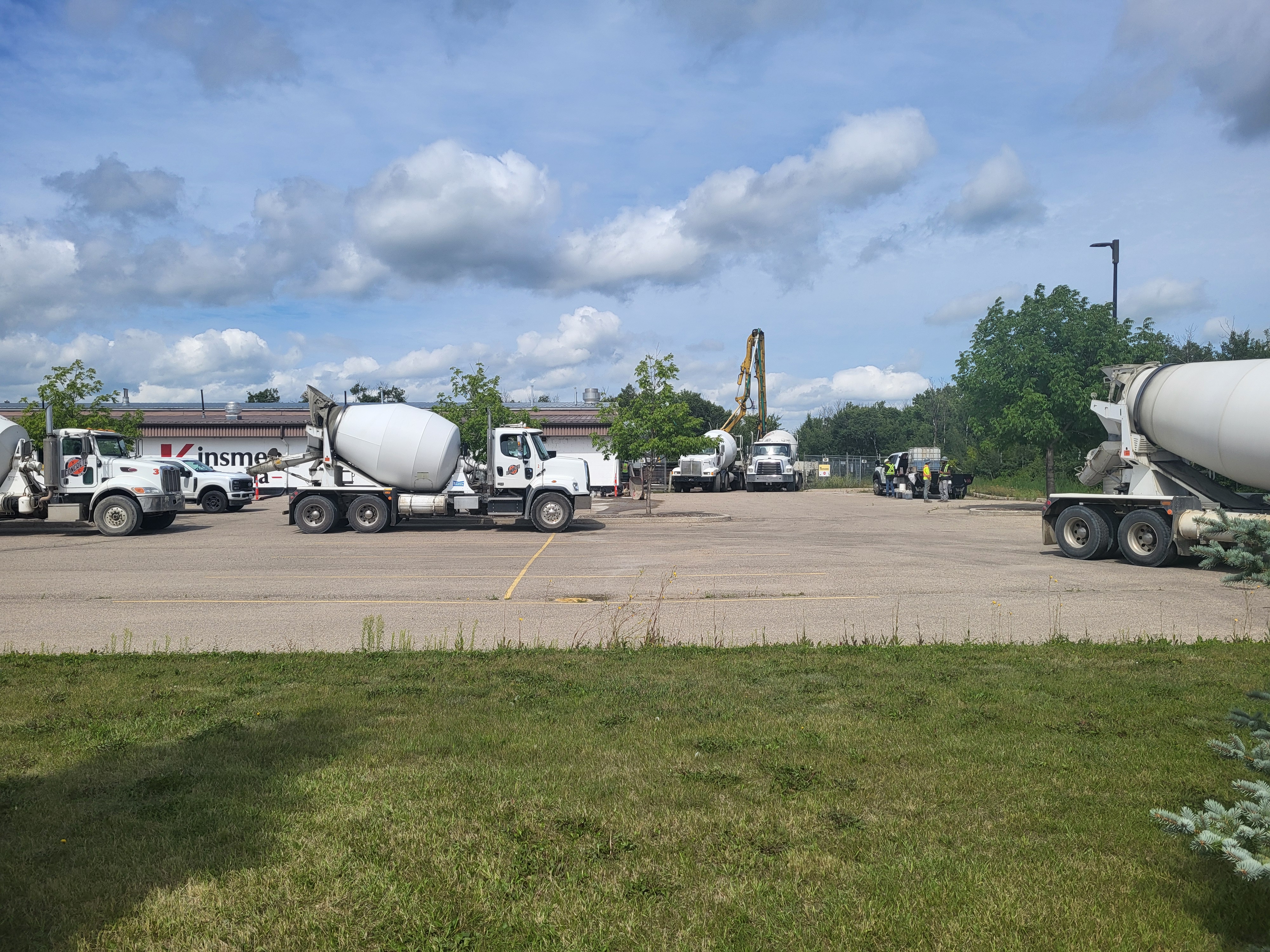

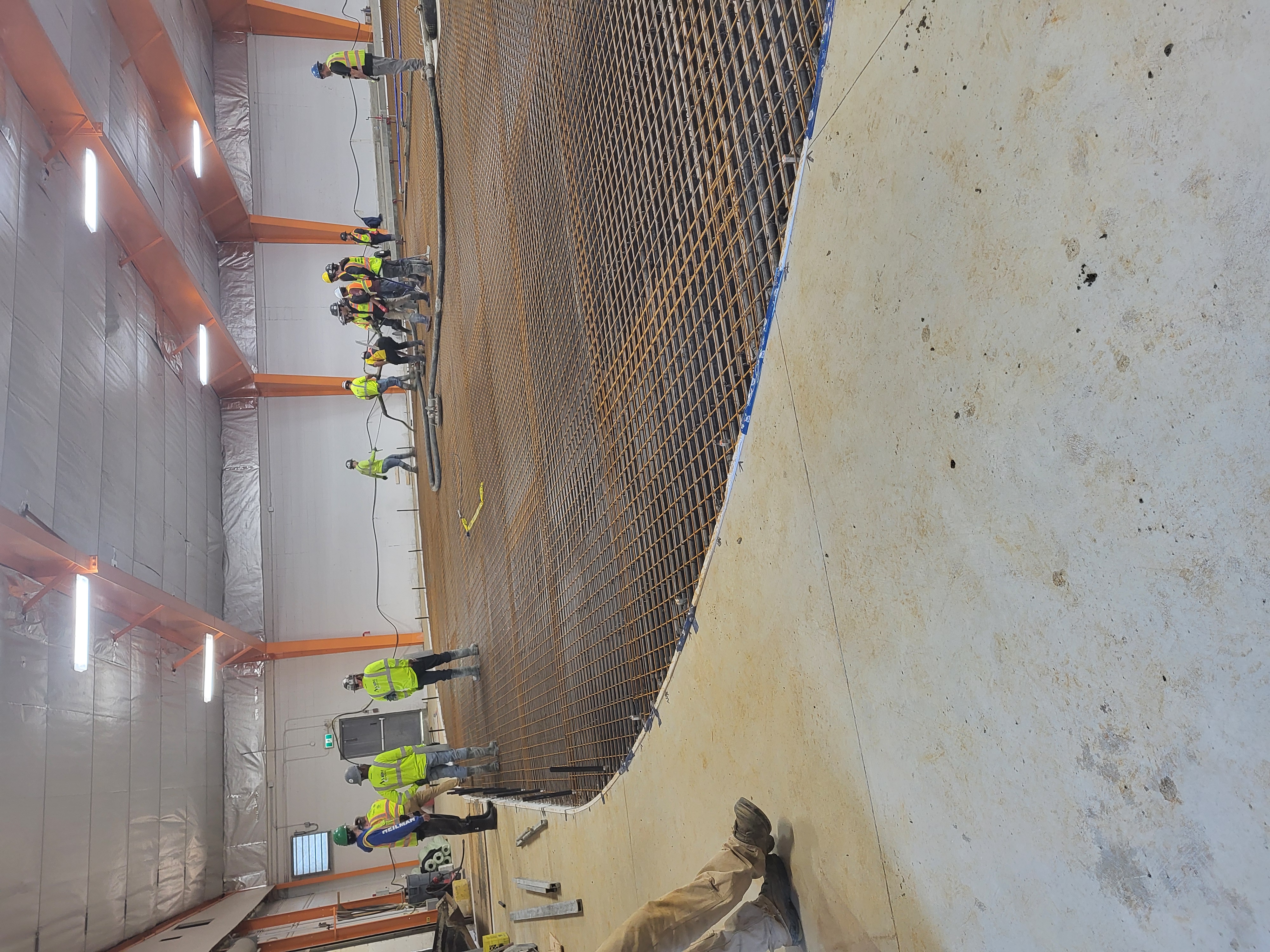

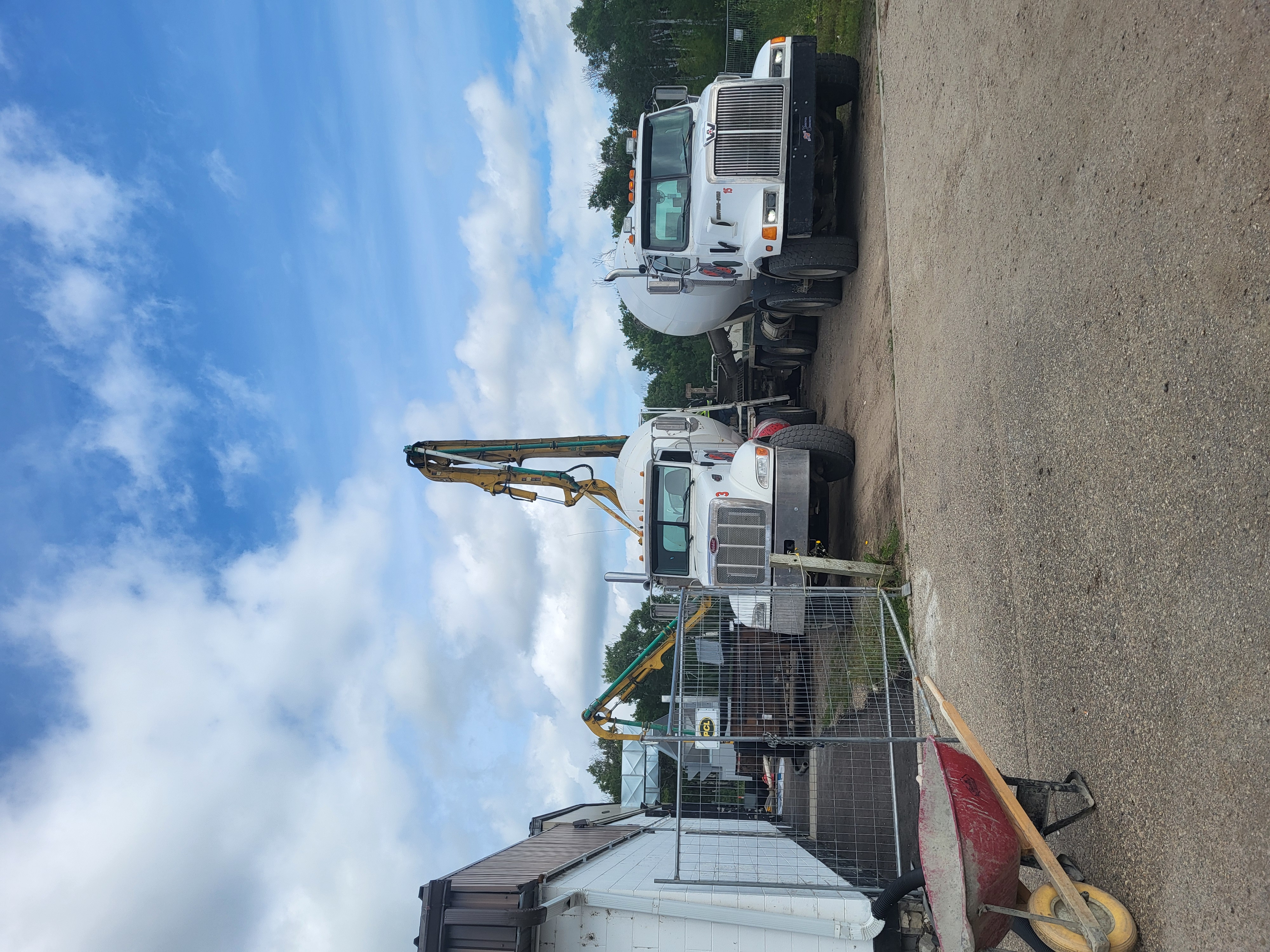

    • The concrete pour is scheduled for August 12, and is expected to take approximately 10 to 12 hours to complete.
    • Following the pour, the slab will undergo a 28-day curing period before the next phase of work begins, however other work will continue to progress while we wait.

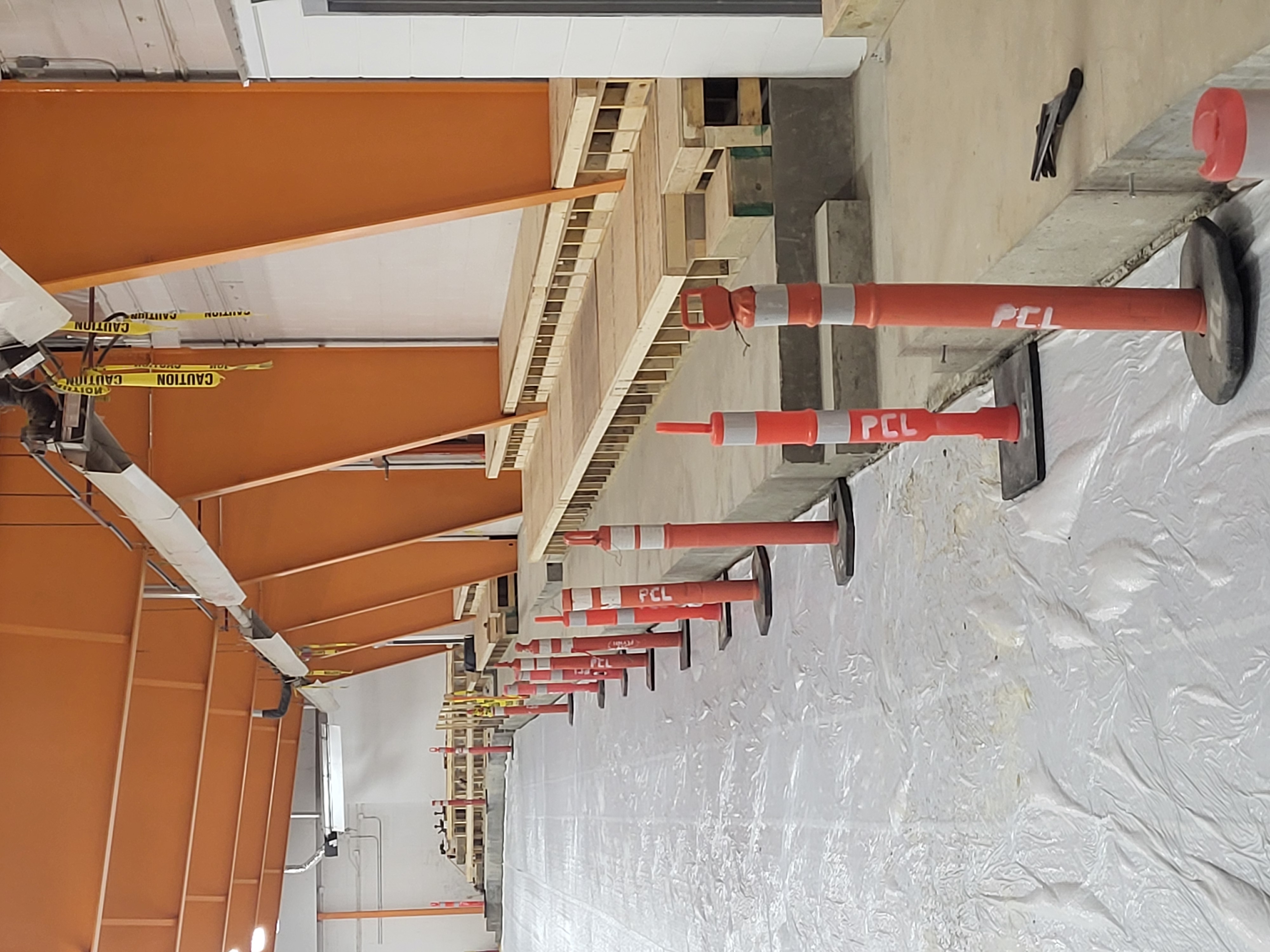

  • Cold Floor Piping and Rebar Work

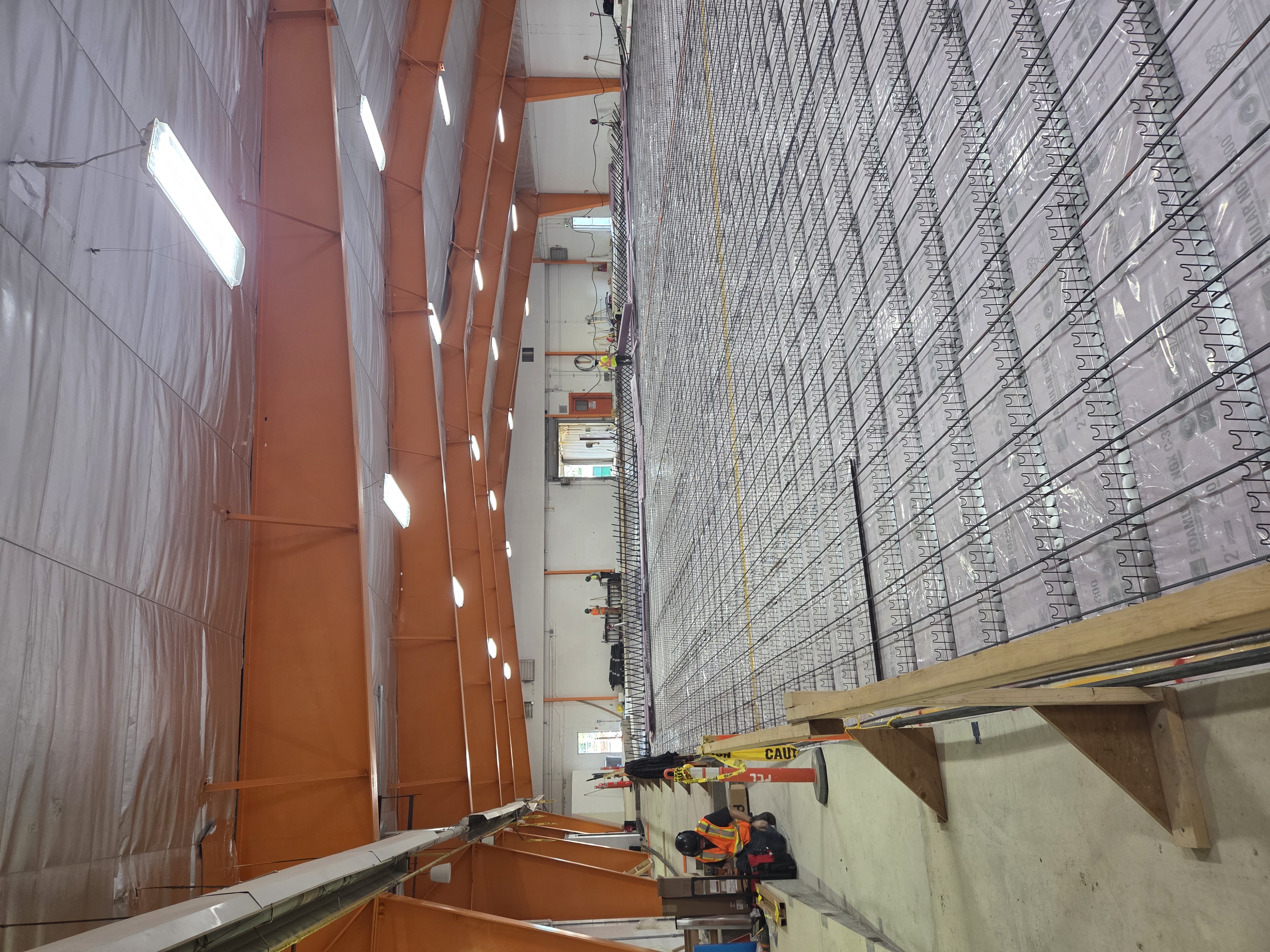

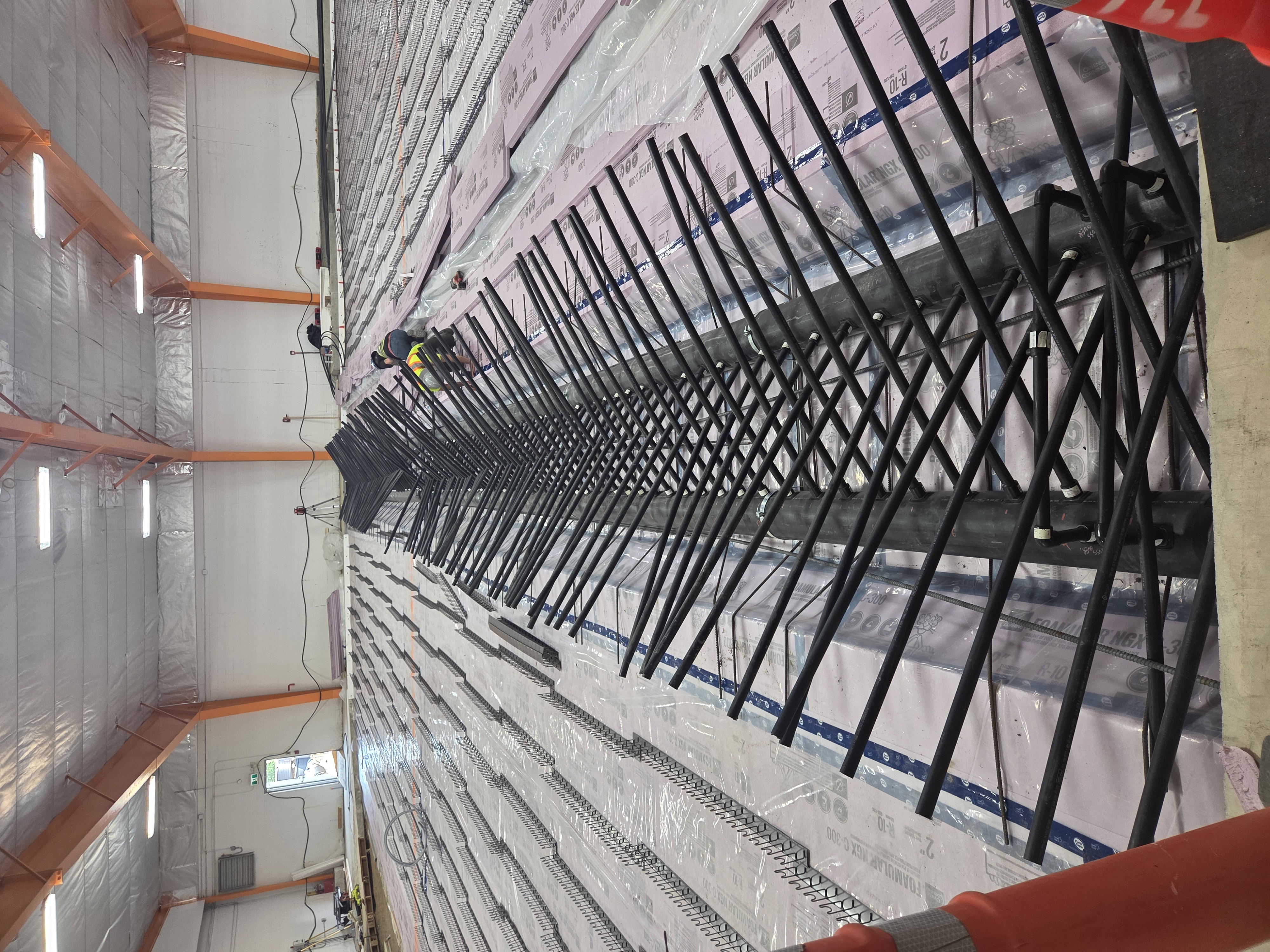

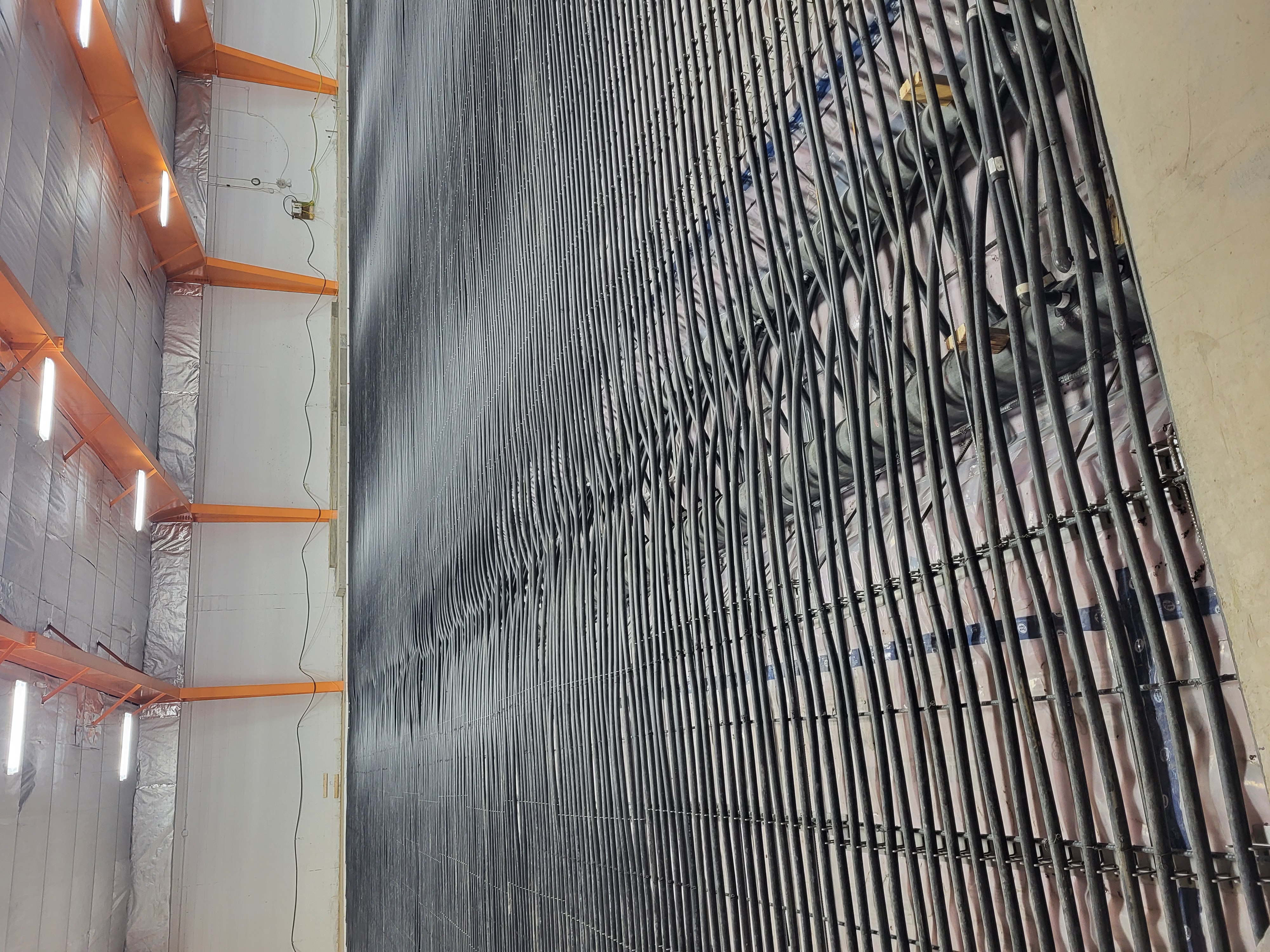

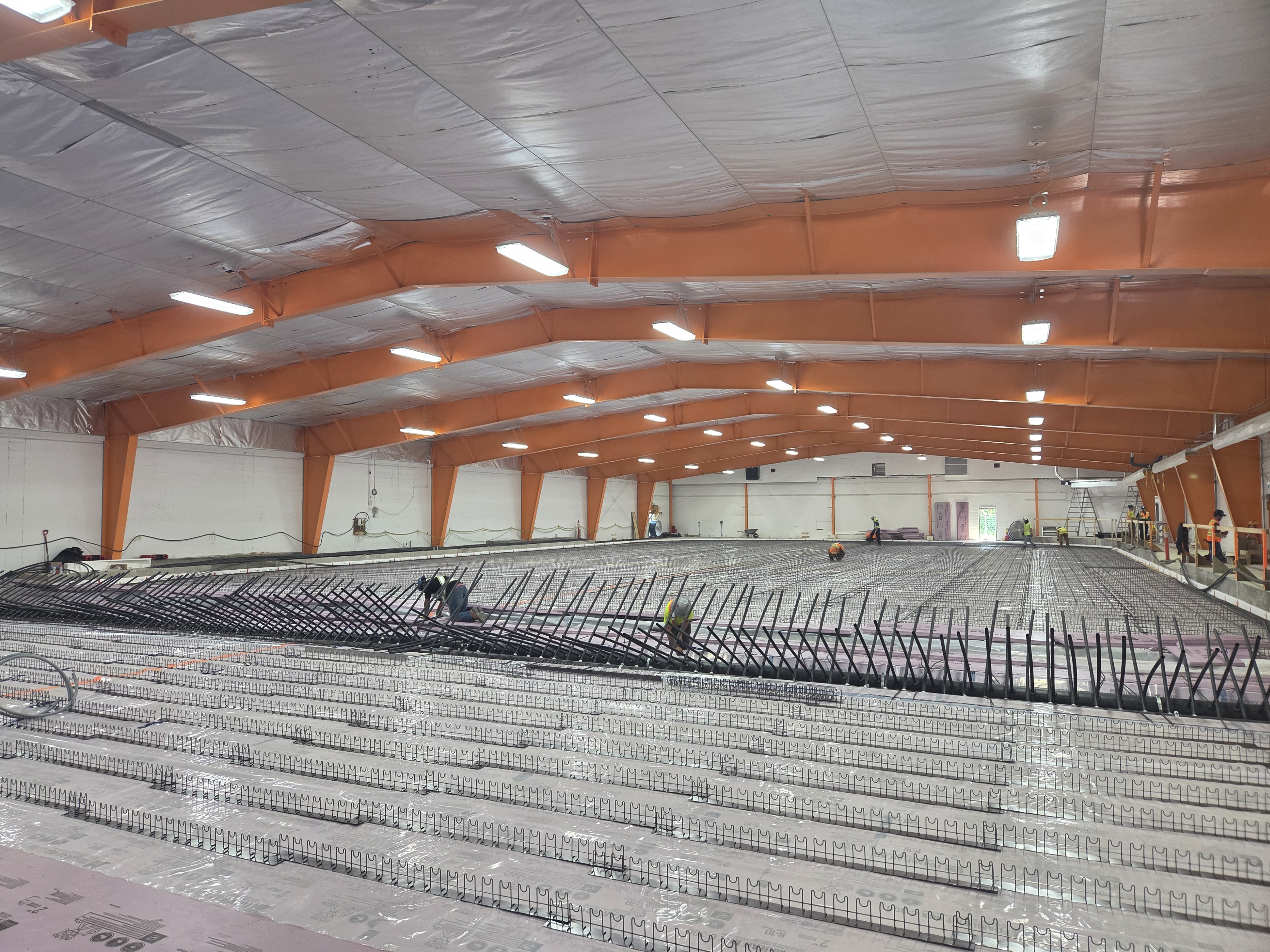

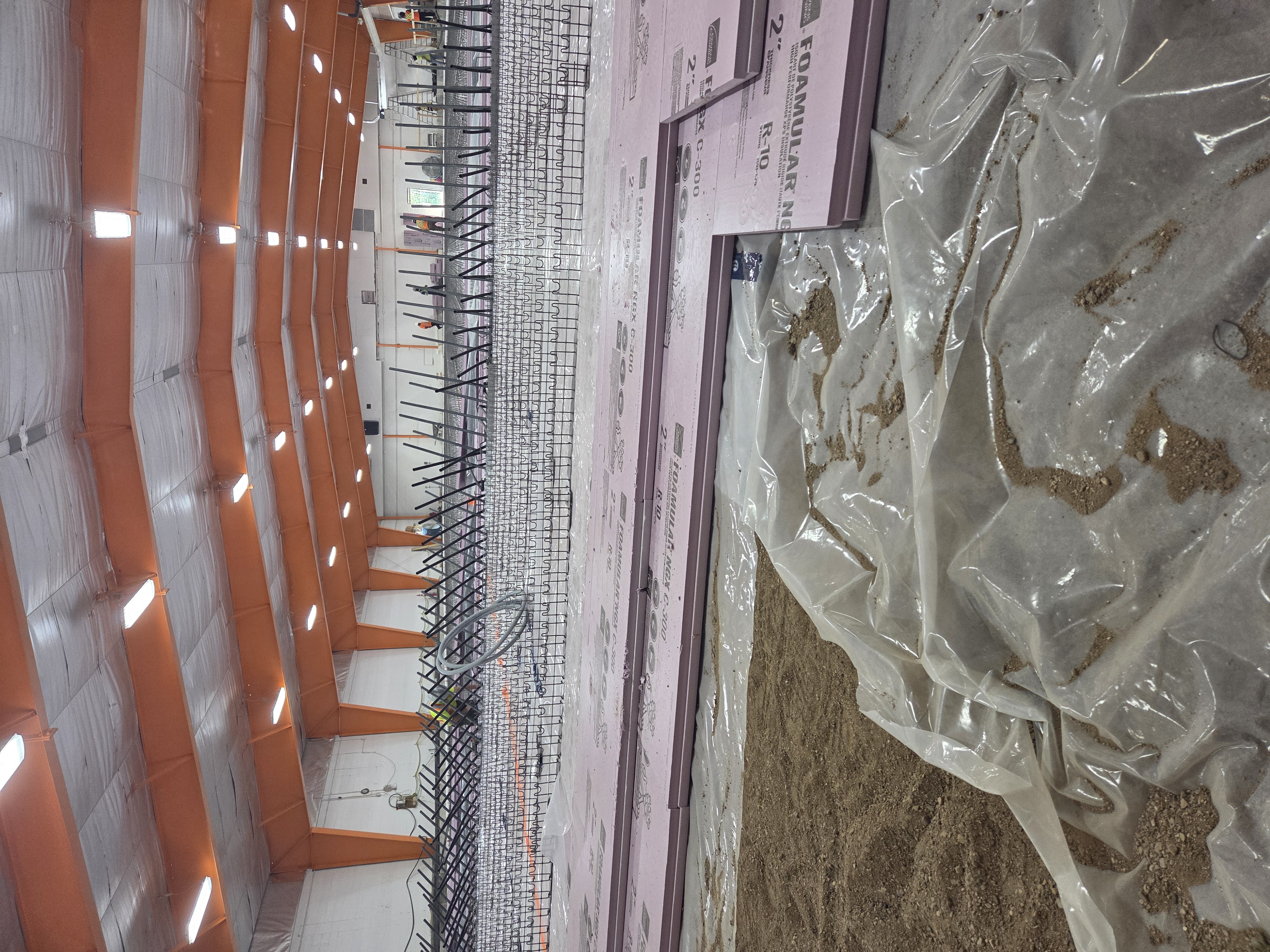

    The final stages of floor preparation are under way, as we get closer and closer to pouring the new arena slab. The sand bed over the warm floor piping has been installed, along with ground poly covering and cold floor insulation. Currently, rebar is being laid out over the floor, with the cold floor piping to follow. Once these items are completed the project will shift to prepping and pouring concrete for the arena floor.

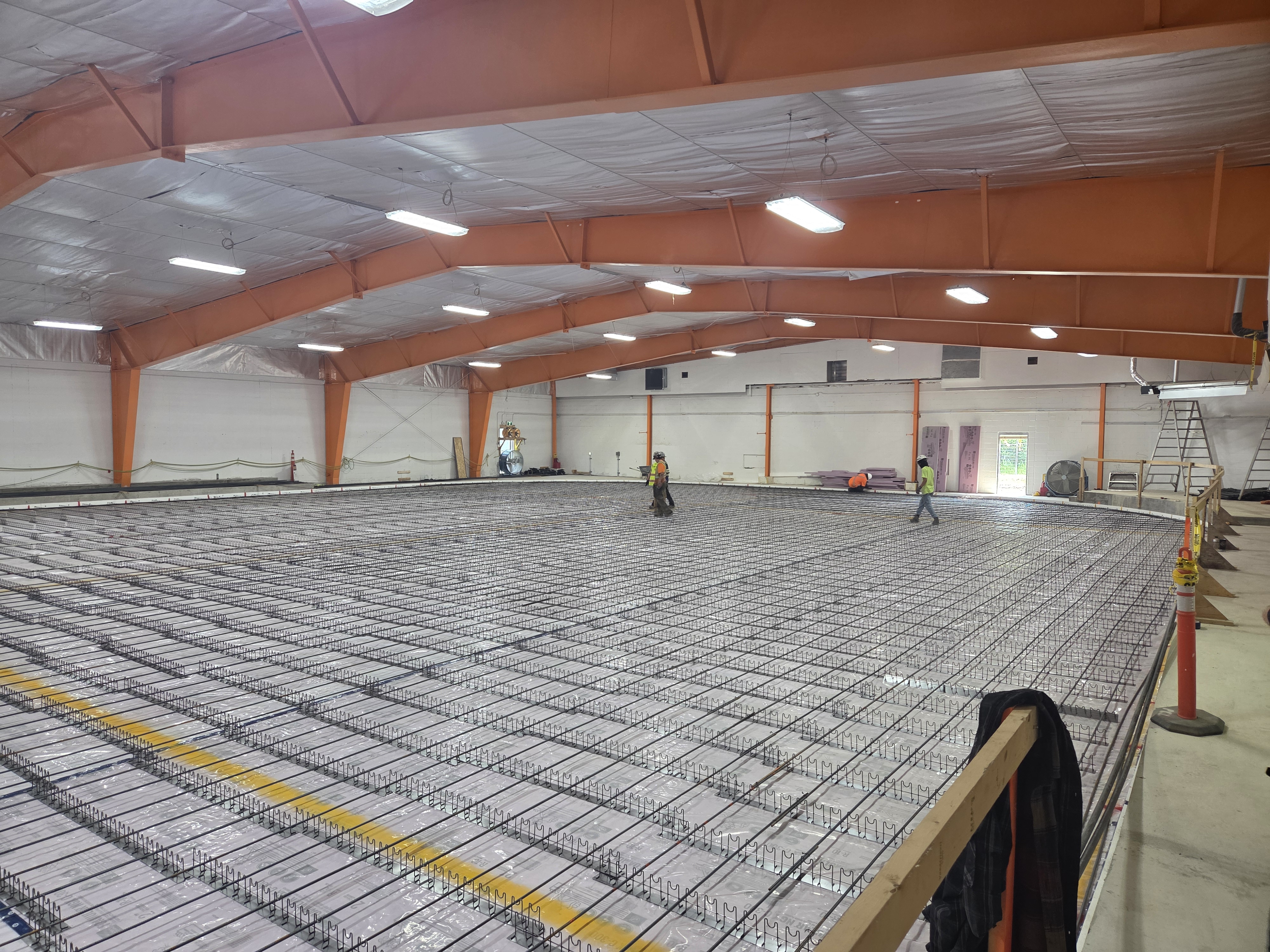

  • Progress Continues

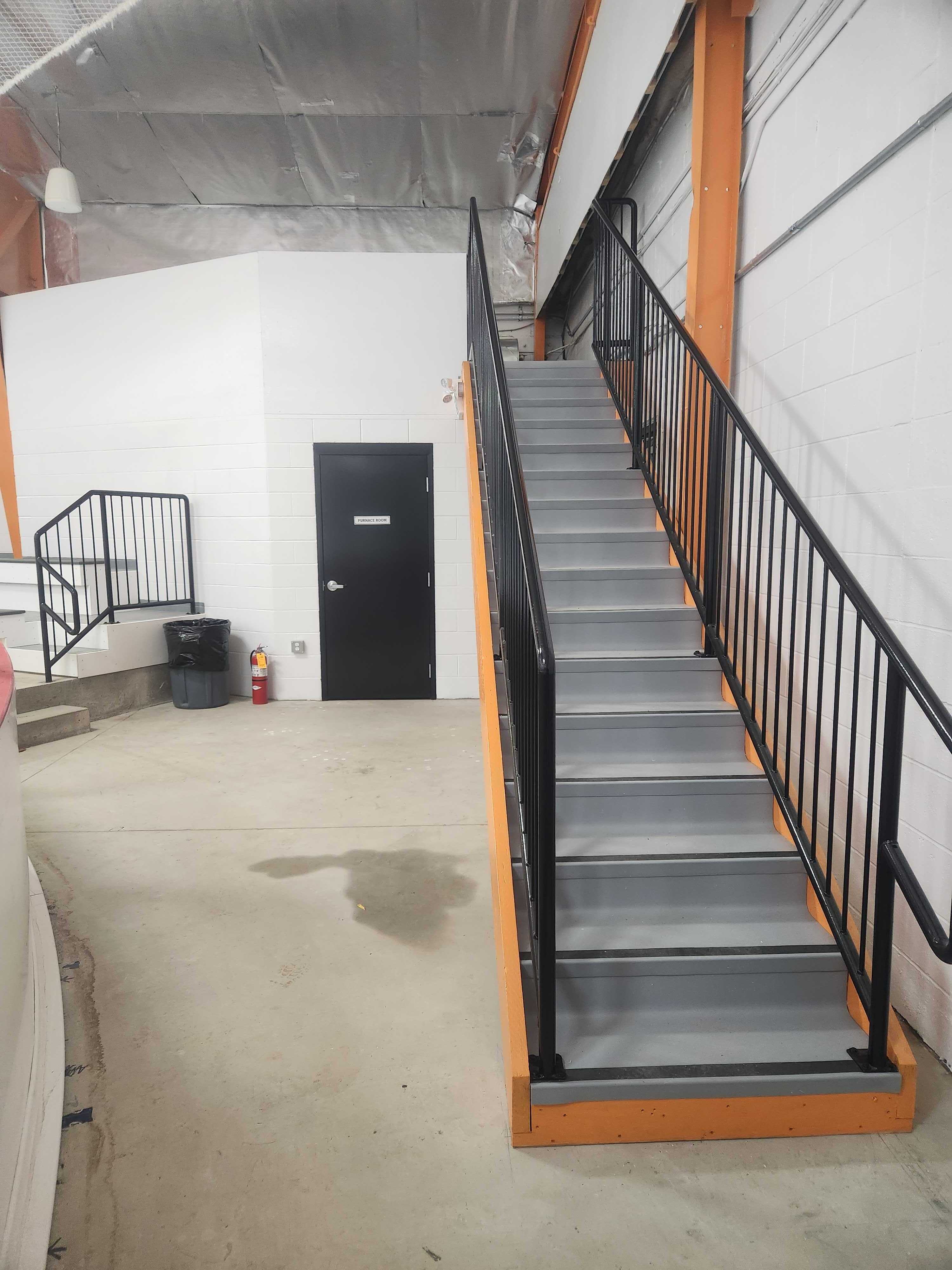

    Lots of headway has been made over the past few days at the Kinsmen Arena! Warm floor pipes and been installed and are now being covered with a sand bed, block work is complete around new entry and exit doors, and the installation of the new sound system has started. We're very excited to see the progress coming along day by day!

  • Sand Base, Header Piping, and Block Walls

    Last week the sand base was installed, and work started on the concrete blocks which form the new doors into the arena area. By the end of the week, installation of the headers for the floor piping were installed, and block walls were nearing completion. This work marks significant headway on the project as we get closer and closer to pouring the new concrete arena floor.

  • Foundations Set, Next Phase Begins

    Walking and seating concrete surfaces have been completed, and block wall construction to add doors is scheduled to begin soon. Tie bars are currently being re-installed, with the final 6 inches of compacted gravel expected to be placed by the end of the week. Next week, crews will work to install the compacted sand bed followed by the warm floor piping system. Once the warm floor installation is complete, the cold floor will be installed as the next critical step toward creating the ice surface. While several key phases remain before the arena can be ice-ready, these developments mark steady progress in the project timeline.

  • Taking Shape!

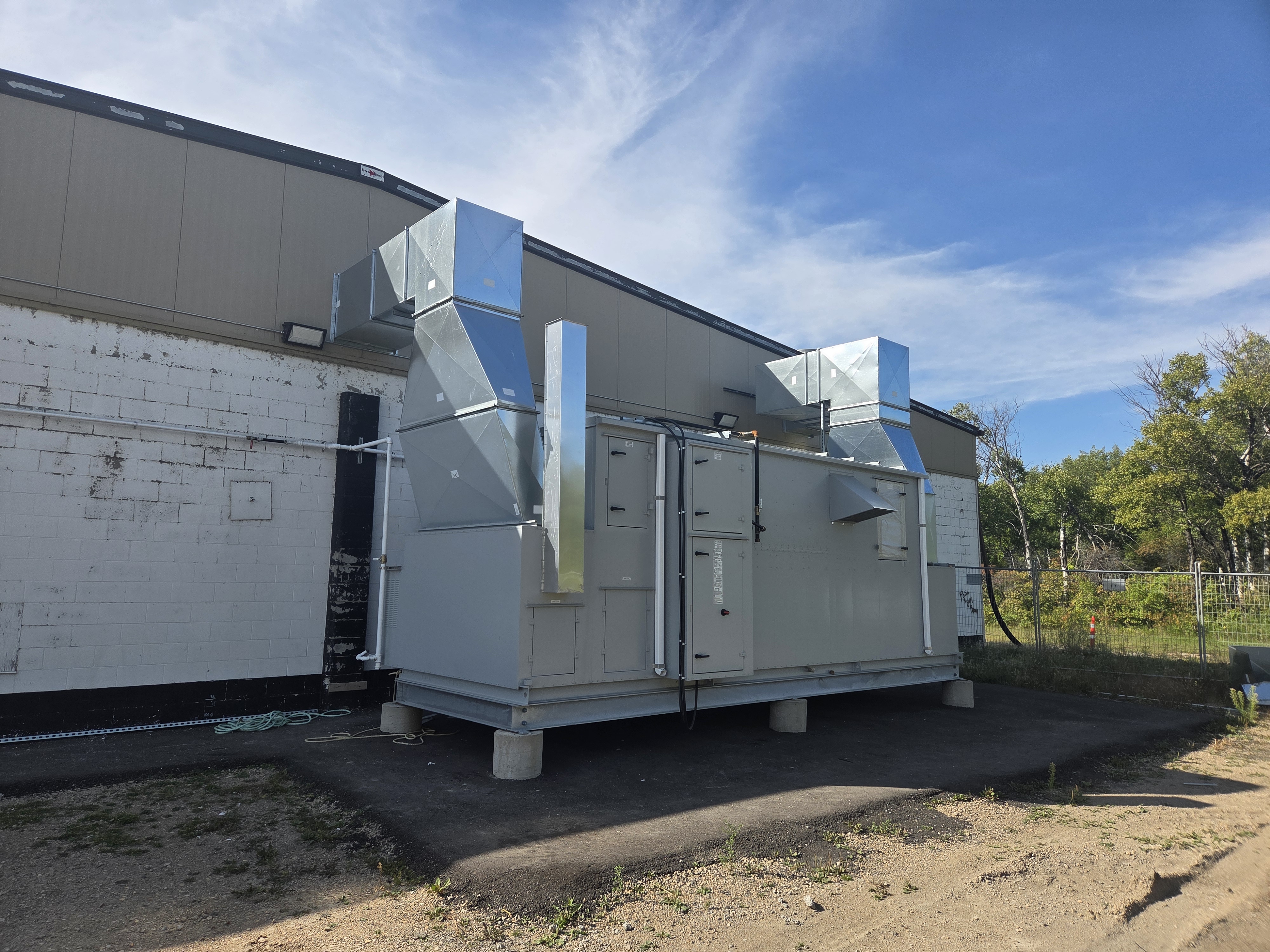

    The perimeter slab is taking shape as concrete pouring continues. Some rounded corners have been poured this week, with the other side prepped and ready for forming. In addition to the concrete work, the new dehumidifier arrived, and was placed on the asphalt pad and support columns on the east side of the arena.
